Project record

San Francisco Pier 80 mooring and berthing improvements

Participation
Not assessed
Project facts checked

The San Francisco Port Commission adopted Resolution 25-25 on 13 May 2025, authorizing award of Contract 2871 to Manson Construction Co. for USD 5,518,500 plus a USD 551,850 contingency; the cited official record does not confirm the planned notice to proceed, physical progress, substantial completion or acceptance

Project sources

The Port of San Francisco selected Manson Construction Co. for Contract 2871, a USD 5,518,500 package to replace Pier 80's deteriorated makeshift fendering, remove timber fender piles, install new fenders and hardware, add mooring bollards and repair existing bollards. Resolution 25-25 also authorized a 10% contingency, taking total authority to USD 6,070,350. The award memorandum planned notice to proceed in August 2025 and substantial completion in August 2026, but those are baseline milestones: no cited official source confirms mobilisation, installed quantities, completion or acceptance.

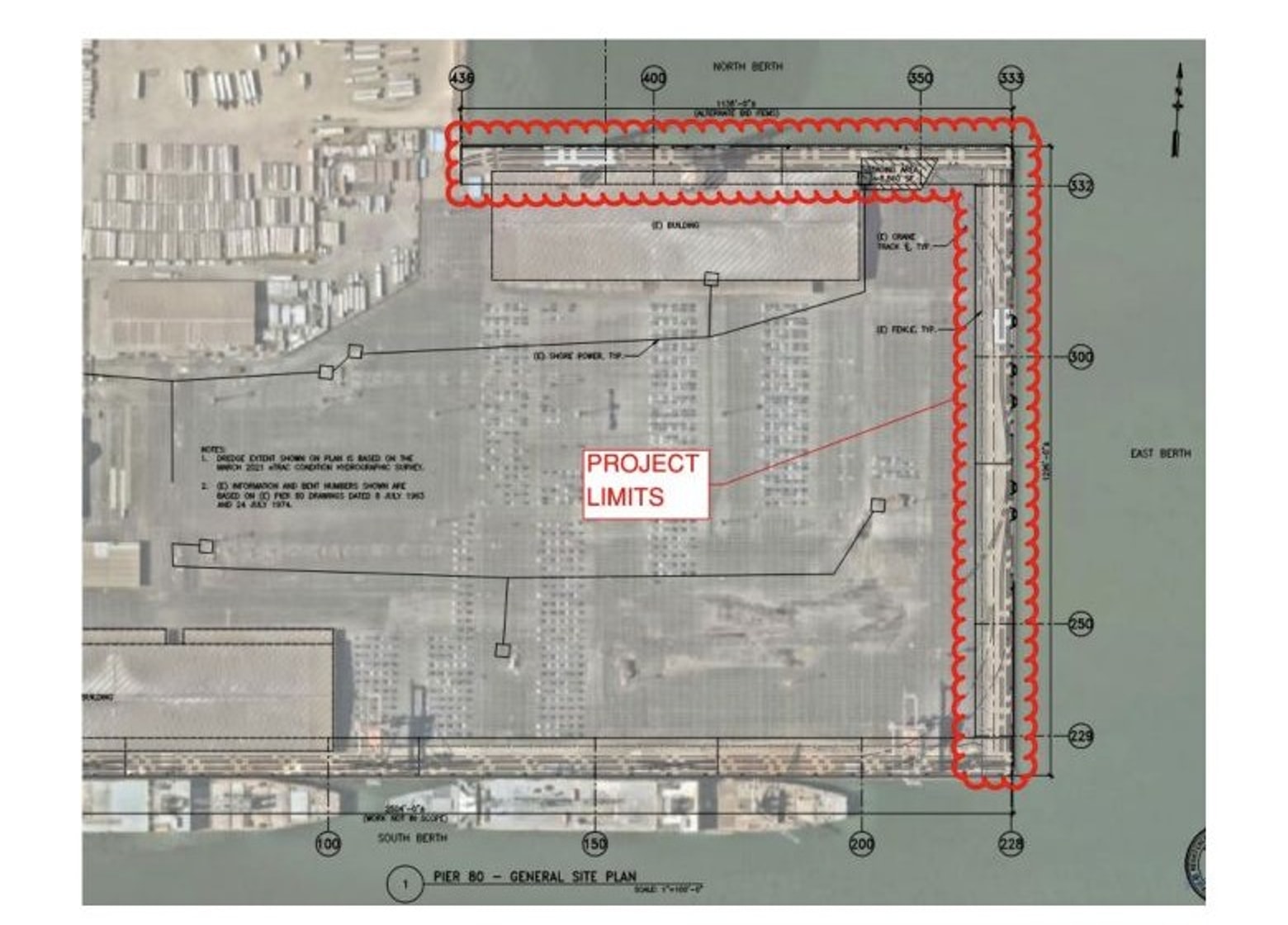

Official Pier 80 site plan showing North Berth and East Berth mooring and fendering project limits

Port of San Francisco award memorandum; official project-limit plan

Location

United States / Americas

Segment

Wharf maintenance, fender piles and marine asset renewal

Phase

Award / Confirmed

Last checked

12 August 2026

Coverage

Related sectors

Wharf maintenance, fender piles and marine asset renewal is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Port of San Francisco
Delivery parties
Manson Construction Co. - lowest responsive and responsible bidder authorized for award, Silverado Contractors Inc. - DataSF-reported project-team allocation of USD 1,167,000; performance not confirmed, Siteco Services, Inc. - DataSF-reported project-team allocation of USD 515,000; performance not confirmed, Transpacific Steel, LLC - DataSF-reported project-team allocation of USD 123,000; performance not confirmed
Contract route
The Port Commission authorized advertisement on 17 September 2024. The Port advertised Contract 2871 on 26 March 2025 and received four bids on 14 April. Manson's USD 5,518,500 bid ranked first ahead of Vortex Marine Construction, Power Engineering Construction and The Dutra Group. Resolution 25-25 authorized award on 13 May 2025 and confirmed that Manson met the 10% local-business participation goal.
Execution window
The award memorandum set a 365-consecutive-day duration from notice to proceed, with an August 2025 notice-to-proceed target and August 2026 substantial-completion target. Timber-pile removal was restricted to the June-November in-water work window. These dates are the award-stage baseline, not evidence that the notice to proceed was issued or that construction reached completion.
Works package
Remove the deteriorated pier-deck fendering and dilapidated timber fender piles; install a new fendering system, reaction structures and associated hardware; add mooring bollards at selected locations; and repair existing bollards. Bid documents also identify 29 supplied fenders including two spares, with 15 fenders and reaction walls on the East Berth, but final installed quantities remain unverified.
Marine interfaces
Pier 80 is an operating southern-waterfront terminal serving roll-on/roll-off and cargo vessels. The works are intended to accommodate a wider range of cargo ships and larger ocean-going cruise vessels. Delivery must be sequenced around tenant operations, and removal of timber piles from San Francisco Bay is subject to the regulated June-November in-water window.
Commercial evidence boundary
The confirmed award authorization is USD 5,518,500, with a separate USD 551,850 contingency and USD 6,070,350 total authority. CalSTA's Port and Freight Infrastructure Program supplies 80% and the Port Harbor Fund 20%. DataSF reports USD 1,805,000 of project-team allocations across Silverado, Siteco and Transpacific Steel, but those rows do not prove subcontract execution, payment or performance, and their linked prime-row amount does not supersede the Commission-authorized award.

Contract and delivery chain

Work packages and named roles

Published scope, named parties and supporting evidence for each workstream.

Prime award

Port of San Francisco Contract 2871

Named party
Manson Construction Co.
Evidence status
Confirmed
Source position
Resolution 25-25 authorizes award to Manson for USD 5,518,500 and a separate 10% contingency. Source
Fendering and mooring

Pier 80 North and East Berths

Named party
Manson Construction Co.
Evidence status
Confirmed
Source position
The award memorandum defines removal of deteriorated fenders and timber piles, installation of new fenders and hardware, new bollards and repairs to existing bollards. Source
Reported lower-tier allocations

Partial bid items 1-4

Named party
Silverado Contractors Inc.; Siteco Services, Inc.; Transpacific Steel, LLC
Evidence status
Reported
Source position
DataSF lists allocations of USD 1,167,000, USD 515,000 and USD 123,000 respectively; the ledger does not establish execution, payment or performance. Source
Funding

Construction and contingency

Named party
California State Transportation Agency and Port of San Francisco
Evidence status
Confirmed
Source position
The award memorandum allocates USD 4,856,280 from the CalSTA PFIP grant and USD 1,214,070 from the Port Harbor Fund. Source
Physical delivery

Mobilisation, installation, completion and acceptance

Named party
Port of San Francisco and Manson Construction Co.
Evidence status
Not evidenced
Source position
The cited official sources provide an award-stage programme but no notice to proceed, site-progress record, installed quantities, completion certificate or acceptance.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Port Commission authorized award to Manson

Resolution 25-25 fixed the prime award at USD 5,518,500, authorized a USD 551,850 contingency and allowed the Executive Director to accept the work once complete.

Source

Four bids were received

Manson ranked first at USD 5,518,500, ahead of Vortex Marine Construction, Power Engineering Construction and The Dutra Group.

Source

Port Commission authorized competitive bidding

Resolution 24-38 authorized competitive bidding for the fendering and mooring package, establishing the procurement route before the March 2025 advertisement.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Executed Contract 2871 and notice to proceed
  • Manson mobilisation and tenant-access sequence
  • Fender fabrication, reaction walls and 29-unit supply boundary
  • June-November timber-pile removal window
  • New and repaired bollard quantities
  • Silverado, Siteco and Transpacific Steel lower-tier performance
  • Change orders against the USD 551,850 contingency
  • Substantial completion, acceptance and final account

Reporting status

Project phase
Award
Evidence confidence
Confirmed
Last checked
12 August 2026
Cited sources
5

Sources and related records

Project changes Methodology Email a correction Project tracker

Project sources 5
