Project record

Valencia North Terminal quay and automated terminal works

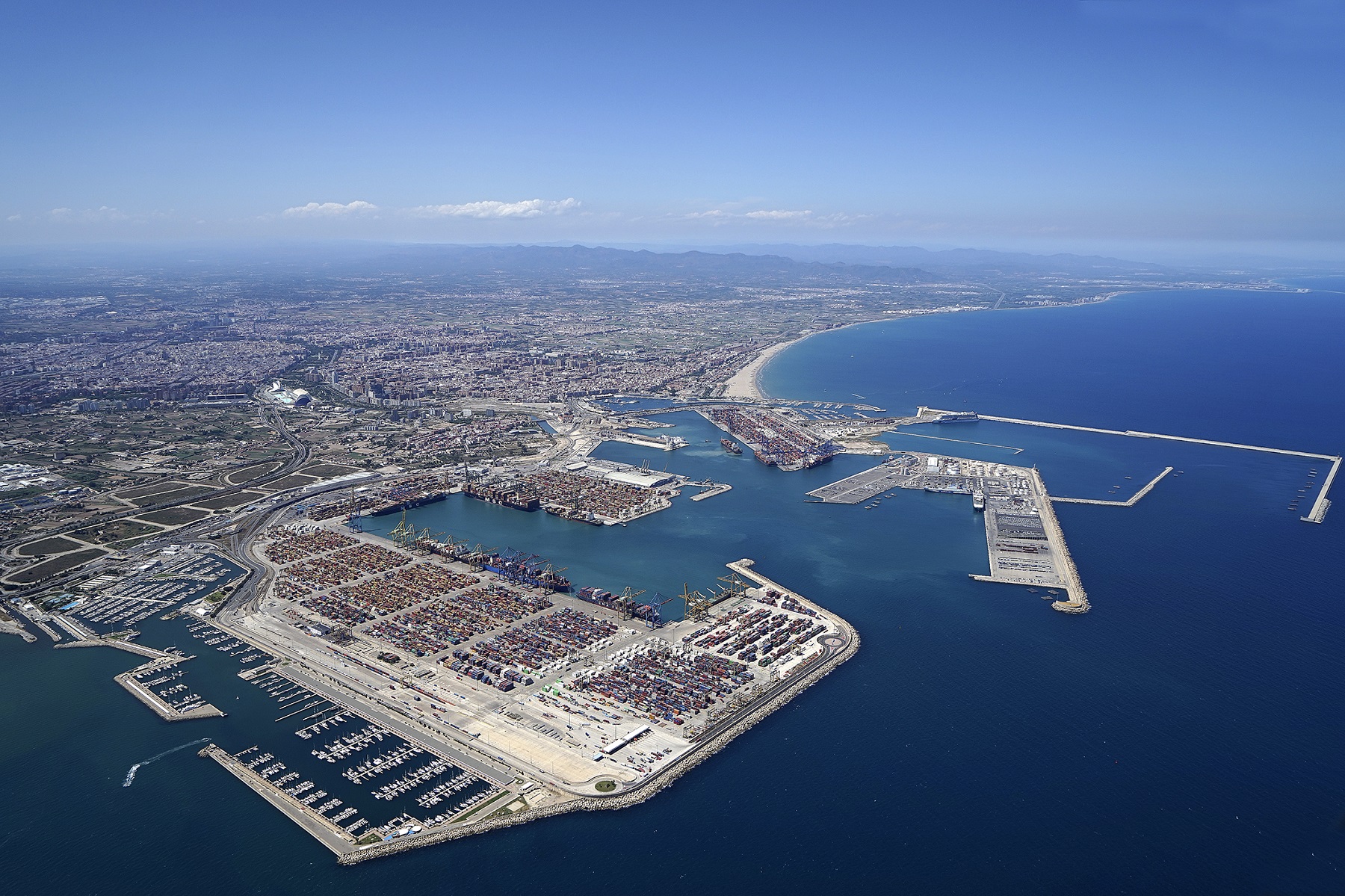

Official aerial view of the Port of Valencia showing the enclosed North Terminal expansion basin

Valenciaport

Valencia's North Terminal has moved from design publication and open procurement into a EUR 489.18 million marine-civil contract. About two kilometres of main quay, ancillary quays, reclamation, basin deepening, and demolition must be accepted before TIL's separate automated-terminal systems can enter commissioning.

Project signal

Construction in Spain

Current status Main quay works under construction after the Q4 2024 start Source confidence Confirmed

Location

Spain / Europe

Segment

Port infrastructure

Status

Main quay works under construction after the Q4 2024 start / Confirmed

Last checked

16 July 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Valencia Port Authority
Delivery parties
ACCIONA Construcción, Jan De Nul, Grupo Bertolín
Contract route
Open procurement initiated in December 2023; EUR 489.18 million excluding VAT main-works contract awarded on 1 July 2024 to the ACCIONA-Jan De Nul-Grupo Bertolin joint venture; a separate 50-year TIL terminal concession followed in September 2024
Execution window
The Port Authority's 2024 annual accounts confirm physical execution began in Q4 2024; completed quay, reclamation, dredging, civil handover, terminal commissioning and first service are not stated
Works package
Approximately 2 kilometres of main quay wall, about 700 metres of ancillary quays, 137 hectares of reclamation in the EIB project definition, basin deepening, and removal of existing breakwater and cruise-terminal structures; ACCIONA separately describes 126 hectares of paved terminal areas
Marine interfaces
Quay-wall construction, dredging, reclamation using material from Valencia and Sagunto, basin works, breakwater interfaces, and terminal-platform formation
Commercial evidence boundary
The public marine-civil package is contracted and physically under way, while TIL's concession investment, terminal paving and buildings, handling equipment, automation, rail systems, utilities, commissioning, and operations remain a different delivery and acceptance chain

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Signed annual accounts confirmed a Q4 2024 physical start

The Port Authority's reformulated 2024 accounts confirm that the awarded works began executing in the final quarter of 2024 and describe the pace as adequate. Physical construction had started, while quay, dredging, reclamation, demolition, civil handover, terminal systems and operations remained incomplete.

Source

TIL received a separate 50-year terminal concession

The concession assigns TIL construction and operation of the future terminal and records EUR 1.098237 billion of proposed private investment outside Port Authority works. The private-investment figure is separate from the EUR 489.18 million marine-civil contract and provides no evidence of installed automation or operating readiness.

Source

Port Authority awarded the main works contract

The Board selected the ACCIONA-Jan De Nul-Grupo Bertolin joint venture. The Port Authority's annual accounts later state EUR 489.18 million excluding VAT; the award fixes contractor and value, while mobilisation, production, accepted depth and handover remain open.

Source

Open tender closed with four bids

Four submissions moved the container-quay procurement into evaluation. Bid receipt did not establish a selected contractor, contract value, concession award, or physical start.

Source

Board initiated the main-works procurement

The Port Authority approved an open procedure and EUR 545.78 million excluding VAT of expenditure. This procurement ceiling is distinct from the later EUR 489.18 million award and from TIL's private concession investment.

Source

Port Authority published the pre-tender construction project

The then non-final design carried an estimated EUR 448 million including VAT and 58-month period, plus technical prescriptions for caissons, consolidation, dredged-material characterization, and operability. Those planning figures were superseded by the later procurement and award evidence.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Main and ancillary quay-wall production and structural acceptance
  • Reclamation volume, dredged-material use, settlement, and platform handover
  • Basin-deepening quantities, material route, and completion hydrography
  • Breakwater and cruise-terminal demolition interfaces
  • Terminal concession, equipment, automation, utilities, and integrated commissioning
  • First accepted vessel calls and repeat commercial operations

Reporting status

Construction, confirmed confidence

Last checked 16 July 2026 across 8 cited sources. The dated timeline above carries the project events.

Last checked 16 July 2026 Cited sources 8
