Markets

Akita offshore wind puts base-port readiness on the installation critical path

Published 13 July 2026 Updated 15 August 2026 Publisher IMWO Section Markets

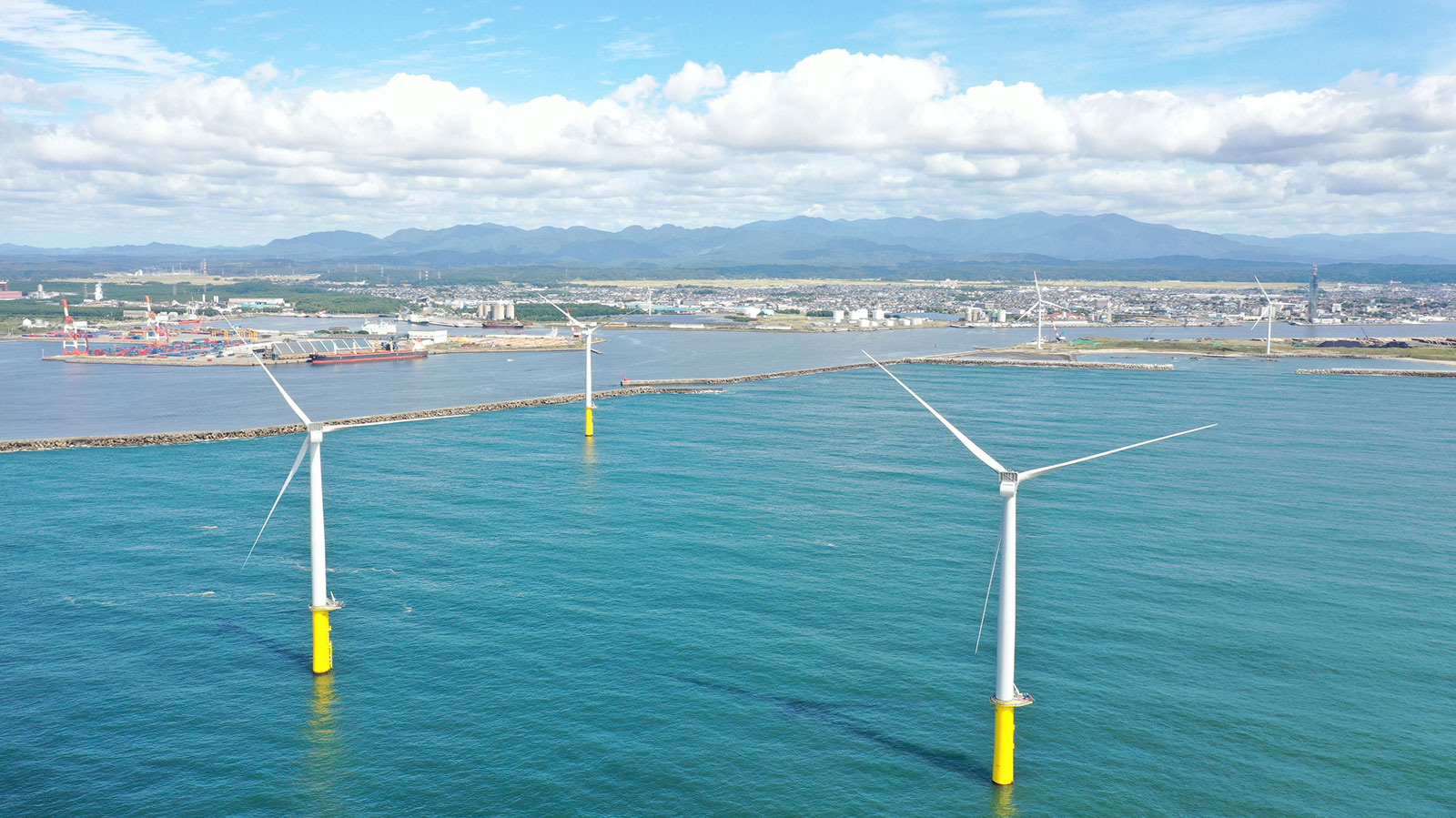

Existing offshore wind turbines, breakwaters, and working waterfront at Akita Port, the base port for the new Oga-Katagami-Akita project

Akita Offshore Wind Corporation

Akita Port now has direct field evidence of heavy-component logistics for the 315 MW Oga-Katagami-Akita project: a 2,500-tonne crawler crane, multi-axle transporters, named handling contractors and a defined delivery and storage area. Component arrival, offshore mobilisation and navigation controls remain open before the June 2028 operating target.

The delivery package is wider than the vessel charter

The developer's published programme covers 21 Vestas V236-15MW turbines with 315 MW total capacity and a 30 June 2028 commercial-operation target. Its schedule joins base-port use, foundation installation, submarine cable laying, turbine installation, testing, commissioning, and onshore transmission works. That sequence makes the port, offshore plant, design approvals, and electrical interfaces parts of the same production system.

The installation vessel is important but it is one link in that system. Penta-Ocean says Japan Offshore Marine, its joint venture with DEME Offshore, chartered the 1,600-tonne-lift Sea Challenger for turbine installation. DEME's release adds engineering work and transport-and-installation responsibility. The charter confirms a specific vessel interface, but not full installation readiness.

Akita Port is a production interface

The developer signed a base-port development contract with Sawakigumi in April 2025 and a wharf lease agreement with Akita Prefecture and the Tohoku Regional Development Bureau in May 2025. The lease gives the project access to Akita Port under the Ports and Harbours Act, while preparatory construction is intended to support offshore work beginning in 2027.

JERA's February 2026 project update says onshore transmission and base-port development were active, base-port construction was expected to continue until the following summer, and major offshore equipment would begin arriving from overseas in the second half of the next fiscal year. This turns port readiness into a measurable logistics milestone: berth availability, heavy-component handling, storage, loadout, delivery windows, and offshore sequence must align before the installation vessel can work productively.

Field evidence now goes beyond the published schedule. At a 28 May site briefing, the developer identified Kamigumi and Denzai as the contractors for unloading turbine components and pre-assembling towers, with Denzai's 2,500-tonne crawler crane installed at Iijima Wharf. A 3 July site visit also showed multi-axle transporters and the planned component delivery and storage area. The equipment confirms that heavy-component handling is being established at the base port. Component arrival, completed berth works, accepted ground capacity and a released offshore installation sequence remain unverified in the cited records.

The developer also convened its first Navigation Safety Committee on 30 June 2026 to discuss the construction plan, use of the project and surrounding waters, related ports and fishing harbours, marine traffic, and navigation safety with academic, maritime, fisheries, and government participants. That meeting proves the marine-safety interface is active. The notice publishes no approved traffic controls, exclusion zones, work windows, notices to mariners, or final permit conditions.

Certification has become a marine schedule input

On 30 June 2026 the project received conformity certification against Japanese technical standards, after earlier compliance certification under the Ports and Harbours Act. The developer identifies Kajima with Kobori Research Complex and COWI on monopile foundation design, Vestas and MHI Vestas Japan on turbine and tower design, and Arup Japan as owner's engineer support.

The certification affects the work programme directly. A 15 MW-class turbine, monopile support structure, seismic design basis, port-standard compliance, and integrated load analysis all affect fabrication release, foundation readiness, component delivery, port handling, and installation tolerances. Certification progress belongs beside port works and vessel mobilisation, not on a separate administrative track.

Base-port demand extends beyond civil work

Akita becomes executable only as its contracts converge. The base port needs a defined lease and development package, the foundation and turbine designs must clear the applicable standards, the installation vessel needs a named role, and the cable and onshore systems need visible delivery paths.

Berth depth alone does not make an offshore-wind base. Heavy-lift capacity, component geometry, temporary storage, assembly areas, access control, marine coordination, and predictable handover dates determine whether a port can support installation. Those interfaces create demand for lifting and transport engineering, temporary works, surveys, navigation safety, cable support, monitoring, and port-side production services.

Port readiness needs field evidence

The crawler crane, transporters and identified logistics contractors establish a real port-side production capability. The next evidence is completion and acceptance of the preparation works, arrival and storage of foundations and turbine components, foundation and submarine-cable mobilisation, Sea Challenger's installation window, and published navigation-safety controls.

June 2028 remains the commercial-operation date. In the nearer term, the schedule depends on whether port, design, component, vessel, cable, and onshore milestones stay synchronized. Their alignment is what turns the offshore-wind award into a credible installation schedule rather than a collection of individually valid announcements.
