Analysis

Africa marine works sit at different release points

Published 26 July 2026 Publisher IMWO Section Analysis

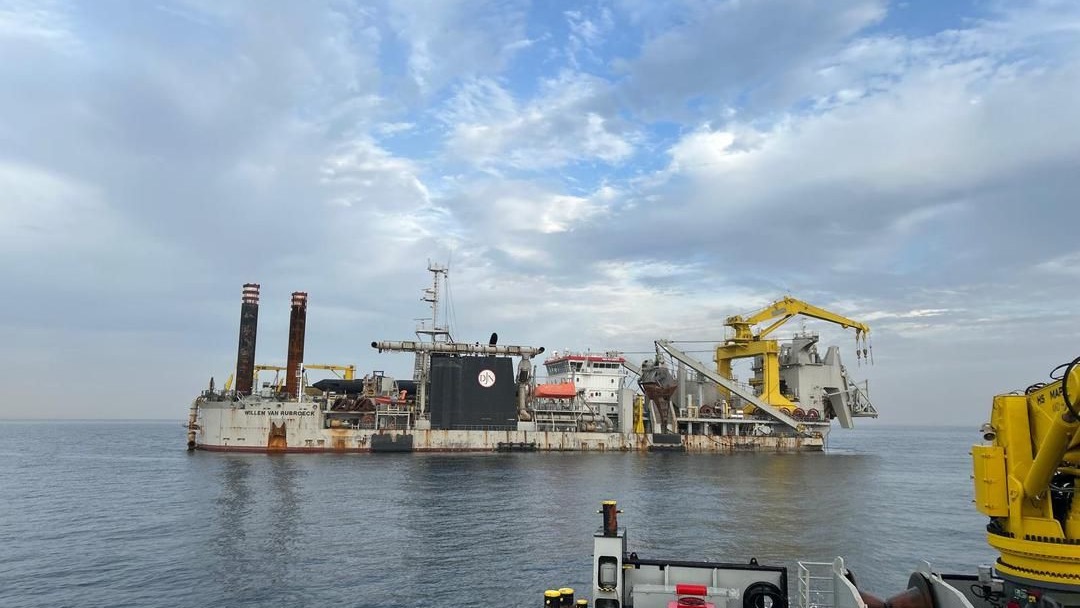

Dredger Willem Van Rubroeck working offshore at Ndayane during the start of Senegal's new deep-water port marine works

DP World, Ndayane marine works

The 17 public Africa project records currently divide into four at approval or financing, two awarded, nine in physical delivery and two in commissioning. Contractors, suppliers and operators need a different primary record at each position.

The regional set is weighted to delivery

Seventeen public project records currently cover African ports, dredging, coastal infrastructure, marine utilities and ship-repair capacity. Grouping their published project stages produces four records at approval or financing, two at award, eight in construction, one vessel in delivery and two in commissioning.

The counts are a 26 July 2026 snapshot, not a capital-spending forecast or a claim that the projects share one procurement route. At each stage, a different published record is needed before contractors, suppliers, lenders or operators can act with confidence.

Commercial evidence method

Market action by evidence state

A regional marine-works record becomes actionable when the authority, package owner, physical output, acceptance basis and operating release are visible.

  1. 01

    Programme and funding authority

    The programme record covers approval, financing, safeguards, budget allocation, the implementing entity and the current procurement plan for the named marine scope.

    Funding and authority are tied to a defined package rather than a broad policy objective.
  2. 02

    Signed package ownership

    A signed package record identifies the contracting entity, selected contractor, executed scope, contract value, securities, supervision layer and effective notice to proceed.

    Package responsibility and the route to subcontracting are visible.
  3. 03

    Mobilisation and physical production

    Delivery evidence combines plant on site, workfront release, dated quantities, material routes, interim surveys, programme changes and package-specific progress boundaries.

    Physical production is measured against the contracted scope and reporting date.
  4. 04

    Geometry and system acceptance

    Acceptance evidence covers hydrography, quay and coastal geometry, structural completion, utilities, equipment, environmental close-out, defects and accountable handover.

    Accepted marine assets can support the named vessel, cargo, utility or coastal function.
  5. 05

    Repeatable operating service

    Operating evidence covers navigation authority, pilotage, towage, security, trained operators, integrated trials, first commercial use, repeat calls and published operating constraints.

    Live service connects completed infrastructure to a repeatable operating result.

Six current positions

Project records move through different commercial releases

Madagascar, Takoradi, Tunisia, Ndayane, Nador and Damietta show how the public evidence base changes from programme formation to live port service.

Madagascar Confirmed

Madagascar Majunga, Tulear and Pangalanes transport resilience programme

Published project stage
Approved and financed programme
What the record supports
Ports and waterways have signed funding and allocated budgets, while only selected works and fleet packages appear in the current procurement plan.
Outstanding commercial record
No public record connects each budget to tender notices, signed works contracts, contractor names, notices to proceed and site mobilisation.
Ghana Confirmed

Takoradi Project Shiprite floating dock and repair yard

Published project stage
Late-stage project financing
What the record supports
The jetty, dredging, reclamation and floating-dock scope has a capital structure and concession, but named delivery contractors remain open.
Outstanding commercial record
Financial close, executed EPC packages, dock-builder appointment, dredging responsibility and a dated construction start would release the supply chain.
Tunisia Confirmed

Tunisia three-port access and dredged-material programme

Published project stage
Awarded multi-port dredging contract
What the record supports
DEME owns the staged dredging programme, and a separate procurement assigns independent guidance, monitoring and technical assistance across three material routes.
Outstanding commercial record
Notice to proceed, containment-dike completion, plant mobilisation, port-by-port quantities, disposal receipts and accepted hydrography remain the delivery proofs.
Senegal Confirmed

Port of Ndayane Deep-water Port and Container Terminal

Published project stage
Active marine and terminal construction
What the record supports
The access channel, dredging and reclamation are active, while quay, terminal, harbour-service and commercial-release systems advance on connected tracks.
Outstanding commercial record
Measured production, accepted channel and reclamation, quay handover, terminal commissioning, harbour readiness and recurring service remain unpublished.
Morocco Confirmed

Nador West Med Deep-water Port

Published project stage
Basic port infrastructure complete
What the record supports
Breakwaters and quays are reported complete, but terminal systems, towage, pilotage, staffing and navigation release still control operating readiness.
Outstanding commercial record
Accepted terminal systems, active harbour services, security and navigation approval, integrated trials and dated recurring commercial calls are still required.
Egypt Confirmed

Damietta Alliance Container Terminal (Tahya Misr 1)

Published project stage
Commercial service commenced
What the record supports
The first Hapag-Lloyd call connects owner-delivered marine access and quay works with concession-company terminal systems and equipment.
Outstanding commercial record
Repeat calls, berth productivity, operating restrictions, maintenance records and throughput will show whether the released capacity remains usable.

Finance establishes authority before physical mobilisation

Madagascar's signed transport programme allocates funding to Majunga, Tulear and the Pangalanes Canal, while its May procurement plan identifies only selected packages as active. Sao Tome and Principe's BEFIRM programme has financing and site-level marine scope, but the works contractor and notice to proceed remain undisclosed.

Takoradi's Shiprite project has a USD 137 million capital frame, a 200-metre jetty, rock dredging, reclamation and a floating dock. PIDG's June investment closes a funding gap and supports progress toward financial close and construction. The current public financing records leave the civil EPC, dredging contractor, dock builder and mobilisation date unidentified.

Formation-stage records become commercially actionable when the financing agreement, procurement plan, safeguards, package value, tender route and timetable point to the same scope. Until then, the opportunity is a funded intention with open package ownership.

Award records reveal package ownership and interfaces

Tunisia's merchant-port authority contracted DEME for one staged dredging programme across Sousse, Menzel-Bourguiba and Rades-La Goulette. The sequence starts with containment dikes at two ports before trailing-suction-hopper dredging, while a separate supervision procurement establishes an independent control layer.

At Snake Island in Lagos, MSC has a 45-year sub-concession and an EPC agreement with ITB Nigeria and DEME for a 910-metre quay, 30-hectare yard and initial dredging to minus 16.5 metres chart datum. The award identifies responsibility, but signed package boundaries, mobilisation and acceptance records still determine when downstream supply becomes live.

An accountable award record names the contracting entity, contractor, package value, scope, programme, securities, owner-supplied elements and notice to proceed. Those fields separate a public winner announcement from a package that can issue subcontracts, book plant and start measurable production.

Construction percentages need package-level evidence

Ndayane has an active five-kilometre access channel, about 10 million cubic metres of dredging and an 89-hectare reclaimed platform in the marine works record. Its 840-metre first-phase quay, terminal systems, harbour services and 2028 operating objective remain separate delivery and release tracks.

Cotonou Terminal 5 reports 69 percent physical progress and 72 percent overall progress on a page that still carries a 2021-2024 period. The percentages confirm incomplete construction. They do not date the 350-metre breakwater extension, 891-metre revetment, concrete armour placement, accepted geometry or handover.

Goree's coastal works show why boundaries matter. WACA reported 82 percent overall completion at 31 March 2026, while a later World Bank paper used 85 percent for protection works and 75 percent with landscaping. Scope, measurement date and accepting party must travel with every percentage.

Delivery and commissioning close different systems

CVM's ordered Easydredge 2700XL is a vessel-delivery record. Shipyard progress, trials, handover, crew support and arrival in the Democratic Republic of the Congo will close the asset package. The later Boma-Matadi channel result will depend on campaigns, hydrography, river conditions and operating performance.

Nador West Med sits in an operating-release sequence after the Royal Office reported basic port infrastructure complete. Terminal systems, towage mobilisation, pilotage, harbour control, staffing, security and the first recurring commercial services remain distinct from completed breakwaters and quays.

Damietta Alliance Container Terminals provides the later comparison. Commercial operations began on 14 February 2026, after the port authority delivered quay walls, excavation and channel and basin dredging while the concession company delivered terminal superstructure and equipment. A named first service connects the marine base to a live operating event.

The next missing record defines the opportunity

Approval and financing positions move through a procurement plan, tender and signed contract. Awards move through notice to proceed, subcontracting and plant mobilisation. Construction moves through measured quantities, accepted surveys, completed interfaces and handover. Commissioning moves through operating authority, trials, first service and repeat performance.

For each project, the missing record and accountable publisher define the present commercial boundary. Ndayane still requires production evidence; Takoradi, financing; Tunisia, a signed contract; Nador, operating readiness; and Damietta, repeat service. A regional pipeline percentage would obscure those different states.

Regional demand becomes actionable when package ownership and release evidence are visible together. The strongest signal is the document that changes who can buy, supply, build, accept or operate the marine system next.
