Nador West Med Deep-water Port

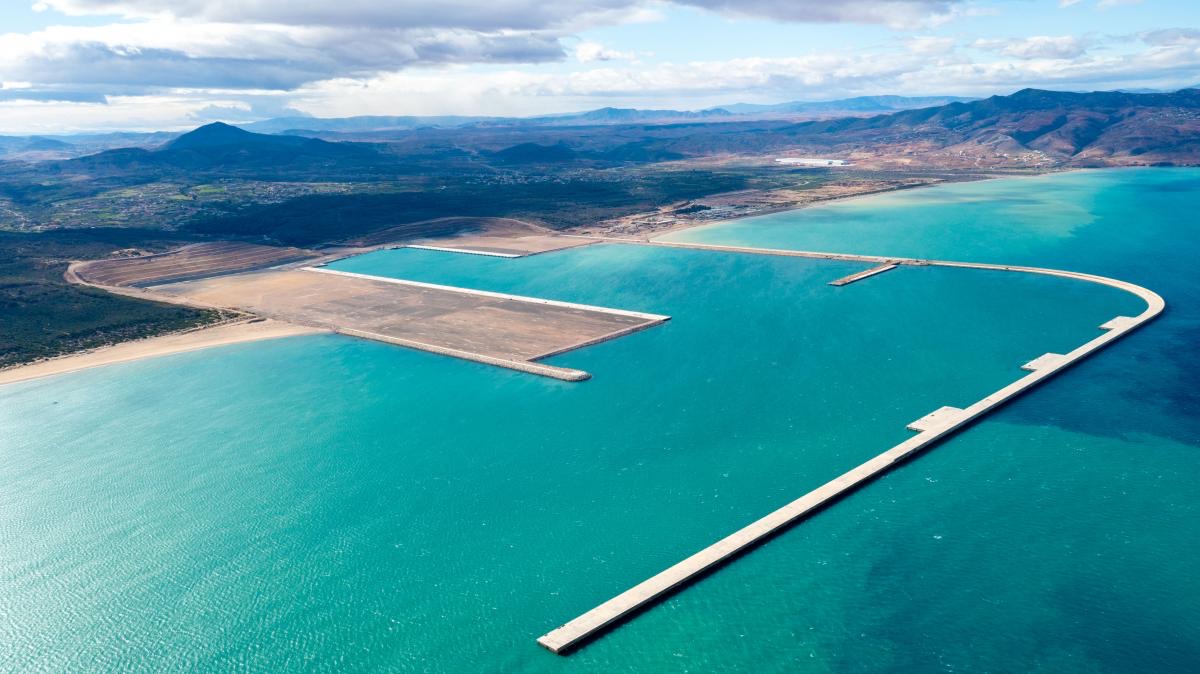

Aerial view of the Nador West Med deep-water port showing the main breakwater, protected harbour basin, and completed quay platforms

Nador West Med S.A.

Morocco has moved Nador West Med from heavy marine construction into port-opening preparations. A January 2026 Royal Office statement reports all basic port infrastructure complete, including 5.4 kilometres of breakwaters and 4 kilometres of quays, and sets an operational-launch target in the fourth quarter of 2026. Current Nador West Med procurement listings cover an access-control building and maritime-zone gantry, a main access building, and external quality control for building works; the authority is also recruiting port-flow, port-officer, and IT roles. These live activities show the operating transition is still under way. They do not change the separate Q4 2026 target for the East container terminal or the West terminal's progressive service plan from 2027.

Project signal

Commissioning in Morocco

Current status Basic port infrastructure reported complete; access-control, port-management, systems, staffing, and service preparations remain active ahead of the East terminal's Q4 2026 commissioning target, while the West terminal follows from 2027 Source confidence Confirmed

Location

Morocco / Africa

Segment

Deep-water ports and energy terminals

Status

Basic port infrastructure reported complete; access-control, port-management, systems, staffing, and service preparations remain active ahead of the East terminal's Q4 2026 commissioning target, while the West terminal follows from 2027 / Confirmed

Last checked

15 August 2026

Coverage

Related sectors

Deep-water ports and energy terminals is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Nador West Med S.A.
Delivery parties
STFA-SGTM-Jan De Nul consortium, Marsa Maroc, West Med Container Terminal (WMCT), Terminal Investment Limited (MSC), CMA Terminals, Boluda Towage France
Contract route
Nador West Med S.A. awarded the principal port-infrastructure works in 2015 to the STFA-SGTM-Jan De Nul consortium. The firm tranche covered breakwaters, east and west terminal fronts, three oil berths, a Ro-Ro and service quay, dredging, earthworks, and ground treatment at a recorded value of MAD 7.613 billion. Later operating packages are separate: Marsa Maroc and TIL hold the East container-terminal concession through WMCT; Marsa Maroc and CMA Terminals are developing the West container terminal; and Boluda Towage France with Marsa Maroc holds a 20-year towing and assistance licence. The 2015 works value is not combined with the Royal Office's 2026 total public-and-private investment figure of MAD 51 billion.
Execution window
The main infrastructure contract was awarded in 2015. The Royal Office reported the basic port infrastructure complete in January 2026 and set a fourth-quarter 2026 operational-launch target. WMCT's July 2026 financing release also schedules the first section of the East container terminal for commissioning in the fourth quarter of 2026. Nador West Med published access and control-building packages in July and an external quality-control package in August; its current recruitment page lists port-flow, port-officer, and IT roles. The West container terminal is to enter service progressively from 2027. The open notices and recruitment records show work in progress, not contract awards, completed buildings, or commercial vessel service.
Works package
The completed marine base reported in 2026 comprises 5.4 kilometres of breakwaters and 4 kilometres of quays, with container, liquid- and solid-bulk, energy, Ro-Ro, service, and general-cargo interfaces. The original first-module note described a roughly 4.2-kilometre main breakwater, a 1.2-kilometre secondary breakwater, a 1,520-metre container quay at 18 metres depth, three hydrocarbon berths at 20 metres depth, a 360-metre coal quay at 20 metres depth, a multipurpose terminal, a Ro-Ro berth, and a service quay. The current Royal statement adds a startup frame of 5 million container units and 35 million tonnes of liquid and solid bulk, plus a planned LNG and hydrocarbon hub; those operating capacities remain contingent on equipped and accepted terminals.
Marine interfaces
The transition joins breakwater and quay completion to accepted dredged depths, hydrographic controls, berth furniture and utilities, fender and mooring readiness, safe approach and manoeuvring areas, towage, pilotage, VTS, aids to navigation, port security, pollution and emergency response, terminal-equipment commissioning, and coordinated trial calls. The current access-control, main-access, quality-control, port-flow, port-officer, and IT activity also connects the marine estate to secure landside entry, customs, gate processes, digital systems, and trained harbour staff. A completed civil footprint cannot substitute for accepted performance across those interfaces.
Commercial evidence boundary
The 2026 completion statement materially reduces civil-construction uncertainty but shifts risk to interface acceptance and ramp-up. Current procurement and recruitment confirm spending and staffing demand around access, control, quality assurance, port flows, and information systems. Neither record establishes an award, a finished facility, or an opening date. The East terminal has a dated financing and commissioning path; the West terminal, general-cargo facilities, energy hub, and activity zones follow different programmes.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Access and operating-transition work remained in procurement

Current authority listings cover access-control and main-access buildings plus external quality control, while recruitment covers port-flow, port-officer, and IT roles. The records confirm active preparation without establishing package awards, completed facilities, or commercial opening.

Source

WMCT signed long-term East-terminal financing documents

The financing record strengthens the East terminal's separate fourth-quarter 2026 commissioning path; it does not prove equipped-terminal completion, harbour-service readiness, first vessel handling, or recurring throughput.

Source

EBRD grant added operating-readiness support

The grant adds institutional and operational capacity work to the launch sequence, while leaving civil acceptance, navigation services, terminal systems, trained operations, and commercial service as independent gates.

Source

Royal Office reported basic port infrastructure complete

The statement advances the marine base to reported civil completion and sets a fourth-quarter 2026 launch target; hydrographic acceptance, equipped terminals, harbour systems, trial calls, and commercial operation remain separate evidence outcomes.

Source

TIL entry into East-terminal capital completed

The ownership event confirms the East terminal concession structure and operator alignment, but it is not evidence that superstructures, equipment, terminal systems, or vessel-service readiness are complete.

Source

West-terminal operating agreement finalised

The agreement fixes a separate West terminal delivery and operating route scheduled from 2027, preventing that programme from being folded into the East terminal's 2026 launch evidence.

Source

Towage and assistance licence awarded

The award establishes the future towage counterparty and service contract, while tug delivery, licensed mobilisation, crew readiness, harbour procedures, and live vessel assistance remain to be evidenced.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Hydrographic acceptance of approach, basin, and berth depths
  • Breakwater, quay, fender, bollard, utility, and terminal handover records
  • East-terminal superstructures, STS and RTG commissioning, TOS, and gate systems
  • Tug delivery, pilotage, VTS, aids to navigation, and harbour-control readiness
  • ISPS, emergency, pollution-response, customs, and digital single-window approvals
  • Port-officer and operating-team recruitment and training
  • Awards and physical delivery for access-control, main-access, and quality-control packages
  • East terminal trial calls, first commercial vessel and progressive service notices
  • Separate West-terminal, general-cargo, LNG, and hydrocarbon-hub delivery paths

Reporting status

Commissioning, confirmed confidence

Last checked 15 August 2026 across 12 cited sources. The dated timeline above carries the project events.

Last checked 15 August 2026 Cited sources 12
