Port Procurement
Cabo Verde's two-port programme exposes two consortia and four value layers

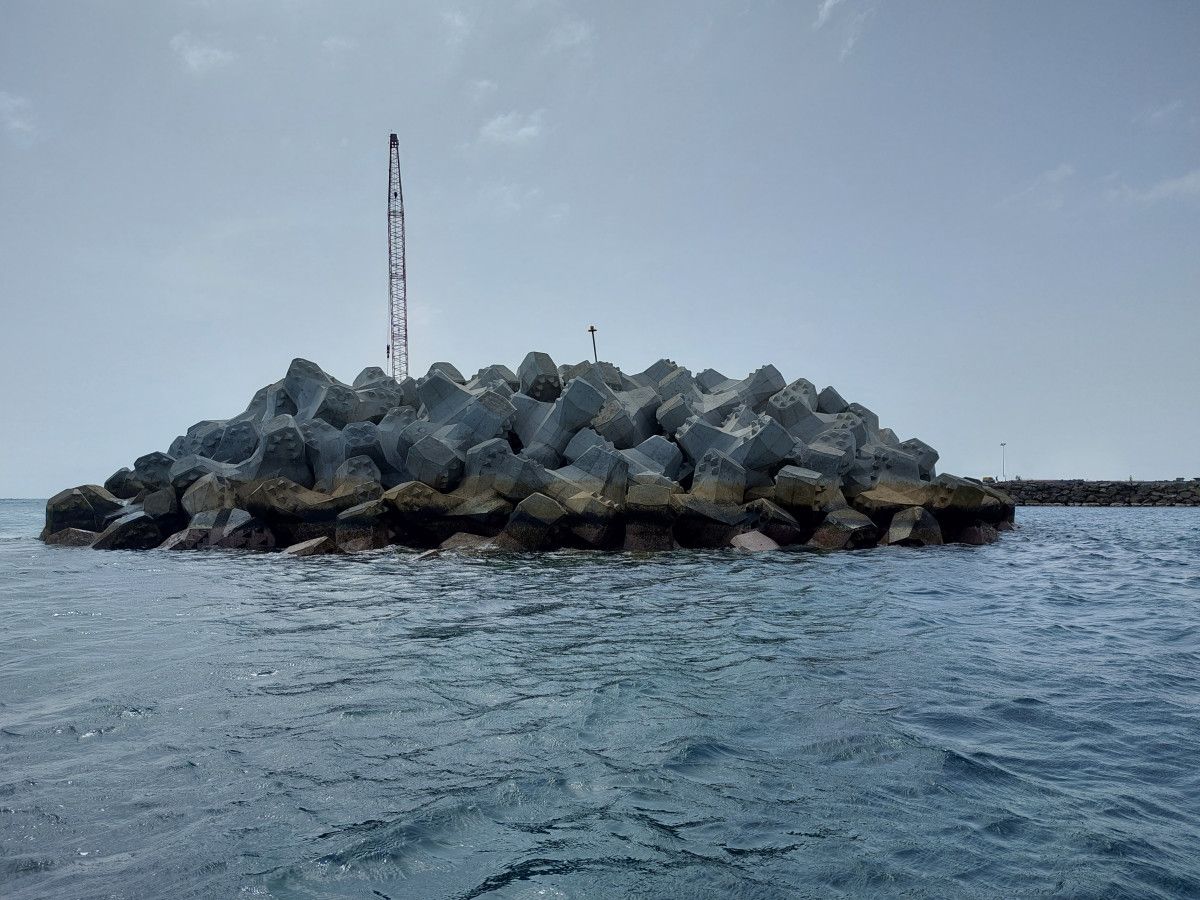

Concrete Layer Innovations; Porto Ingles ACCROPODE II technical-assistance record
Project P-CV-DD0-005 is not one undifferentiated port contract. Porto Ingles was delivered by a 37/33/30 consortium led by Teixeira Duarte, while Palmeira's later landside package went to GRINER / Armando Cunha Cabo Verde and its supervision to COSULGAL / TECNICA.
One programme contains separate marine, landside and supervision awards
Official Gazettes control the contracts, consortium names and CVE values. Teixeira Duarte controls the 37/33/30 consortium split and initial scope. PIANC and CLI establish the marine construction methods and specialist interface. AfDB and ENAPOR establish inauguration and programme context. No source reviewed by 2 August 2026 established Palmeira Lot 1 completion or its downstream subcontract map.
The missing names now sit below the Palmeira main contract
The package split changes both opportunity mapping and value interpretation. At Porto Ingles the identifiable supply chain reaches from the main consortium to CLI's ACCROPODE II sublicense and technical assistance and LNEC's hydraulic modelling. At Palmeira, the public record currently exposes the main and supervision consortia but not the downstream MEP, communications, drainage, paving and building trades.
Evidence conclusion
Programme financing and contract prices remain separate
Porto Ingles is a completed marine-civil reference with operating evidence, but its final commercial close-out ran beyond inauguration: Cabo Verde authorized a CVE 265.25 million final price revision in September 2024 after a prior CVE 53.25 million amendment. Palmeira is a separate CVE 839.03 million landside contract plus a CVE 90.11 million supervision contract. The AfDB-reported EUR 36 million programme financing cannot be assigned to any single package, and the older EIB-financed Palmeira quay and breakwater expansion must remain outside this contract map.
Outstanding evidence
- Palmeira Lot 1 handover and acceptance evidence
- Named Palmeira MEP, communications, drainage and paving subcontractors
- Palmeira final account and revised completion date
- Porto Ingles final-account close-out after the 2024 price revision
- Post-handover performance of the Ro-Ro ramps and detached breakwater
- Future packages under the separate Global Gateway expansion
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Sources used 6
- Porto Ingles final price revision and Palmeira Lot 1 award Official Gazette of Cabo Verde, 23 September 2024
- Palmeira Lot 1 supervision contract authorization Official Gazette of Cabo Verde, 21 April 2025
- Porto Ingles consortium award and shares Teixeira Duarte Engenharia e Construcoes, 20 August 2019
- Construction of the Porto Ingles Ro-Ro platform and detached breakwater PIANC Portugal, 3 October 2023
- Porto Ingles ACCROPODE II project Concrete Layer Innovations, Project page reviewed 2 August 2026
- Upgraded Maio Port to transform economy and boost trade African Development Bank, 8 September 2022
