Cabo Verde Porto Ingles and Palmeira Ports Modernisation Programme

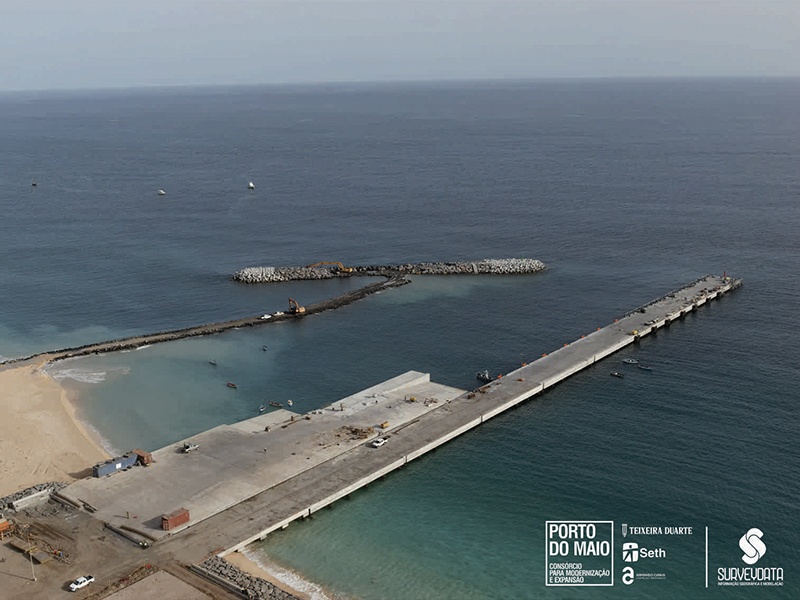

Aerial view of the Porto Ingles piled Ro-Ro platform, repaired jetty and detached breakwater during construction on Maio

Armando Cunha Cabo Verde; Porto Ingles consortium construction record

Cabo Verde's AfDB-backed P-CV-DD0-005 programme spans two ports and materially different contract layers. At Porto Ingles on Maio, a Teixeira Duarte-led consortium delivered the repaired jetty, piled Ro-Ro platform, detached breakwater, expanded logistics platform and access road. At Palmeira on Sal, a later GRINER / Armando Cunha Cabo Verde consortium received the landside modernisation contract, while COSULGAL / TECNICA was selected for works supervision.

Project signal

Construction in Cabo Verde

Current status Porto Ingles marine works were inaugurated on 7 September 2022 and later received a final price-revision authorization; Palmeira's landside package was awarded to GRINER / Armando Cunha Cabo Verde in July 2024, with no public completion or acceptance record identified by 2 August 2026 Source confidence Confirmed

Location

Cabo Verde / Africa

Segment

Port infrastructure

Status

Porto Ingles marine works were inaugurated on 7 September 2022 and later received a final price-revision authorization; Palmeira's landside package was awarded to GRINER / Armando Cunha Cabo Verde in July 2024, with no public completion or acceptance record identified by 2 August 2026 / Confirmed

Last checked

2 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Government of Cabo Verde through MIOTH; ENAPOR operates the ports and is the principal port stakeholder
Delivery parties
Teixeira Duarte Engenharia e Construcoes - 37% lead member of the Porto Ingles consortium, SETH - Sociedade de Empreitadas e Trabalhos Hidraulicos - 33% Porto Ingles consortium member, Armando Cunha Cabo Verde - 30% Porto Ingles consortium member and later Palmeira consortium member, GRINER - lead member of the Palmeira landside consortium, Downstream Palmeira building, MEP, communications, drainage and paving subcontractors - not publicly disclosed
Contract route
International competitive procurement under AfDB-backed project P-CV-DD0-005. Porto Ingles contract 01-T/PEMPIP/DGI/19 was signed on 5 August 2019 after public competition. Palmeira Lot 1 contract 02-T/PEMPIP/UEP/24 was awarded on 24 July 2024 after international public competition. The associated supervision contract 08-S/PEMPIP/UEP/24 followed an international restricted procedure with prequalification.
Execution window
The Porto Ingles consortium initially received an 18-month term, but pandemic suspensions and design changes extended delivery. The works were inaugurated on 7 September 2022; contractor technical reporting describes execution from 2019 to 2023, and Cabo Verde authorized the final price-revision amount in September 2024. Palmeira's landside contract was awarded in July 2024 and consigned in September 2024. AfDB project metadata keeps the wider programme in implementation through 31 December 2026, while no public Palmeira handover or acceptance record was identified by 2 August 2026.
Works package
Porto Ingles included rehabilitation of the existing open-piled jetty, a reinforced-concrete Ro-Ro platform with two ramps, a detached rock breakwater with ACCROPODE II armour at the heads, sheet-pile works, expansion and repaving of the logistics platform, building rehabilitation and an approximately 900-metre access road. Palmeira Lot 1 covers new passenger and cargo terminals, administrative and workshop buildings, a new access road, communications, power, lighting, water and wastewater systems, fencing, container-yard paving, equipment circulation and parking.
Marine interfaces
The Porto Ingles Ro-Ro deck is a 120-by-40-metre reinforced-concrete structure on sleeved reinforced-concrete piles, with pile integrity controlled by sonic and cross-hole testing. A detached breakwater protects berthing and Ro-Ro operations from southern swell; the technical paper records a 145-metre permanent structure with crest at +4.90 metres chart datum and seabed down to -12 metres, while CLI describes the broader temporary-access construction alignment differently. Approximately 650 to 656 six-cubic-metre ACCROPODE II units protected the roundheads. Palmeira's current public Lot 1 evidence is landside and utilities-led; it should not be presented as a new quay or breakwater contract.
Commercial evidence boundary
The official Porto Ingles contract value was CVE 1,910,097,104. Cabo Verde later authorized CVE 53,254,872 for Addendum 1 and CVE 265,250,877 for the final price revision, the latter described as 13.5% of the contract. These figures should not be summed without the signed amendment and final-account logic. The Palmeira landside contract was awarded at CVE 839,025,000 plus VAT on the national-financed portion. The COSULGAL / TECNICA supervision contract is CVE 90,107,632 plus applicable VAT. The programme-level EUR 36 million cited by AfDB at inauguration is a financing frame across Maio and Palmeira, not a disclosed aggregate of these contract awards.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Palmeira supervision consortium and value became public

Cabo Verde authorized the CVE 90,107,632 supervision contract with COSULGAL / TECNICA for Palmeira Lot 1 and the associated school package.

Source

Palmeira landside works were consigned

ENAPOR recorded the start event for the EUR 10 million landside modernisation package covering terminals, container areas, administration, lighting and access.

Source

Palmeira award and Porto Ingles final price revision were authorized

The same Official Gazette issue identifies the GRINER / Armando Cunha Cabo Verde award at CVE 839,025,000 and a CVE 265,250,877 final price revision for Porto Ingles.

Source

Porto Ingles modernisation was inaugurated

AfDB and ENAPOR recorded operational release of the rehabilitated port, including the new Ro-Ro platform, access works and marine-protection structures.

Source

Porto Ingles construction contract was signed

Contract 01-T/PEMPIP/DGI/19 established the Teixeira Duarte / SETH / Armando Cunha Cabo Verde consortium and the original CVE 1,910,097,104 value.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Owner-issued handover or acceptance for the Palmeira landside package
  • Palmeira construction progress, revised completion date and final account
  • Named MEP, communications, drainage, paving and building subcontractors at Palmeira
  • Final close-out of Porto Ingles contract amendments and price revision
  • Operational performance of Porto Ingles Ro-Ro ramps and detached breakwater
  • Any post-handover defects, maintenance packages or navigation restrictions
  • Clear separation from older EIB-financed Palmeira marine works and future Global Gateway expansion

Reporting status

Construction, confirmed confidence

Last checked 2 August 2026 across 10 cited sources. The dated timeline above carries the project events.

Last checked 2 August 2026 Cited sources 10
