Port Procurement
Dublin Port's EUR 200m framework is not a EUR 200m Berth 29 contract
A May 2026 award notice retrospectively formalised Dublin Port's January 2023 single-party framework with Murphy International. It records Berth 29 as the initial contract and EUR 200 million as the framework maximum, while Murphy now says it delivered 21 call-offs during 2025.
One late notice exposes three different commercial layers
TED and eTenders establish the 31 January 2023 framework contract, Murphy as winner, Berth 29 as the initial contract and EUR 200 million as the maximum value. Murphy controls its own claim of 21 call-offs in 2025 and selected package status. Dublin Port's Great South Wall release is separate project evidence and does not state that the emergency works were a framework call-off.
The call-off count widens the visible project pipeline
The framework ceiling, initial contract and later call-offs are not interchangeable values. Keeping them separate prevents Berth 29 from being mispriced at EUR 200 million and turns Murphy's aggregate delivery claim into a clear research queue for named packages, accepted values, subcontractors and handover evidence.
Evidence conclusion
Named packages remain the missing control

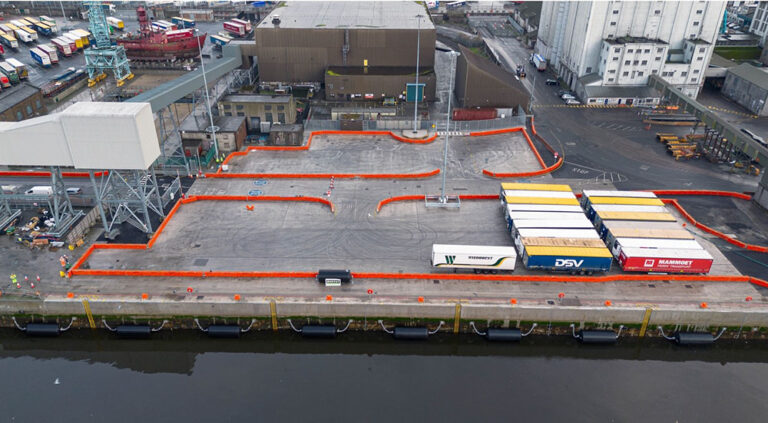

Berth 29 has credible completion evidence, including a 120-metre combi-pile wall, anchor wall, tie rods, crane-rail foundations, demolition and material reuse. Murphy's current project page also names Berths 30/31 and McCairns Yard with a July 2026 target, but no owner-issued acceptance was identified as of 2 August. Dublin Port's separate EUR 2.5 million Great South Wall completion proves current Murphy delivery but does not publicly establish that it belongs to the framework. The complete 21-call-off package map therefore remains open.
Outstanding evidence
- Owner acceptance for Berths 30/31 and McCairns Yard
- The complete list behind 21 call-offs delivered in 2025
- Individual package prices and contract dates
- Piling, steel, tie-rod, marine-plant and specialist subcontractors
- Berth 29 operating depth and service performance
- Future negotiated marine and civil call-offs
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Sources used 6
- Single Party Framework for Quay Walls and Marine and Civil Engineering Works award Tenders Electronic Daily, 28 May 2026
- Dublin Port marine works framework contract award eTenders, 28 May 2026
- Dublin Port Berth 29 project Murphy, Current project page reviewed 2 August 2026
- Murphy releases 2025 Annual Report Murphy, 2026 release reviewed 2 August 2026
- Murphy Annual Report 2023 Murphy, 2023 report published 2024; reviewed 2 August 2026
- Great South Wall remedial works completed Dublin Port Company, 23 March 2026
