Dredging Acceptance
Marsaxlokk dredging awaits final survey and acceptance

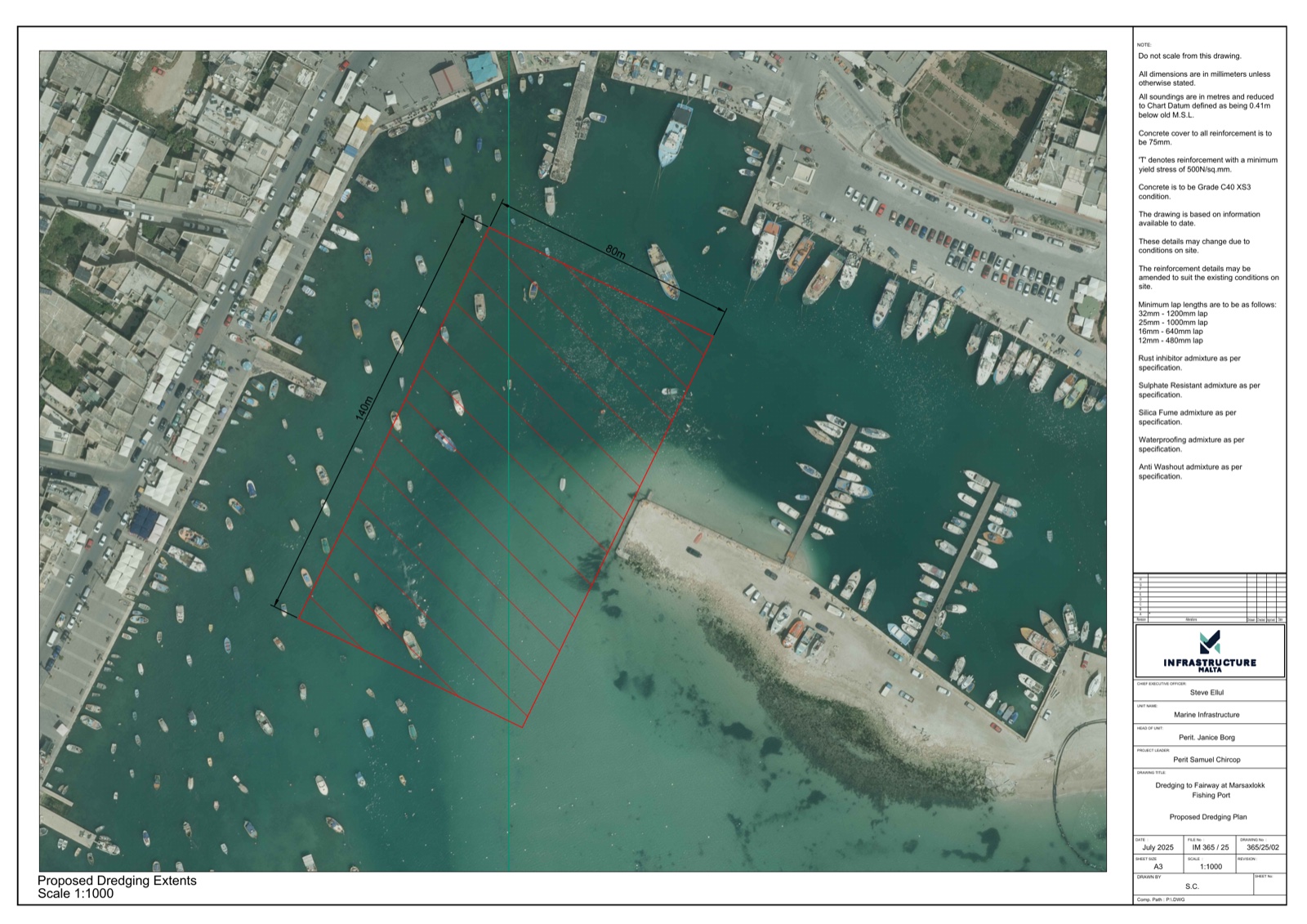

Infrastructure Malta drawing 365/25/02; exact proposed dredging extent
Marsaxlokk's tender quantity, award, executing contractor, named plant and active work are now connected for the fairway package. Final delivered geometry and the material split remain unpublished.
A procurement lead became a live dredging spread
TED and eTenders control the award and tender baseline. Infrastructure Malta and the Government of Malta control the depth target and partial beneficial-reuse route. Transport Malta controls the named dredging spread and latest official ongoing-work signal. The Malta Hydrographic Office defines the completion-authorisation gate. The final survey, accepted volume, complete material split, subcontract chain and final account remain unpublished.
Five public numbers belong to different ledgers
The award identifies Sammut Marine and EUR 1.384856 million; the contract documents add approximately 39,200 cubic metres over an 11,200-square-metre footprint; Transport Malta adds Gold Dredger and four assisting vessels; and the owner adds an approximately 5-metre target and partial beach reuse. Together these sources provide a rare award-to-mobilisation chain for a small fishing-port dredging package.
Evidence conclusion
The out-survey is the decisive missing record
Outstanding evidence
- Final bathymetric survey and Malta Hydrographic Office authorisation
- Measured quantity against the 39,200-cubic-metre tender allowance
- Accepted fairway depth against the roughly 5-metre owner target
- Għar Aħmar reuse volume and offshore-disposal receipts
- ERA, archaeological and environmental close-out
- Named subcontractors and assisting-vessel ownership
- Completion certificate, performance-security release and final account
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Sources used 7
- Marsaxlokk fairway dredging award notice Tenders Electronic Daily, 11 December 2025
- IMT009/2025 tender and contract documents Malta eTenders, Current contract workspace reviewed 2 August 2026
- Marsaxlokk dredging project officially starts Government of Malta, 2 March 2026
- Dredging works outside Il-Magħluq at Marsaxlokk Transport Malta, 29 December 2025
- Temporary shifting of pontoon due to ongoing Marsaxlokk dredging Transport Malta via Government Gazette, 26 June 2026
- Disposal-to-sea permits and Sammut Marine EP 00424/25 Environment and Resources Authority, Permit granted 18 December 2025; register reviewed 2 August 2026
- Malta Hydrographic Office dredging-completion role Transport Malta, Current authority page reviewed 2 August 2026
