Port Delivery

Tartous port operations advance without published dredging evidence

Published 13 July 2026 Updated 16 July 2026 Publisher IMWO Region Middle East Confidence Confirmed

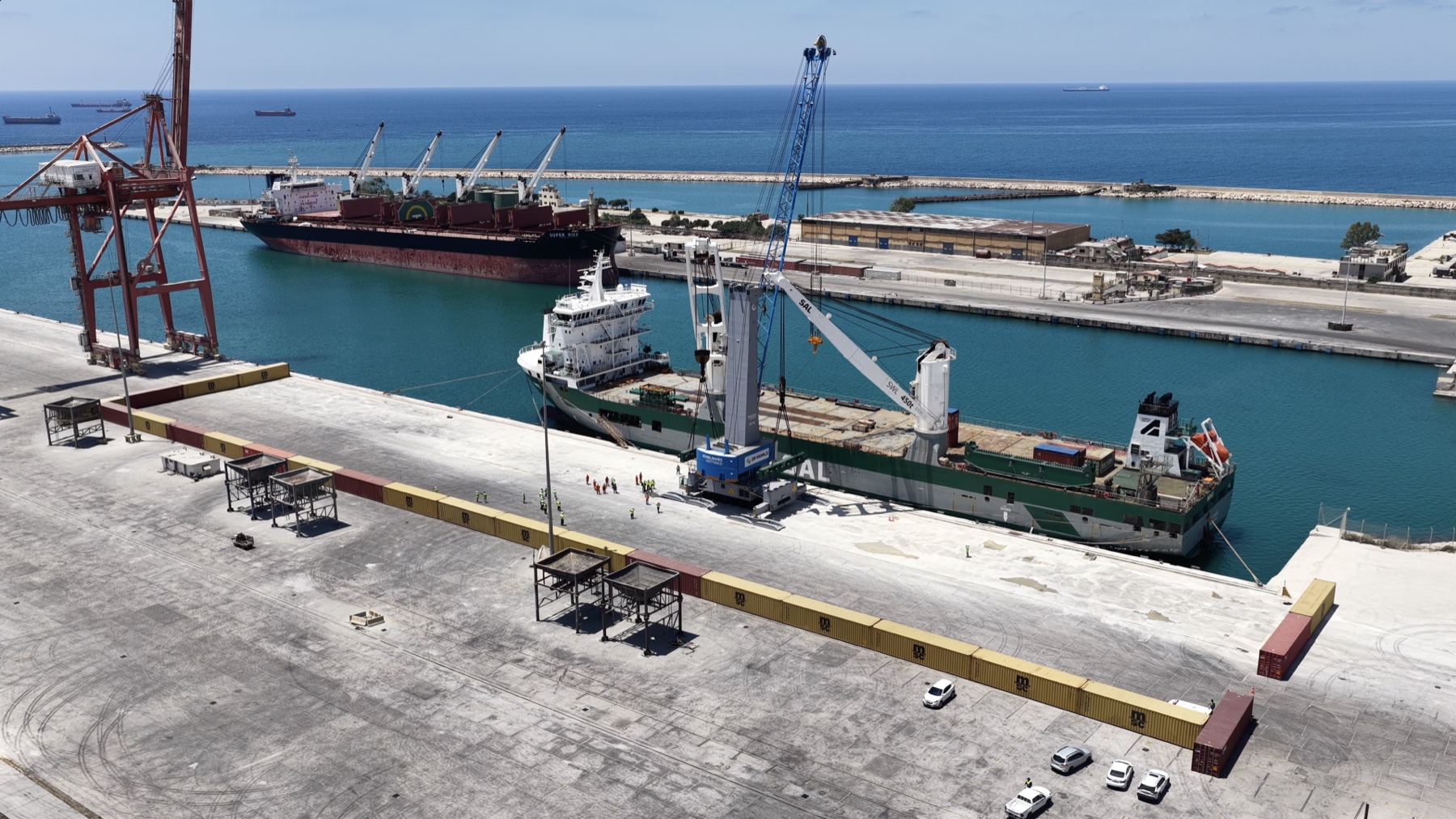

A new mobile harbour crane being unloaded from a heavy-lift vessel at the Port of Tartous

DP World

Tartous has crossed four distinct milestones: a May 2025 memorandum, the July BOT concession, formal operator handover with harbour-tug service in November, and the first of three mobile harbour cranes on 29 June 2026. Whether that visible mobilisation produces verified dredging, depth, quay readiness, commissioning and operating-capacity gains remains open.

Published scope and current milestone

SANA records the 16 May 2025 memorandum for an USD 800 million multi-purpose-terminal investment, while DP World records the signed 30-year BOT concession on 13 July. DP World's 12 November operations update confirms formal handover, the Al Fath harbour tug, infrastructure and quay-readiness surveys, and immediate dredging plans for access channels, basins, and berths; SANA's authority-attributed account corroborates the first-phase deepening and modernisation scope without claiming completion. The 1 July 2026 update confirms that the first mobile harbour crane arrived on 29 June, two further cranes were scheduled by August, and the three-crane package was expected to raise cargo-handling capacity by about 40% once operational. Dredging completion, achieved design depths, accepted quay works, all-crane commissioning, realised capacity gains, and full programme delivery remain unverified.

Port delivery and operating implications

A new crane improves handling potential but does not establish that vessel access or berth condition has been resolved. Marine contractors, equipment providers, and port watchers should separate the visible cargo-equipment milestone from the less visible survey, dredging, depth-acceptance, quay, and basin work required to support larger and more frequent ship calls.

Evidence conclusion

Handover, readiness and service evidence

Tartous has moved beyond a concession announcement and into operator-led mobilisation, but evidence remains uneven across work fronts. The first crane and harbour tug demonstrate equipment arrival; they do not show that access-channel, basin, berth or quay constraints have been removed. The missing chain runs from surveys and design through named dredging or rehabilitation packages, marine plant mobilisation, verified depths, quay readiness, equipment commissioning and sustained cargo performance. The USD 800 million programme value cannot be converted into an assumed marine-works award.

Outstanding evidence

  • Arrival and commissioning of the remaining two mobile harbour cranes
  • Named dredging packages, contractors, plant, quantities, and disposal route
  • Verified access-channel, basin, and berth design depths
  • Quay rehabilitation, load-readiness, and owner or operator acceptance
  • Cargo mix, vessel-size capability, and sustained turnaround performance

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Sources used 5

Source collections
