Performance record

Tuvalu Nui and Niutao harbour handover evidence

Nui and Niutao now have public completion and handover evidence for two named climate-resilient boat-harbour assets. That closes a construction question but opens a more demanding service question: whether reef access, aids to navigation, ramps, wharves, passenger and cargo facilities, maintenance systems, and workboat transfers remain available through routine use and severe weather. The current public record supports handover, not a long-term reliability or resilience conclusion.

Evidence boundary: government, development-finance, and contractor records support completion and handover of the named Nui and Niutao harbour assets, not sustained channel availability, aid uptime, service reliability, maintenance performance, or post-storm resilience.

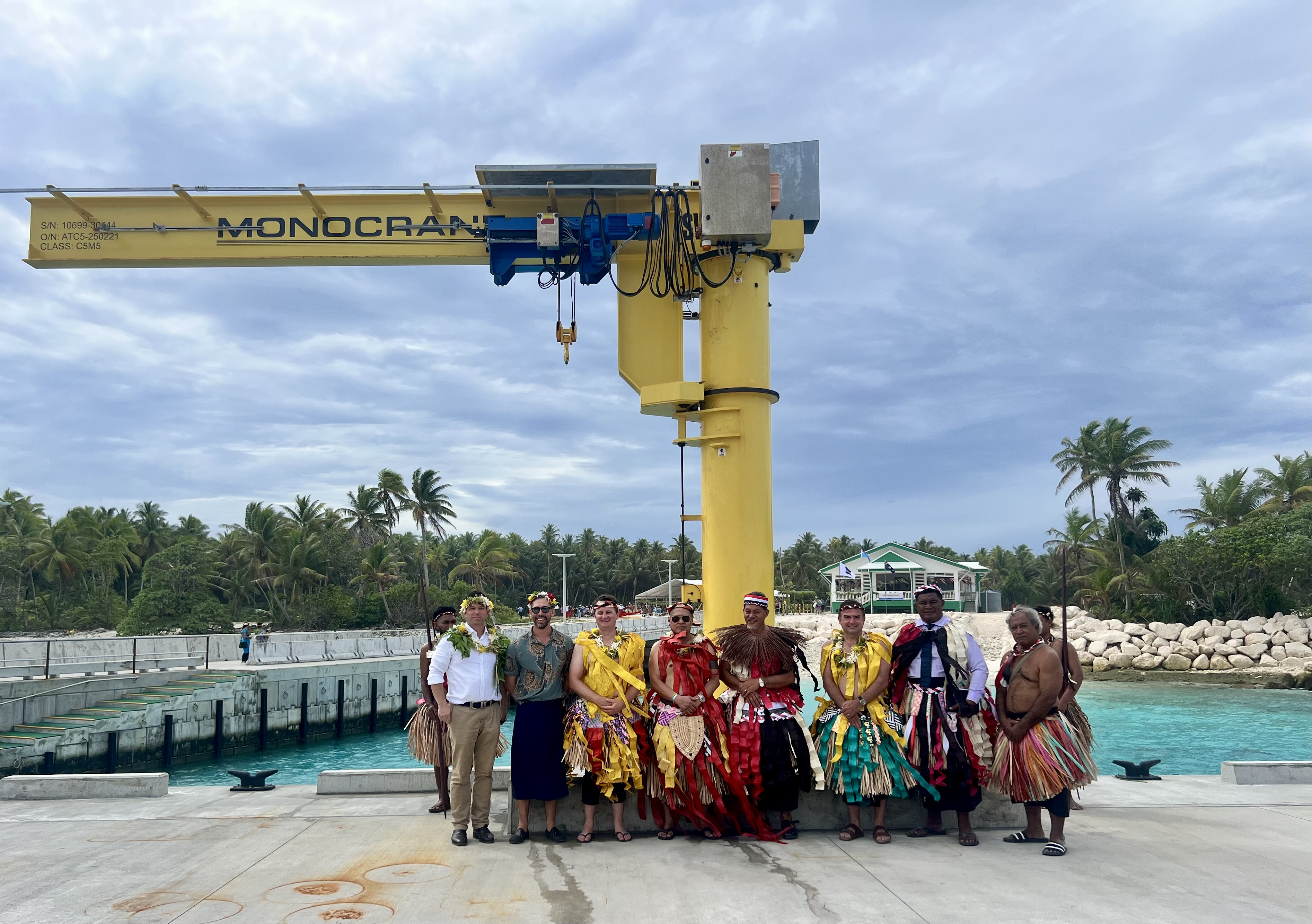

Opening participants standing on the completed Niutao harbour wharf beneath the cargo crane, with the protected basin and harbour facilities behind them

Australian Infrastructure Financing Facility for the Pacific

Verified record

Named harbour assets complete; no service-availability series identified in Tuvalu

Government, development-finance, and contractor records support completion and handover of the named assets. Service availability, maintenance, transfer safety, and storm performance require post-handover observations.

Evidence level Corroborated Sources reviewed 7

Location

Tuvalu / Global islands

Milestone or operating state

Named harbour assets complete; no service-availability series identified

Evidence conclusion

Handover evidence

Last updated

15 July 2026

Scope and limits

Evidence scope and limits

Records reviewed through 15 July 2026 document the February completion announcement for Nui and Niutao, the Niutao opening and the June 2024 Nui handover. They also identify the marine and landside assets and ADB's operation-and-maintenance capacity objective. Missing from the public file are current as-built surveys, service logs, weather cancellations, aid uptime, maintenance response, post-storm asset condition and independently measured user outcomes.

Confirmed

Supported findings

  • AIFFP and the Australian Government reported on 5 February 2026 that the Nui and Niutao Islands Boat Harbour Development project was complete and that the Niutao Boat Harbour had opened.
  • AIFFP identifies Niutao's dredged sea-access channel and basin, new wharf and passenger terminal, and Nui's boat ramp, cargo shed and passenger-terminal upgrades, together with lighting, guard rails, ramps, and climate-adaptation features.
  • ADB records the handover of Nui Island Boat Harbor to the Government of Tuvalu and local community in June 2024 under the Outer Island Maritime Infrastructure Project.
  • Hall Pacific identifies its Niutao scope as sea-access channel and basin excavation, an approach jetty, wharf, boat ramp and passenger terminal, plus navigation-aid work at Nukulaelae.
  • ADB identifies strengthened government and community capacity to operate and maintain outer-island harbours as a formal programme output, making lifecycle capability part of the intended result rather than an optional follow-up.

Still unverified

Unverified outcomes

  • Current as-built and maintenance hydrographic surveys for the Nui and Niutao channels, basins, approaches, and usable workboat depths.
  • Aids-to-navigation and lighting uptime, inspection frequency, fault response, spare-parts availability, and responsibility for recurring maintenance.
  • Workboat call frequency, weather-related cancellation rates, transfer safety events, passenger and cargo volumes, and dependable access to essential services.
  • Post-handover condition of ramps, wharves, cargo and passenger facilities, shoreline works, drainage, guard rails, and accessibility features after routine use or severe weather.
  • A dated close-out and operating-performance record for the wider ADB programme, including maintenance funding, local capability, lessons learned, and measured resilience outcomes.

Metric observations

Measurements and reporting gaps

Corroborated completion evidence

Asset handover

Government and development-finance records support completion of the two named harbour developments, while ADB separately records the earlier Nui handover.

Operating series unavailable

Marine access availability

The completed access works are identified, but public hydrographic maintenance records, usable-depth notices, workboat-call logs, and weather-related availability data remain absent.

Delivered features documented

Safety and accessibility

Lighting, guard rails, ramps, terminals, and replacement of hazardous surf landings are documented, while incident, transfer, and user-access outcome data are not public.

Programme intent confirmed

Maintainability

ADB makes operation-and-maintenance capacity a programme output, but no public inspection plan, budget, response-time series, aid-availability record, or asset-condition trend supports a performance conclusion.

Design intent confirmed

Climate resilience

The completion sources describe climate-smart design for rising seas and extreme weather, but post-storm condition, recovery time, overtopping, erosion, and service-continuity evidence remains unavailable.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Related project evidence

For the asset and programme scope, follow the project page. The associated brief carries the post-handover questions: hydrographic control, aids-to-navigation serviceability, facility maintenance, workboat availability and safe passenger and cargo transfers.

Open project record Read related intelligence brief Explore performance evidence

Sources used

Source collections

Record limitations

The record is limited to the cited public evidence and does not confer certification, ranking, warranty, safety or environmental approval, recognition, or procurement endorsement.
