Project record

Tuvalu Nui and Niutao climate-resilient boat harbours

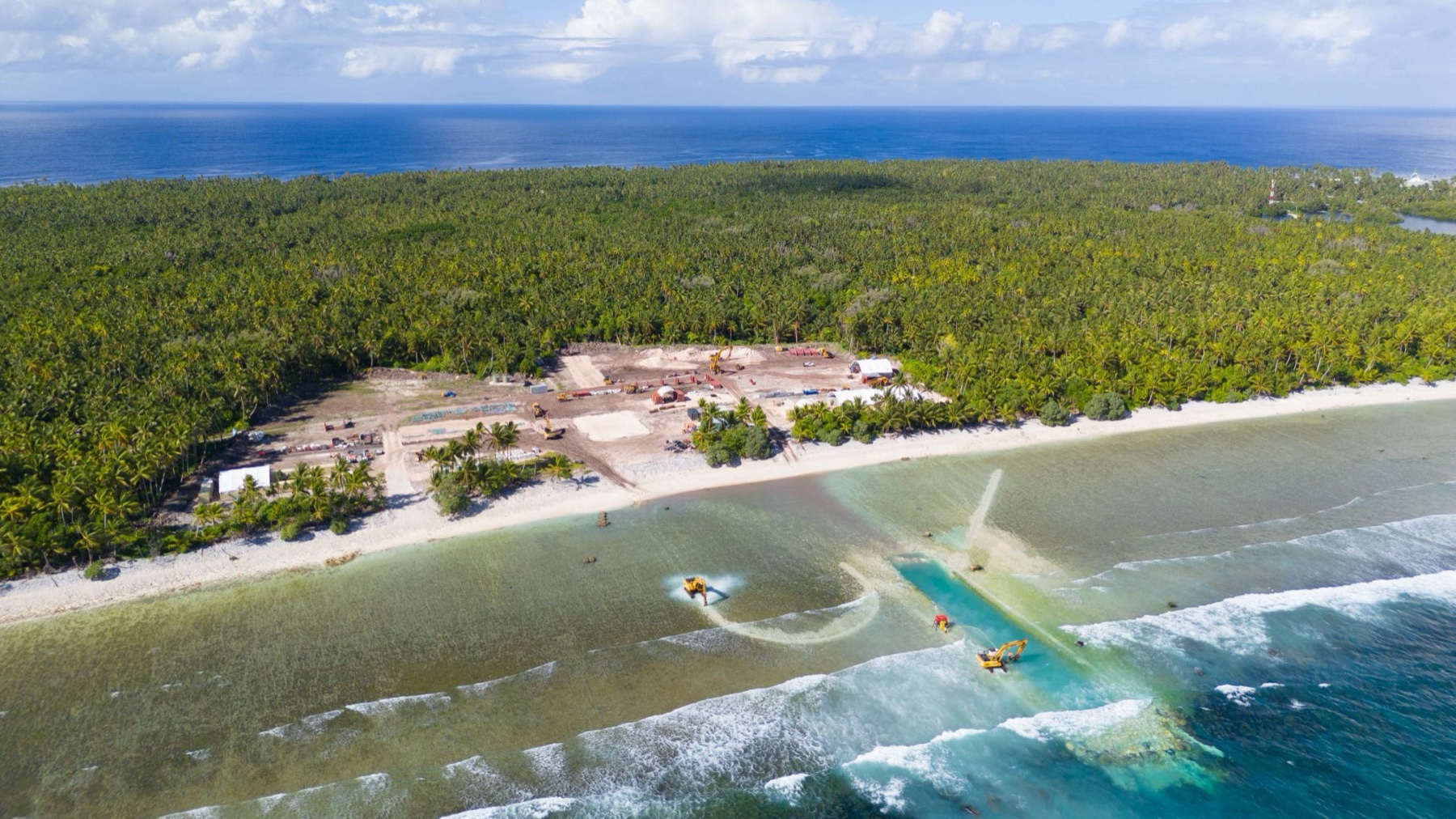

Aerial view of excavators cutting the Niutao boat-harbour access channel through the reef while landside facilities are prepared behind the beach

Hall Pacific

Tuvalu's Nui and Niutao harbour programme has moved from remote-island civil works into operations after completing two climate-resilient boat harbours with access-channel, basin, jetty, wharf, boat-ramp, passenger, cargo, reclamation, navigation, and safety interfaces.

Project signal

Completed in Tuvalu

Current status Nui and Niutao harbour works completed and opened; operating performance and maintenance now under review Source confidence Confirmed

Location

Tuvalu / Global islands

Segment

Port infrastructure

Status

Nui and Niutao harbour works completed and opened; operating performance and maintenance now under review / Confirmed

Last checked

13 July 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Government of Tuvalu
Delivery parties
Hall Contracting / Hall Pacific, Royal HaskoningDHV
Contract route
ADB grant financing, Government of Tuvalu contribution, and an AUD 21.4 million AIFFP co-financing package supported the wider programme. ADB's contract record and the AIFFP business case identify Hall Contracting for Nui civil works and as the selected contractor for the Nui and Niutao packages; ADB records Haskoning Australia in the maritime-structures engineering role.
Execution window
Nui harbour was opened to the community on 15 June 2024. Australia, AIFFP, ADB, and the Government of Tuvalu marked completion of the combined Nui and Niutao project and the opening of Niutao harbour on 5 February 2026. ADB's broader Outer Island Maritime Infrastructure Project remains listed as active, so programme close-out should not be inferred solely from the two-asset completion milestone.
Works package
Design and construction or rehabilitation of boat-harbour facilities at Nui and Niutao, including navigation-channel improvements, channel and basin excavation, approach jetties, wharves, boat ramps, passenger terminals, cargo sheds, shoreline reclamation, navigation aids, solar lighting, guard rails, signage, and accessible landside facilities.
Marine interfaces
The assets join reef and nearshore access channels to small workboat basins, ramps, jetties, wharves, navigation aids, reclaimed shoreline, and landside passenger and cargo facilities. Delivery and operation therefore depend on channel condition, sediment and wave exposure, berth and ramp usability, aids-to-navigation availability, and reliable maintenance in a remote logistics setting.
Commercial evidence boundary
The named Nui and Niutao civil packages are complete and ADB reports no remaining civil-works procurement. The continuing professional relevance is asset management, hydrographic and channel monitoring, navigation-aid maintenance, shoreline and sediment response, component replacement, safety inspection, and evidence of reliable inter-island transfer rather than a new construction tender.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Nui and Niutao harbour development completed

The joint government and financing-partner announcement confirms both named harbour assets were delivered and Niutao opened, moving the record from construction to completed named works while leaving operating performance and wider-programme close-out separate.

Source

Nui climate-resilient boat harbour opened

The ADB handover record establishes the first named asset entering community use; it does not establish later channel availability, navigation-aid uptime, maintenance performance, or completion of the Niutao package.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Post-handover channel and basin condition
  • Aids-to-navigation uptime and maintenance responsibility
  • Jetty, wharf, ramp, passenger, and cargo-facility serviceability
  • Workboat transfer reliability and safety outcomes
  • Close-out of remaining Outer Island Maritime Infrastructure Project actions

Reporting status

Completed, confirmed confidence

Last checked 13 July 2026 across 7 cited sources. The dated timeline above carries the project events.

Last checked 13 July 2026 Cited sources 7
