Analysis

Five ways current dredging capacity is being procured

Published 14 July 2026 Updated 23 July 2026 Publisher IMWO Section Analysis

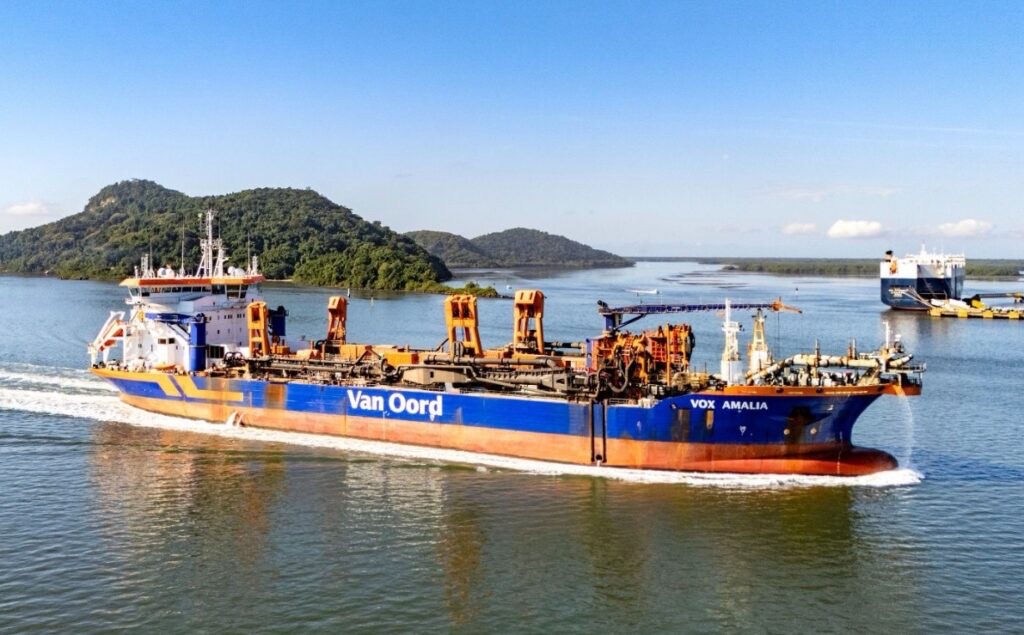

Van Oord trailing suction hopper dredger Vox Amalia navigating inside Paranaguá port during the 2026 pre-concession maintenance campaign

Port Authority of Paraná via Dredging Today

The current cases divide into five commercial forms: contractor-funded fleet capacity, owner-controlled vessels, bounded capital works, recurring maintenance delivery and long-horizon navigation performance. Royal IHC delivered Boskalis' 31,000 m³ SEAWAY on 20 July, while DEME's 22,000 m³ TSHD remains a 2029 future-capacity order.

The procurement object changes the risk map

A dredging requirement can lead to at least five different commercial objects: contractor-funded fleet capacity, an owner-controlled vessel, a defined works package, a recurring maintenance service, or a long-term navigation concession. Each route may address similar sediment, depth, access, and resilience needs, but the buyer and market are allocating a different combination of asset control, production capacity, delivery certainty, utilisation, and lifecycle performance.

These five forms place risk in different hands before any opportunity is called a tender. A contractor vessel order tests future supply, yard execution, finance, technology, and utilisation. An owner shipyard procurement tests design, integration, trials, training, support, and delivery assumptions. A capital-works award tests mobilisation, production, ground risk, environmental controls, and placement routes. A recurring maintenance service tests annual availability and accepted dimensions. A concession adds operating, monitoring, user-charge, transition, and long-horizon performance exposure. Treating all five as interchangeable 'dredging contracts' hides the actual decision point and the suppliers positioned to compete.

Contract comparison

Where each model places control and risk

Vessel orders, works contracts, maintenance services and concessions place delivery, payment and operating risk in different hands.

  1. 01

    Commercial object and buyer

    A vessel acquisition, defined capital result, recurring maintenance service and long-term navigation system create different obligations even when each includes dredging.

    Buyer identity, supplier field and obligation change with the commercial object.
  2. 02

    Legal and physical stage

    Market sounding, RFI, tender, award, signed contract, mobilisation, accepted works, operation and recurring service are separate legal and physical positions.

    Future dates and signed terms remain distinct from achieved performance.
  3. 03

    Scope and interface boundary

    Channels, basins, berths, material types, rock, navigation aids, surveys, VTS, environmental controls, placement routes, training and support define the package boundary.

    Plant, works and navigation-service obligations remain distinct.
  4. 04

    Payment and revenue exposure

    Capital payments, unit rates, availability or service payments, tolls, tariffs, grant fees, indexation and extension rights support different risk allocations.

    Payment structure exposes the bidder's quantity, availability, traffic or utilisation risk.
  5. 05

    Transition and retained responsibility

    Incumbent maintenance, temporary works, pre-handover campaigns, owner-retained areas, future concession duties and adjacent packages can overlap in time.

    Interim work and future concession duties retain separate responsible parties.
  6. 06

    Accepted performance record

    Accepted vessel delivery, mobilisation, hydrographic baselines, quantity and geometry acceptance, maintained dimensions, service levels, tariff commencement and owner-confirmed operation support different conclusions.

    Accepted results establish the current delivery or operating position.

Nine-case procurement map

The plant may look similar while the object being bought changes

The nine cases divide vessel supply, capital works, recurring maintenance and long-term navigation concessions by their present commercial position.

Netherlands Confirmed

Boskalis SEAWAY 31,000 m³ TSHD

Procurement position
Contractor-funded vessel / delivered 20 July 2026
Object being bought
A 31,000 m³ custom TSHD delivered after sea trial with diesel-electric propulsion, Azipods, methanol preparation and long-distance discharge capacity.
Outstanding delivery record
First deployment, operating fuel and measured production, discharge, emissions, reliability and utilisation.
Global Official source

DEME Group

Procurement position
Contractor-funded vessel order / construction
Object being bought
A 22,000 m³ shallow-draft TSHD with future-fuel adaptability, automation, China-built structure, Singapore outfitting, and planned 2029 delivery.
Outstanding delivery record
Yard progress, equipment and class baseline, trials, completion, delivery, project deployment, utilisation, and measured productivity.
Panama Confirmed

Panama Canal new TSHD acquisition planning

Procurement position
Planning / non-binding RFI
Object being bought
An owner-operated mid-size TSHD plus class, trials, training, warranty, spares, support, and delivery assumptions.
Outstanding delivery record
A formal procurement route, issued RFP, accepted technical baseline, bidder field, award, trials, delivery, and deployment.
Democratic Republic of the Congo Confirmed

CVM Congo River Easydredge 2700XL fleet renewal

Procurement position
Signed vessel contract / delivery
Object being bought
A customised owner-fleet TSHD with integration, construction, first-year maintenance, technical support, crewing, and training.
Outstanding delivery record
Yard progress, launch, trials, acceptance, delivery, crew readiness, deployment, and measured Congo River outputs.
Sweden Confirmed

Port of Luleå Malmporten fairway and deepwater port works

Procurement position
Signed capital-works contract after retender
Object being bought
A bounded four-season remaining-works result with mixed sediment, rock and reclamation reuse, following a completed preparatory package and procurement redesign.
Outstanding delivery record
Mobilisation, seasonal production, material routing, survey acceptance, and achieved navigational dimensions.
Australia Confirmed

Port Hedland Zone 5 Bypass Channel

Procurement position
Capital-works award
Object being bought
A bounded bypass-channel dredging result designed to protect shipping-channel continuity and resilience.
Outstanding delivery record
Plant mobilisation, accepted quantities and geometry, approved placement, hydrographic acceptance, and operational availability.
India Confirmed

Mumbai Port 2026-29 maintenance dredging programme

Procurement position
Three-cycle maintenance tender / bids due 24 August
Object being bought
Annual assured-depth and measured-quantity dredging across a live tidal port using nominated TSHD capacity, supplementary plant, surveys, transport, and approved disposal.
Outstanding delivery record
25 August technical opening, qualification, disclosed prices, award, annual notice, fleet mobilisation, pre-dredge survey and accepted first-cycle dimensions.
Argentina Confirmed

Argentina Vía Navegable Troncal dredging and signaling concession

Procurement position
25-year corridor concession / mobilisation
Object being bought
Deepening, maintenance, signalling, hydrometry, navigation operation, and toll-backed performance across an export waterway.
Outstanding delivery record
Fleet continuity, accepted channel dimensions, navigation-aid availability, service levels, traffic and toll transparency, and recurring performance.
Brazil Confirmed

Paranaguá access channel dredging concession

Procurement position
25-year port-access concession / transition
Object being bought
Phased surveys, VTS, deepening, rock removal, channel and berth maintenance, navigation aids, and tariff-backed port-access service.
Outstanding delivery record
Operating transfer, baseline surveys, tariff start, phased mobilisation, accepted capital works, and maintained port-access dimensions.

Contract choice starts with uncertainty, not dredger class

CEDA's contract-selection guidance compares six procurement aspects and their sub-aspects before scoring standard contract types. Vessel class is only one input; design maturity, owner uncertainty, interfaces, responsibilities, payment logic and the accepted result shape the contract choice.

CEDA's soil-investigation paper identifies inadequate investigation as a leading cause of cost growth, delay and disputes in dredging and maritime works. A procurement model cannot allocate ground risk coherently when the sediment profile, rock, contamination, variability and investigation limitations are missing from the commercial baseline.

PIANC WG 100 separates planning and design controls from construction-stage equipment, method and institutional controls. It also ties environmental-management choices to baseline data, habitat sensitivity and dredging economics. CEDA's adaptive-management guidance then distinguishes reactive, proactive and strategic feedback loops, with monitoring and response rules set for the project.

Contractor fleet investment creates capacity before a project award

Boskalis' SEAWAY now provides a completed vessel-delivery case. The 31,000 m³ custom TSHD moved from a Royal IHC construction contract in October 2023 to naming and launch at Krimpen aan den IJssel in October 2025. Boskalis still described it as under construction on 5 March 2026; Royal IHC then handed the vessel to Boskalis on 20 July after a successful sea trial. Delivery closes the shipbuilding package, while the first project, operating fuel and measured dredging, discharge, reliability and emissions performance remain unpublished.

DEME's 1 July 2026 order is a contractor-funded supply-side case. The company specifies a 22,000 m³ shallow-draft TSHD for capital dredging, reclamation, major port development, maintenance work, and offshore seabed preparation. The announced design combines an advanced power and propulsion plant, an optimised hull, more efficient dredging technology, high automation, provision for future green-methanol use, and adaptability for enhanced autonomous dredging functions. DEME places the investment in its EUR 150-300 million 'substantial' range.

DEME's build chain is also commercially relevant: the main structure is planned in China, outfitting and final completion in Singapore, and delivery in 2029 under DEME supervision. This is a committed future-capacity decision, not a built or accepted vessel or a named project allocation. The two cases now occupy different positions: SEAWAY has completed sea trial and owner handover but lacks a published first deployment; DEME's vessel still requires named yards, physical build milestones, trials and delivery. Both lack representative utilisation, production, fuel, reliability and emissions evidence.

Owner fleet procurement converts production into an internal capability

The Panama Canal Authority's June 2026 RFI is a requirement-formation case. ACP fixed a 3,500-4,300-cubic-metre hopper range, one starboard trailing pipe, 30-metre maximum dredging depth, three discharge routes, dynamic positioning, and a 24/7 operating concept. It also tests diesel-electric and azimuth-propulsion assumptions, reference vessels, class, training, factory and harbour tests, dredging trials in Panama, digital-twin options, data rights, spares, warranty, payment, securities, and delivery. Historic US$95.920 million cutter-suction and US$43 million backhoe-dredger purchases in 2008 and 2011 provide precedent for formal owner-vessel procurement; they do not convert the current voluntary and non-binding survey into a tender or funded order.

CVM has progressed from market testing to a signed vessel contract. Its Royal IHC contract covers a customised Easydredge 2700XL of about 3,300 cubic metres, construction in Vietnam, upgraded propulsion and accommodation, integrated control systems, and first-year maintenance, technical support, crewing, and training. ACP is still testing the market and commercial structure, while CVM has selected a vessel platform and supplier. Neither record establishes achieved channel performance before delivery, acceptance, deployment and production.

Capital works buy a bounded result and shift mobilisation risk

Malmporten at Luleå is a major capital-works model, but its signed approximately SEK 5.7 billion contract is the result of a procurement reset rather than a single award event. A roughly 1.5-million-m³ preparatory package entered the water in 2024 and finished that October; the common main tender and deepwater-quay tender were then stopped after bids exceeded budget; and an optimized fairway design returned through a two-stage procurement. The resulting remaining-works contract covers about 40 kilometres of fairway and harbour-basin deepening, roughly 14 million cubic metres of mixed sediment and rock, and reuse of suitable material for reclamation. Delivery is planned across ice-free seasons from 2027 to 2030. The employer is buying a defined physical outcome, while the contractor team carries high-intensity fleet orchestration, hard-material, seasonal, turbidity, and reclamation-interface risk within the contract boundaries.

Port Hedland's Zone 5 Bypass Channel is a smaller but similarly bounded award. Pilbara Ports appointed Jan De Nul Australia for an A$50 million capital-dredging project with an identified envelope of up to 800,000 cubic metres. Its commercial purpose is resilience and operational continuity around a constrained 42-kilometre shipping channel. For both works contracts, the unresolved events are mobilisation, production, material routing, survey acceptance and navigational benefit rather than vessel ownership.

Recurring maintenance buys annual availability rather than ownership

Mumbai Port's Tender E.47/2026 is a recurring-service model packaged as three annual campaigns across 2026-27, 2027-28, and 2028-29. The ₹281.70 crore estimate covers approach channels, turning areas, outside berths, Indira Dock and other live-port locations, with dredging, transport, approved disposal, hydrographic control, and high-spot removal inside the priced scope. Each annual cycle has a 24-week completion period, while the nominated fleet must mobilise within the contract's stated annual window.

The tender requires at least 9,000 m³ of combined TSHD capacity and supplementary plant for constrained near-wall and shallow areas, but it does not transfer vessel ownership. It also separates assured-depth locations from areas paid on measured in-situ quantities, creating different siltation, access, survey, and acceptance exposures inside one service. Corrigendum VI keeps the package open until 24 August and schedules technical opening for 25 August. Qualification, financial opening, award, annual notice, nominated fleet, mobilisation, pre-dredge survey and accepted first-cycle dimensions remain later records.

Two concessions expose different long-horizon service boundaries

Argentina's Vía Navegable Troncal uses a 25-year toll-backed concession. Its scope combines capital deepening, recurring maintenance dredging, signalling, buoy replacement, hydrometric monitoring, operation, and modernisation across the Paraná-Río de la Plata export corridor. The concessionaire therefore carries a wider operating system than a contractor delivering one dredging season or one channel footprint.

Paranaguá is also a 25-year performance model, but it is bounded around one organised port's channels, turning basins, anchorages, berths, navigation aids, VTS, and hydrographic services. ANTAQ's programme stages VTS and surveys in the first two contract years; capital, adjustment, and deepening dredging, Anchorage 6 works, rock removal, and navigation aids in years three to five; and recurring channel and berth service from year six. A dedicated access tariff begins with the operating transition, while the 2027-2028 Antonina maintenance service remains a separate transitional obligation outside the concession area.

The evidence set also differs. VNT is a multi-jurisdiction export-corridor system with toll, signalling, hydrometry, traffic and long-waterway continuity exposure. Paranaguá concentrates responsibility around port-access dimensions, berth operability, VTS, survey acceptance, tariff transition and a phased capital-to-maintenance handover. In both cases, the long term and published depth objective do not establish performance; accepted works, maintained dimensions, service availability and transparent charging provide the operating record.

Choosing the route changes the supplier map

Contractor fleet investment is strongest where the contractor can finance a large asset, see durable demand across projects, control utilisation, and carry yard and technology risk. Owner fleet investment fits persistent strategic demand where crews, maintenance, and internal production management can be sustained. Works contracting is stronger where a bounded result can absorb specialist mobilisation and clearly allocate quantity, ground, environment, and placement risks. Recurring maintenance fits repeated annual outcomes without transferring vessel ownership. A concession fits where navigation performance, services, investment, and durable revenue belong in one operating model, but a river corridor and a port-access system still transfer different traffic, survey, tariff, transition, and interface risks.

For the market, these are different opportunity maps. Shipyards, propulsion and dredging-system suppliers, class, finance, training and lifecycle support compete around both contractor and owner fleet acquisition, but the utilisation and control logic differs. Dredging contractors, surveyors, environmental specialists and placement partners compete around capital and maintenance packages with different mobilisation horizons. Operators, investors, navigation-system providers and long-term maintenance fleets become central in concessions. Contract values, bidder fields and delivery exposure become comparable only within the same commercial object and allocation of asset, utilisation and performance risk.
