Project record

Argentina Vía Navegable Troncal dredging and signaling concession

Participation
Not assessed
Project facts checked

Concession signed and oversight council active; operating transfer is complete while August maintenance mobilisation remains to be evidenced

Project sources

Argentina has signed a 25-year Vía Navegable Troncal concession with Jan De Nul and Servimagnus after an environmental hearing, public observations, a three-envelope competition, pre-award and formal award. The contract joins deepening, maintenance dredging, signalling, 1,150 navigation buoys, hydrometric monitoring, toll operation and traffic continuity across the Paraná-Río de la Plata export corridor. A government control council formalized on 7 August 2026 creates bimonthly public reporting on navigation, completed works, maintenance, investment and traffic, but neither the council nor signed transfer establishes August fleet mobilisation, achieved depth or stable service performance.

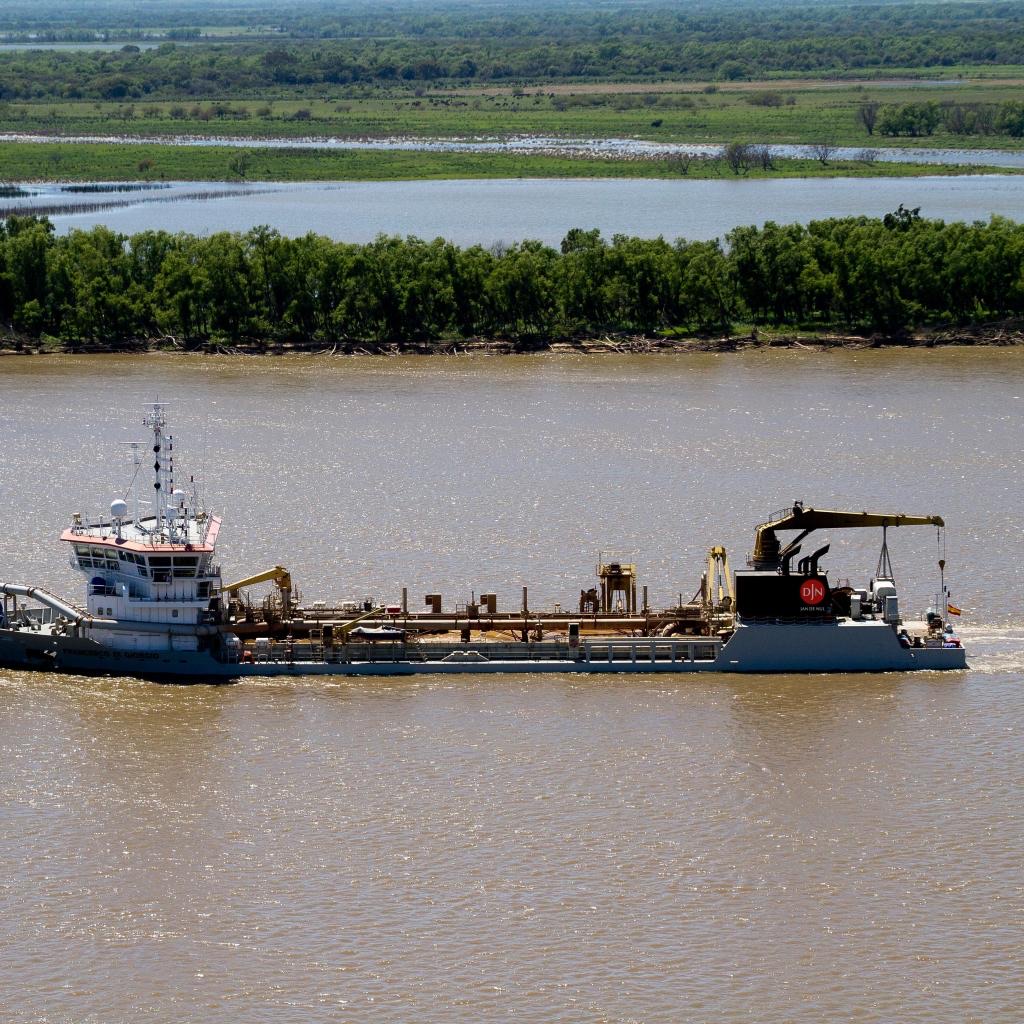

Jan De Nul dredging vessel operating on the Paraná River within Argentina’s Vía Navegable Troncal waterway system

Jan De Nul

Location

Argentina / Americas

Segment

Port infrastructure

Phase

Mobilisation / Confirmed

Last checked

11 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Agencia Nacional de Puertos y Navegación (ANPYN)
Delivery parties
Jan De Nul N.V., Servimagnus S.A., Vía Navegable Argentina S.A.
Contract route
25-year toll-backed national and international public concession
Execution window
Maintenance mobilization scheduled from August 2026; key channel-deepening phases expected through 2031; concession term 25 years.
Works package
Deepening, redredging, maintenance dredging, signaling, buoy replacement, hydrometric monitoring, operation, and modernization across Argentina’s principal Paraná–Río de la Plata export waterway.
Marine interfaces
A live inland-waterway system linking 79 ports to Atlantic access, where dredging, navigation aids, traffic continuity, river morphology, and water-level monitoring operate as one service system.
Commercial evidence boundary
This is a toll-backed navigation service, not a stand-alone dredging award. The concessionaire carries recurring morphology and depth work, navigation infrastructure, monitoring, traffic continuity and user-charge exposure over 25 years, so lifecycle operating evidence matters as much as fleet capacity or contract signature.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Argentina formalized the VNT control council

The council creates bimonthly technical oversight, specialist commissions and public minutes covering navigation, completed works, maintenance, investment and traffic. It strengthens the future evidence channel but does not prove dredger mobilisation, achieved depth, buoy acceptance or operating performance.

Source

Argentina signed the 25-year concession contract

Vía Navegable Argentina S.A. completed the administrative transfer steps, asset transfer and worker contracting, while the 13.5% toll reduction took effect. Signature establishes the operator and commercial handover; August fleet presence, measured channel geometry, accepted navigation aids and sustained service performance still require field or operating records.

Source

Resolución 36/2026 formalized the award

The Boletín Oficial placed Jan De Nul-Servimagnus first, DEME second and rejected DTA Engenharia for the missing bid-maintenance guarantee. The award closed the competition but did not itself transfer operations or start dredging.

Source

The evaluation committee recommended Jan De Nul-Servimagnus

The pre-award recommendation followed the three-stage scoring process and remained a recommendation until the formal award resolution and later contract signature.

Source

ANPYN opened the third-envelope economic offers

Jan De Nul-Servimagnus and DEME reached the economic stage after technical evaluation. Economic-envelope opening was a procurement gate, not a selected contractor, final tariff or operating commitment.

Source

Three consortia submitted first-envelope bids

The official award record identifies offers from Jan De Nul-Servimagnus, DEME and DTA Engenharia. Bid receipt established competition, while qualification, technical merit, economics, award and signature remained open.

Source

ANPYN issued the national and international concession tender

The final call put modernization, expansion, operation, signalling, dredging, redredging and maintenance into a toll-backed, contractor-risk procurement. Tender scope did not establish an award, final delivery sequence or field execution.

Source

The prior-observations stage closed before final tendering

ANPYN completed the short technical and public comment process on the draft conditions and moved toward final documents. Closing consultation was a procurement-design milestone, not an environmental approval or contractor appointment.

Source

The environmental-management hearing ran for 14 hours

ANPYN recorded 247 participants and received public and specialist input on the management and environmental-evaluation report. The informative hearing supported tender preparation; it was not proof that every future deepening activity had project-specific approval.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Evidenced August 2026 plant and workforce mobilisation
  • First control-council minutes and ANPYN bimonthly works-and-navigation presentation
  • Reach-by-reach maintenance and deepening depths, quantities and sequence
  • 1,150-buoy replacement, commissioning and availability programme
  • Hydrometric, traffic, bathymetric and service-performance reporting
  • Environmental approvals and controls for each capital-deepening phase
  • Toll implementation, user oversight and traffic-continuity performance
  • Five-country CIH technical, institutional and toll decisions affecting the Santa Fe-Confluence interface

Reporting status

Project phase
Mobilisation
Evidence confidence
Confirmed
Last checked
11 August 2026
Cited sources
13

Sources and related records

Project changes Methodology Email a correction Project tracker

Project sources 13
