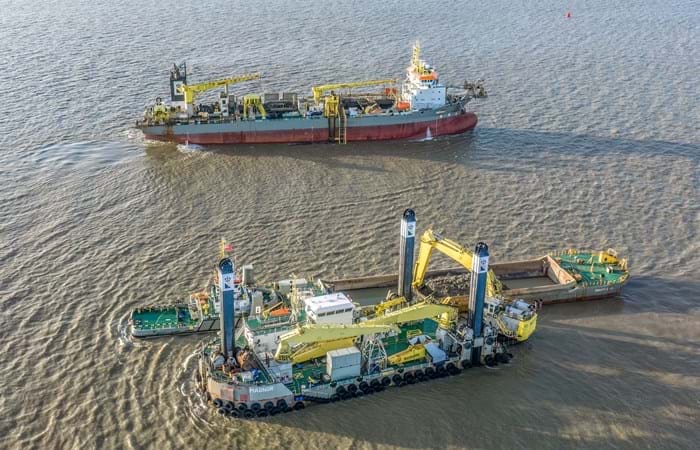

Luleå's 14 million m³ award follows a failed tender and redesign
Malmporten's current SEK 5.7 billion contract is the result of a procurement reset, not a straight-line award. A 2024 preparatory dredging package reached the water, the first main tender exceeded budget, the fairway design was optimized, and Boskalis-Van Oord now holds the roughly 14-million-m³ remaining-works package.
Published scope and current milestone
The Swedish Maritime Administration's March 2022 market dialogue published an early whole-program baseline of about 22 million m³ and an April 2024-December 2026 implementation concept. A June 2024 authority release then defined a separate roughly 1.5-million-m³ preparatory package; the July field update named Optimus, Kahamari 2 and Magnor, and the March 2026 status page says those works finished in October 2024. The same status page says the common main-works tender and deepwater-quay tender were stopped in February 2025 after bids exceeded budget, followed by fairway-design optimization and a two-stage retender from September. Port of Luleå's June 2026 award release uses September 2025 as the previous-procurement cancellation date, so the public record is not fully aligned. The owners signed the remaining-works contract on 2 July 2026. Port, authority, Boskalis and Van Oord sources define about 40 kilometres of fairway, roughly 14 million m³ of mixed soil and rock, a SEK 5.7 billion / approximately EUR 500 million value, ice-free-season execution from 2027 and completion by 15 August 2030. The published figures refer to different baselines: 22 million m³ for the old programme, 1.5 million m³ for the preparatory package and 14 million m³ for the current remaining-works contract.
Contract packaging and mobilisation implications
The sequence changes the risk reading. The old 21-22-million-m³ whole-program baseline, the completed 1.5-million-m³ preparatory package and the current 14-million-m³ contract are different scope states. Suppliers and analysts need to track what was removed, completed, retendered or left in the separate deepwater-port and quay programme before comparing quantities, prices or progress.
Evidence conclusion
Award, mobilisation and acceptance evidence
Malmporten is now a production-intensive capital works contract with a documented procurement-reset history. Attention shifts from award value to whether the 2027 mobilisation converts the optimized scope into seasonal production, hard-material excavation, compliant material routing, accepted hydrography and usable reclaimed land while the separate port-side works keep pace.
Outstanding evidence
- Spring 2027 mobilization
- Ice-free-season production plan
- Rock excavation and drill-and-blast sequencing
- Reclamation and deepwater-port interface dates
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Sources used 9
- Sweden’s largest dredging project to start in 2027 Swedish Maritime Administration, 2 July 2026
- Malmporten remaining dredging contract signed Port of Luleå, 2 July 2026
- Boskalis and Van Oord awarded large dredging contract for Port of Luleå Boskalis, 2 July 2026
- Van Oord and Boskalis awarded Malmporten dredging contract Van Oord, 2 July 2026
- Sweden's largest dredging project takes the next step Port of Luleå, 12 June 2026
- Malmporten project status and procurement background Swedish Maritime Administration, 31 March 2026
- Malmporten preparatory dredging begins Swedish Maritime Administration, 23 July 2024
- First Malmporten dredging contractor appointed Swedish Maritime Administration, 13 June 2024
- Malmporten market-dialogue scope baseline Swedish Maritime Administration, 24 March 2022
