Scope Boundary
Skinners Pond wharf 401 carries two official scope baselines
DFO's August 2021 environmental assessment described an approximately 50-metre same-footprint copewall with no excavation. The September tender and July IFC drawings instead include dredging and excavation, a pile-in-place reinforced-concrete copewall and an approximately 65.93-metre rehabilitated wall. Kildare Construction later received the CAD 1,099,800 award, but the public record located does not explain the scope difference or confirm close-out.
The tender introduced a broader construction baseline

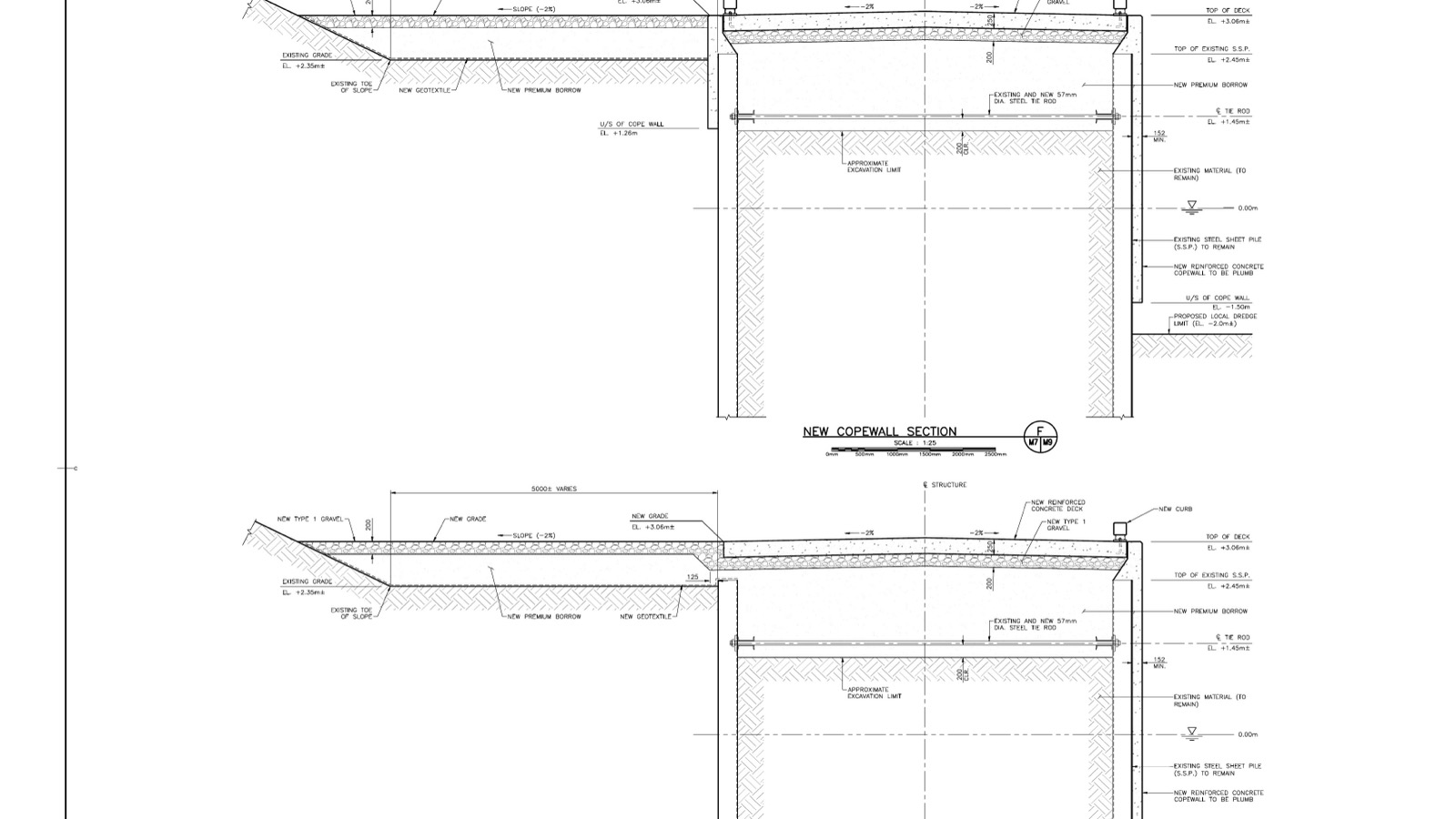

CanadaBuys identifies the tender, award, prime, value, scope and target date. The federal assessment gives the earlier approximately 50-metre, no-excavation description; the official IFC drawings depict the approximately 65.93-metre construction layout and local underwater-excavation limit. No cited source explains why the baselines differ or documents physical closeout.
Final geometry awaits as-built evidence
Wall length, dredging limits and construction method drive concrete, reinforcing steel, excavation, marine plant, sediment handling and payment quantities. Treating the earlier assessment as the final construction baseline would erase work shown in the IFC package. Treating the drawings as as-built evidence would be equally unsafe. The decision-grade record keeps both baselines visible until an approved change log and as-built package close the difference.
Evidence conclusion
As-built evidence must reconcile the two descriptions
CanadaBuys confirms Kildare Construction, contract 4500013345, CAD 1,099,800 and the 15 June 2022 target. The official drawings establish Harbourside's issued design, an approximately 65.93-metre wall and local underwater excavation within two metres of the existing sheet-pile face. The IAAC record independently establishes the earlier approximately 50-metre, no-excavation description. The difference may reflect scope development or differing document boundaries, but the cited sources do not establish why. Nor does the target date establish completion. Structure 401 should remain separate from the 411/412 reconstruction and later engineering work on other harbour structures.
Outstanding evidence
- Approved design change and environmental review trail
- As-built wall length, dredge limit and concrete geometry
- Measured excavation and sediment destination
- Unit-price quantities and final contract value
- Named dredging, concrete, steel, survey and testing lower tiers
- Structural and hydrographic acceptance
- Harbour release and return-to-service date
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Sources used 4
- 30001407 copewall construction tender CanadaBuys / Government of Canada, Published 23 September 2021
- 4500013345 Kildare Construction award CanadaBuys / Government of Canada, Awarded 23 December 2021
- Skinner's Pond Copewall Installation assessment Impact Assessment Agency of Canada, Notice of determination 13 August 2021
- Structure 401 issued-for-construction design drawings Fisheries and Oceans Canada / CanadaBuys, Issued July 2021; published 23 September 2021
