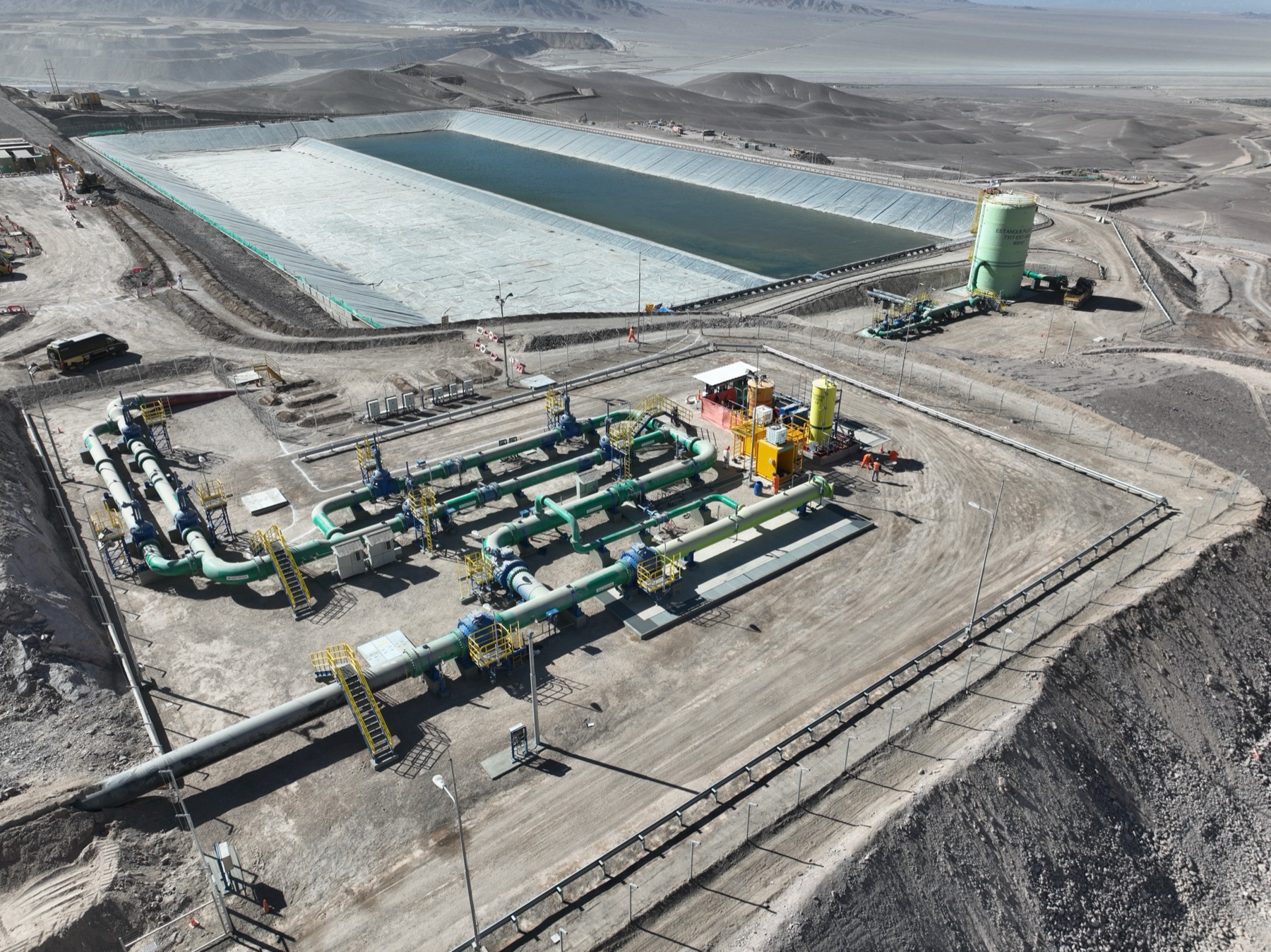

Desalinated water has reached the new Radomiro Tomic reservoir after moving through SADDN's integrated seawater-intake, desalination, power, pumping, and long-distance conveyance system. The milestone is important because it demonstrates first water across the marine-to-mine route, but the public record still describes construction, commissioning, hydraulic testing, and progressive interface validation. It does not establish continuous 840 l/s service, accepted water quality, marine-system reliability, supply to all three mining divisions, or full commercial operation.
Evidence boundary: Techint E&C reports first desalinated water at the Radomiro Tomic reservoir during construction and commissioning, not accepted rated output, sustained service, marine-intake and brine-return performance, whole-system completion, or commercial operation.
Chile / Americas
Desalinated water reached Radomiro Tomic; progressive validation continues / Bounded first-water evidence
Not assessed for recognition
15 July 2026
Scope and limits
The file reviewed through 15 July 2026 establishes Codelco's BOOT authorization, Aguas Horizonte's developer role and Techint's EPC mandate. It defines the submarine system, auxiliary pier, coastal sump, trench blasting, intake and brine-return pipes, coastal energization, intake-tower installation, high-head conveyance, reservoir and independent commissioning assurance. Techint's 23 June account confirms first water at Radomiro Tomic during hydraulic tests and progressive validation. Still absent are accepted continuous flow, representative water-quality results, intake availability, brine-dispersion monitoring, power and pumping reliability, service to the other two mining divisions, final completion and commercial-operation certification.
Confirmed
Still unverified
Metric observations
Water reaching the Radomiro Tomic reservoir demonstrates a connected route through treatment and long-distance pumping, while the source explicitly keeps the system in progressive validation.
The intake, submarine pipeline, coastal sump, and brine-return scope are documented, while the reviewed public sources provide no accepted operating-availability or post-commissioning marine-monitoring record.
Three pumping stations, five substations, more than 160 kilometres of conveyance, and a roughly 3,000-metre lift define the challenge, but no sustained flow or outage series is public.
Hydraulic tests and technical checks are reported, while accepted water-quality, pressure, volume, defect-closeout, and all-division distribution records remain unavailable.
The reviewed sources support construction and commissioning progress, not final completion, commercial-operation certification, sustained BOOT service, or mature operating performance.
Knowledge context
Continue through the topic collections to compare this record with related projects, evidence guides, briefs, articles, reports, and performance records.
The project page maps the marine works, treatment, power, pumping, pipeline, reservoir, BOOT structure and expansion scope. Its companion brief follows acceptance from seawater intake and brine return through reverse osmosis, substations, pumping, conveyance, storage and mine distribution.
