First desalinated water reached Radomiro Tomic during progressive commissioning; rated service and commercial operation remain open
Codelco's SADDN links a 1.3 km submarine intake and brine-return system to an 840 l/s desalination plant, more than 160 km of 48-inch pipeline, three pumping stations, five substations, and a 250,000 m3 reservoir above 3,000 m. First water reached Radomiro Tomic in June 2026; accepted capacity and sustained service remain unpublished.
Chile / Americas
Marine utilities
Commissioning / Confirmed
15 July 2026
Coverage
Marine utilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogThe event advances the record to first water across the integrated coast-to-mine route during progressive commissioning; rated flow, accepted water quality, marine reliability, all-division service, and commercial operation remain separate gates.
SourceThe contractor recorded the high-altitude reservoir, manifolds and surrounding pipework nearing physical completion at 3,080 m. Reservoir readiness advances the inland receiving interface, while water arrival, accepted storage, distribution and sustained operation remain unverified.
SourceTechint completed a 940 m horizontal directional drilling more than 30 m below the riverbed, closing a named continuity risk in the inland pipeline. The crossing is a construction milestone, not proof of full-route hydraulic acceptance or marine-system readiness.
SourceThe source confirms physical delivery of a named intake structure and advances the marine work front beyond fabrication, without proving connected-system commissioning or accepted hydraulic performance.
SourceTechint reported the coastal electrical sector energized and testing and start-up of the desalination plant able to begin, while pumping-station mechanical and electrical work remained active. Energization opens commissioning; it is not accepted output or BOOT service commencement.

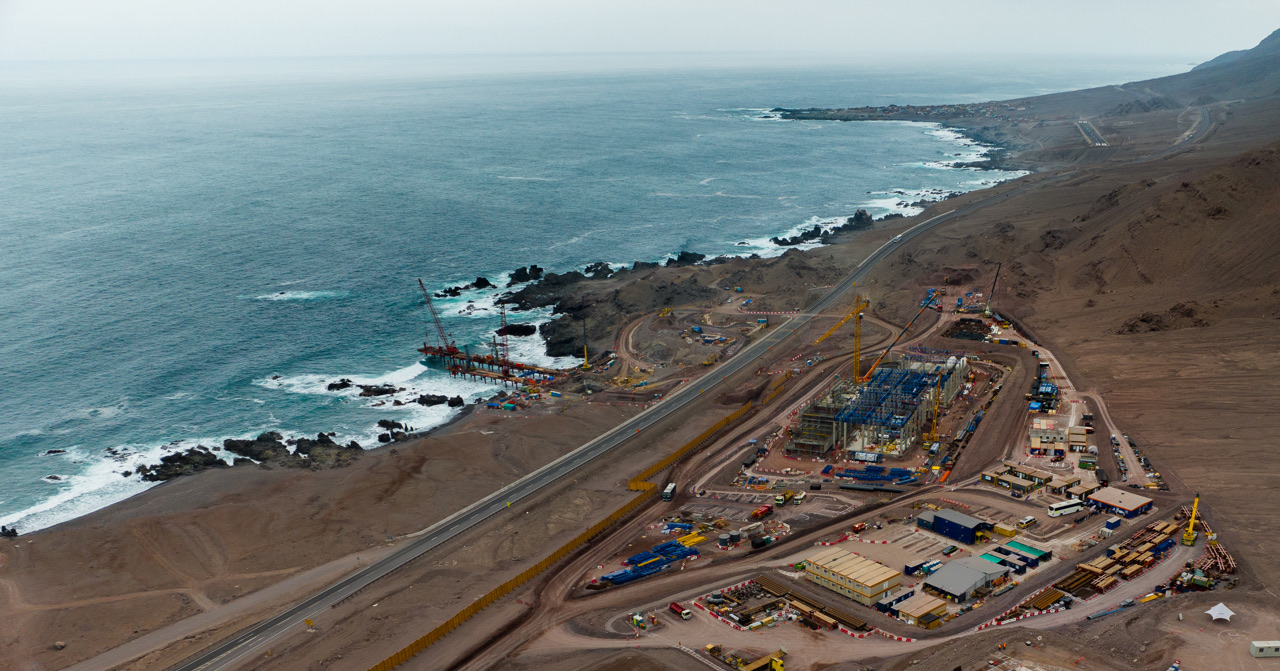

SourceThe project update identifies the auxiliary pier, coastal sump, underwater blasting, submarine-pipe trench, intake and brine-return work, establishing a physical marine package rather than a generic desalination interface.
SourceThe owner sought technical oversight for developer-led commissioning and start-up, separating BOOT delivery responsibility from Codelco's assurance role and later distribution-system operation. No appointment or commissioning acceptance followed from the procurement record alone.
SourceThe contractor reported the auxiliary pier and coastal sump under construction and offshore pipeline sections being welded at Mejillones for launch toward Caleta Viuda. Percentage progress and fabrication do not prove installed or accepted intake and return systems.
SourceThe contractor announcement confirms the project moved from BOOT award into EPC execution for the desalination, intake, pumping and conveyance system. The notice did not document mobilisation across every workfront or any completed marine asset.
SourceThe owner record establishes the commercial route, consortium, more than USD 1 billion investment frame, marine works and integrated coast-to-mine scope. Contract authorization and award do not prove signature, notice to proceed, construction, commissioning or operation.
SourceEvidence gap
