Port Atlantique La Rochelle Chef de Baie 4 terminal

Participation
Not assessed
Project facts checked

Quay construction and the four-hectare yard remain the latest official delivery state; handover to operator AMLP was targeted for the second half of 2026 but has not been published

Project sources

Port Atlantique La Rochelle is adding a 160-metre multipurpose quay and four-hectare logistics platform at Chef de Baie 4. The EUR 17.832698 million quay contract is led by Océlian, with Leduc, GTM and Terélian assigned to distinct foundation, civil and earthworks roles. The port's latest published checkpoint said the quay was well advanced by mid-December 2025 and placed yard and drainage work in 2026.

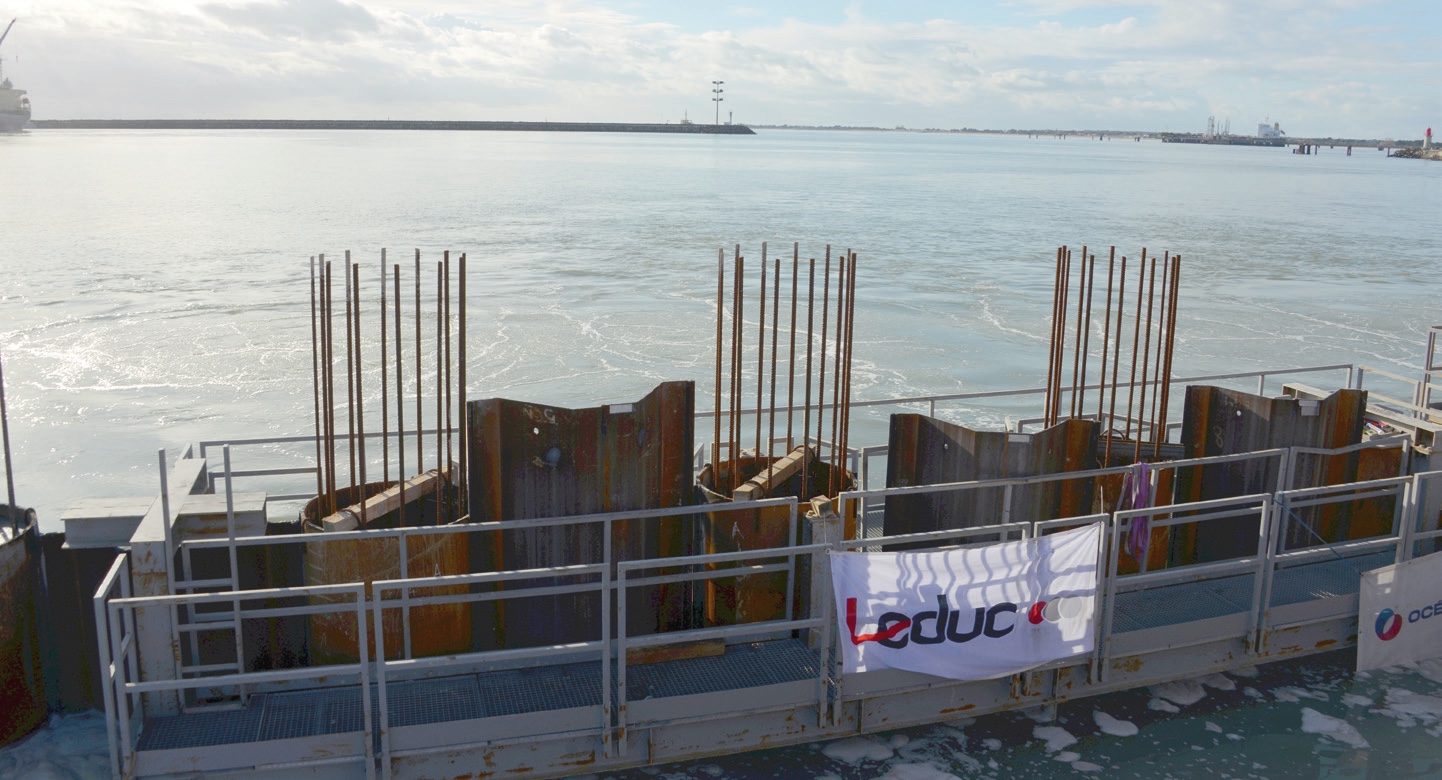

Steel marine foundations and reinforcement under construction at Chef de Baie 4, with Leduc and Océlian site branding

Port Atlantique La Rochelle; December 2025 view of Chef de Baie 4 marine foundation works

Location

France / Europe

Segment

Port infrastructure

Phase

Construction / Confirmed

Last checked

2 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Grand Port Maritime de La Rochelle, trading as Port Atlantique La Rochelle; AMLP is the intended terminal operator and participates in the landside package
Delivery parties
Océlian - joint-venture lead; foundations, mooring block, north trestle and transition slab, Leduc - marine foundations, GTM OA - principal capping beam and concrete civil works, Terélian - excavation, backfill and earthworks, Quiet Oceans - underwater-noise and marine-mammal monitoring procedure for the contractor group
Contract route
The port awarded a single marine-works contract after an EU procurement procedure. TED identifies Océlian as the winner and EUR 17.832698 million excluding VAT. Port records then identify the full Océlian-Leduc-GTM-Terélian group and allocate its principal scopes. AMLP's later landside role sits outside the disclosed quay-contract allocation.
Execution window
The contract was concluded in October 2024, studies began in November and site works started in mid-February 2025. By mid-December 2025 the port described the quay as well advanced. Yard and stormwater works were scheduled to start in spring 2026, with terminal handover to AMLP targeted for the second half of 2026. No accepted handover has been published.
Works package
Build an approximately 160-metre sealed combi-wall quay, with a future 90-metre extension option, plus a north trestle and southern mooring structure. The quay wall uses tubular piles and sheet piles anchored by roughly 40-metre tie rods. The wider terminal includes a four-hectare platform, backfill, polluted-soil treatment, a stormwater basin and berth electrification for ships up to 200 metres, 85,000 tonnes and 13.5 metres draught.
Marine interfaces
The contract joins the pre-dredged berth pocket to deep foundations, an anchored retaining wall, mooring structures, quay furniture and landside platform systems. Construction also carries underwater-noise and turbidity controls: the contractor group appointed Quiet Oceans, placed a marine-mammal sensor 750 metres from the works and retained bubble-curtain and acoustic-deterrent responses around pile installation.
Commercial evidence boundary
The EUR 17.832698 million TED result is the quay works contract, not the final terminal account. Port publications separately cite EUR 23 million, EUR 24 million and EUR 36 million for differently framed terminal and access programmes. Those figures should remain source-specific until the owner publishes a reconciled scope and final account. The named contractor roles create an attributable package map, while steel, marine plant, electrical, drainage, survey and acceptance suppliers remain partly undisclosed.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

The port logged an advanced quay workfront

The owner said the quay was well advanced by mid-December 2025 and scheduled the four-hectare platform and stormwater basin for spring 2026 before a second-half handover target.

Source

Owner records exposed the contractor package map

The port named Océlian, Leduc, GTM and Terélian, confirmed the mid-February site start and described the combi-wall, tie rods, temporary trestle and environmental constraints.

Source

The quay works contract was concluded

The EU award result records Océlian and EUR 17.832698 million excluding VAT. The notice alone does not allocate the other group members or prove site execution.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Combi-wall, tie-rod and capping-beam completion
  • North and south mooring structures and marine furniture
  • Four-hectare yard, backfill and polluted-soil treatment
  • Stormwater basin, platform drainage and berth electrification
  • Quiet Oceans monitoring close-out and environmental acceptance
  • As-built hydrography, load testing and owner acceptance
  • AMLP handover and first sustained vessel service

Reporting status

Project phase
Construction
Evidence confidence
Confirmed
Last checked
2 August 2026
Cited sources
6
