Project record

Soubise/Marquis coastal protection: Soubise Lots 1 and 2

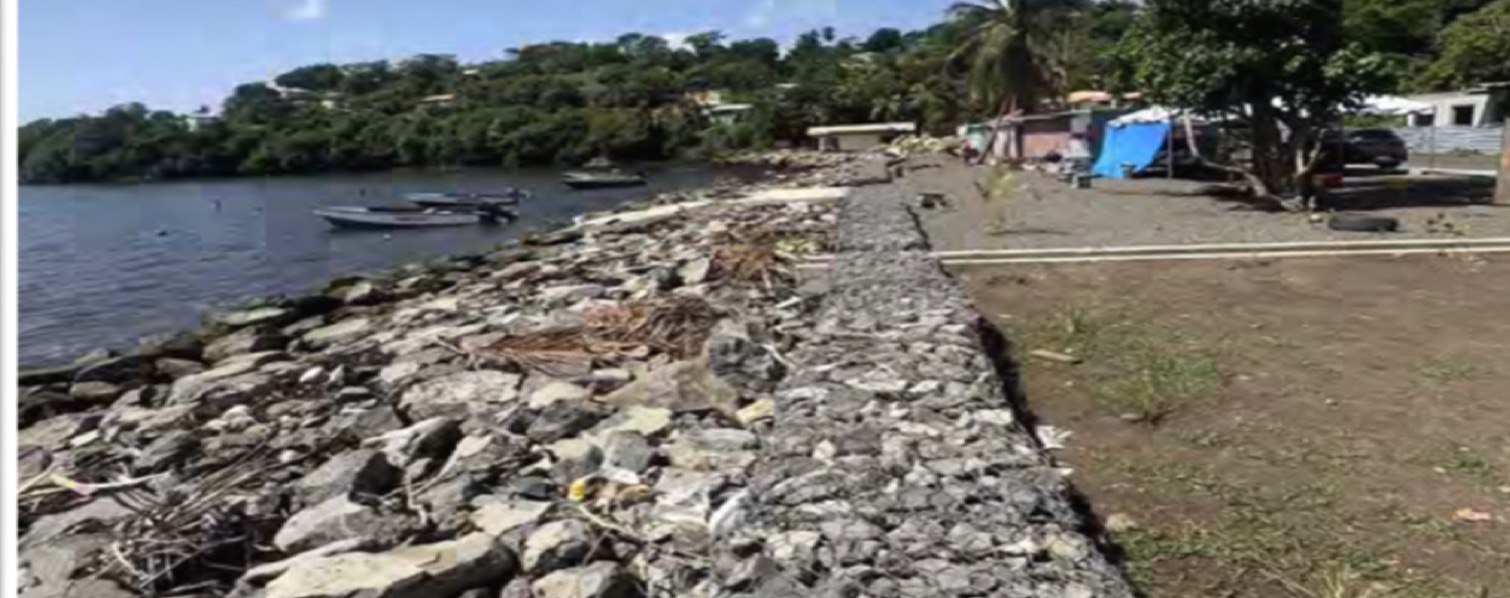

Soubise Bay shoreline with an existing gabion wall, small boats and homes beside the proposed coastal protection works

Government of Grenada / Alpha Engineering & Design; exact-site Soubise Bay photograph in the final ESMP

Two official contract entries record signed works under GD-MOIID-420385-CW-RFB. General Earth Movers-UEM Inc. holds Lot 1 Soubise (South) at USD 1,603,696.86 and Construction and Industrial Equipment holds Lot 2 Soubise (North) at USD 4,143,611.05. The September 2025 environmental documents define three design lots across Soubise and Marquis, but the current award records cover only the two Soubise lots. No cited source establishes a Marquis Lot 3 award, notice to proceed, site possession, mobilisation or physical construction.

Project signal

Award in Grenada

Current status Two Soubise works lots were signed on 27 April 2026 for a combined USD 5.747 million; Marquis Lot 3, notice to proceed, mobilisation and physical works remain publicly unconfirmed Source confidence Confirmed

Location

Grenada / Americas

Segment

Coastal infrastructure

Status

Two Soubise works lots were signed on 27 April 2026 for a combined USD 5.747 million; Marquis Lot 3, notice to proceed, mobilisation and physical works remain publicly unconfirmed / Confirmed

Last checked

7 August 2026

Coverage

Related sectors

Coastal infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Government of Grenada, Ministry of Mobilisation, Implementation and Transformation
Delivery parties
General Earth Movers-UEM Inc. - signed works contractor for Lot 1 Soubise (South), Construction and Industrial Equipment - signed works contractor for Lot 2 Soubise (North), Alpha Engineering & Design (2012) Ltd. - project-specific design and supervision consultant; not a works contractor, Armour-rock, aggregate, transport, marine-plant, diving, survey and other lower-tier suppliers - not confirmed in the cited award records
Contract route
The Ministry issued international RFB GD-MOIID-420385-CW-RFB on 18 August 2025 for coastal revetment, gabion baskets and rock armour, with technical criteria weighted 70% and cost 30%. The notice described one Soubise/Marquis coastal-protection procurement and an 18-month construction period. World Bank records 1885375 and 1885376 later report two Soubise contracts signed on 27 April 2026 and no-objection dated 18 May 2026. The award data does not show a signed Marquis Lot 3 contract.
Execution window
The tender-stage notice stated an 18-month construction period, while an older procurement plan carried a December 2026 planning date. Neither is treated as the current completion baseline because the signed contract records publish no notice to proceed, commencement date, site possession or revised completion date. Public evidence currently stops at contract award and World Bank no-objection.
Works package
The ESMP defines Lot 1 at Soubise as a 120 m reinforced-concrete walkway over the existing gabion wall with revetment rehabilitation, a new and upgraded boat-ramp interface, and 60 m of stepped concrete revetment with drainage and accessible steps and ramps. Lot 2 covers 200 m of southern rock-revetment work and rehabilitation plus 340 m north of the river mouth, using geofabric, graded core stone, toe excavation and two armour layers specified at 300-600 kg. The same design baseline includes a separate 100 m Marquis Lot 3 rock revetment, but no cited contract record confirms that package as awarded. The detailed Lot 1 scope states a 26 m new boat ramp while the equipment summary says 20 m; the accepted drawing or bill of quantities is needed to resolve that discrepancy.
Marine interfaces
Soubise's Eastern Main Road lies roughly 10-20 m from the shoreline, homes and commercial uses sit close to the water, and artisanal fishing and small-boat access continue in the nearshore zone. Lot 2's anticipated equipment list includes flat-deck barges, tugs or push boats, a heavy-lift crane barge, diver support, RTK-GPS and turbidity curtains. The key interfaces are in-water toe excavation and armour placement, river-outfall and drainage behaviour, road and community access, fishing-facility and boat-ramp continuity, turbidity control, and safe haulage through populated routes.
Commercial evidence boundary
The two World Bank records sum to USD 5,747,307.91, comprising USD 1,603,696.86 for Lot 1 and USD 4,143,611.05 for Lot 2. This total supersedes an older USD 4.2 million planning estimate for the awarded Soubise scope but does not establish a price for Marquis Lot 3. The ESMP names Mon Rush for aggregates and Mt. Hartman for armour rock only as potential licensed sources; it does not prove a purchase order, final quarry selection, haulage subcontract or material acceptance. No lower-tier works or marine-plant provider is publicly assigned.

Contract and delivery chain

Named roles and open packages

Named appointments are shown against the workstream they cover. Unallocated packages remain open until a project source identifies the responsible party.

Soubise Lot 1 South

GD-MOIID-420385-CW-RFB / contract 1885376

Named party
General Earth Movers-UEM Inc.
Status
Confirmed
Source position
World Bank contract data records a USD 1,603,696.86 works contract signed on 27 April 2026. Source
Soubise Lot 2 North

GD-MOIID-420385-CW-RFB / contract 1885375

Named party
Construction and Industrial Equipment
Status
Confirmed
Source position
World Bank contract data records a USD 4,143,611.05 works contract signed on 27 April 2026. Source
Design and construction supervision

Grenville, Soubise and Marquis coastal-works consultancy

Named party
Alpha Engineering & Design (2012) Ltd.
Status
Confirmed
Source position
The final ESIA and ESMP identify Alpha as the Government's project-specific design and supervision consultant. Source
Marquis Lot 3

100 m northern Marquis Bay rock revetment

Named party
Works contractor not identified
Status
Not evidenced
Source position
The ESMP defines the design lot, but the two current World Bank award records are expressly Soubise North and Soubise South. No cited contract record awards Marquis Lot 3.
Armour and aggregate supply

Potential Mon Rush aggregate and Mt. Hartman armour sources

Named party
Final suppliers and hauliers not identified
Status
Reported
Source position
The ESMP identifies both licensed quarries as potential sources only; no award, order, haulage contract or acceptance result is published. Source
Physical delivery

Mobilisation, nearshore works, installed quantities and acceptance

Named party
Ministry and the two signed works contractors
Status
Not evidenced
Source position
The cited sources publish award and design information but no notice to proceed, site activity, progress measurement, completion or acceptance.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

World Bank data reports no-objection for both signed Soubise contracts

The dataset carries the same no-objection date for both awards, while notice to proceed, site possession and mobilisation remain outside the published record.

Source

Two Soubise coastal-protection works contracts were signed

General Earth Movers-UEM Inc. took Lot 1 South and Construction and Industrial Equipment took Lot 2 North at a combined USD 5,747,307.91. The records do not include Marquis Lot 3.

Source

Final ESIA and ESMP established the three-lot design and safeguards baseline

The documents identify Alpha Engineering & Design, detailed Soubise quantities, a separate Marquis Lot 3, anticipated marine plant, potential quarry sources and environmental and community controls.

Source

The Ministry issued the international coastal-works RFB

The notice covered revetment, gabion and rock-armour works, used 70% technical and 30% cost weighting, and stated an 18-month tender-stage construction period.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Package-specific notice to proceed, site possession and accepted commencement date for each signed lot
  • Reconciliation of the 26 m detailed boat-ramp scope and 20 m equipment-summary statement
  • Final Lot 1 and Lot 2 drawings, bills of quantities and section boundaries
  • Any separate award, redesign or deferral for Marquis Lot 3
  • Armour-rock and aggregate quarry purchase orders, grading and acceptance tests
  • Barge, tug, heavy-lift crane barge, excavator, diving and survey providers
  • River-outfall, drainage, toe-level and overtopping interfaces
  • Traffic, community, fishing-facility and small-boat access controls
  • Turbidity, sargassum, waste and sensitive-nearshore monitoring
  • Installed quantities, as-built survey, completion and post-storm performance

Reporting status

Award, confirmed confidence

Last checked 7 August 2026 across 7 cited sources. The dated timeline above carries the project events.

Last checked 7 August 2026 Cited sources 7

Sources and related records

Read featured analysis Methodology Submit a correction Project tracker

Project sources 7
