Mokowe Fish Landing Site

Participation
Not assessed
Project facts checked

Gesken Enterprises holds the USD 1.852m contract signed on 11 June 2024; public sources define a jetty and land-reclamation workfront but do not confirm site-specific mobilisation, completion or acceptance

Project sources

Gesken Enterprises Ltd received the Mokowe Fish Landing Site contract from the State Department for USD 1,851,739.07. The design combines a modern fish-processing building and ablution block with land reclamation, a jetty, access and parking, drainage, water storage, wastewater treatment, power and lighting beside the existing Mokowe jetty in Lamu County. Package-specific mobilisation and completion remain unconfirmed.

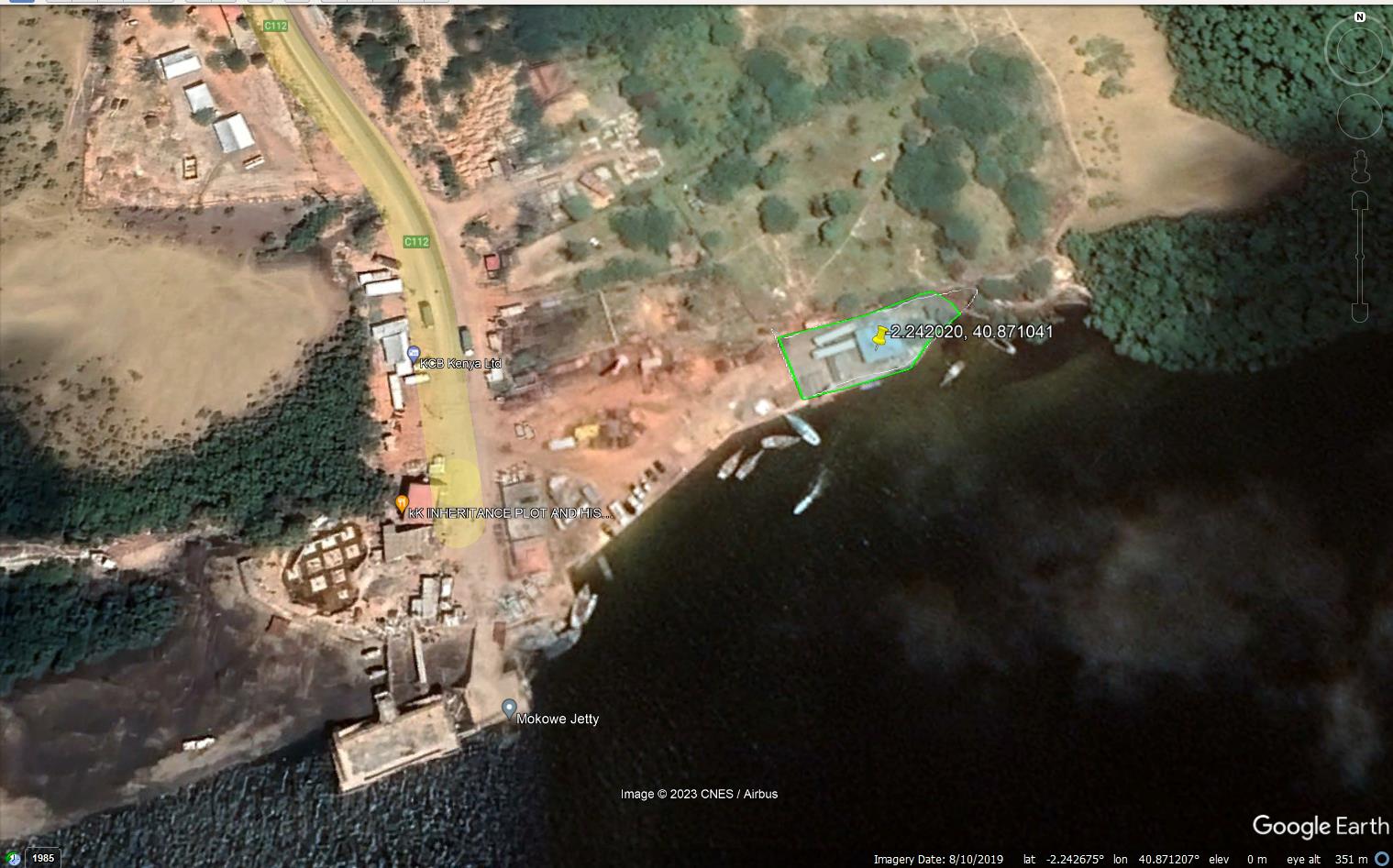

Official Mokowe ESIA aerial marking the proposed fish landing site beside the existing jetty in Lamu County

KEMFSED Mokowe ESIA, page 101; official site aerial, not evidence of mobilisation or completion

Location

Kenya / Africa

Segment

Port infrastructure

Phase

Award / Confirmed

Last checked

3 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Kenya State Department for the Blue Economy and Fisheries through KEMFSED, World Bank project P163980
Delivery parties
Gesken Enterprises Ltd - prime works contractor under KE-MOMBE&MA-LM-2024-010-CW
Contract route
The State Department procured Mokowe through a World Bank-financed Request for Bids subject to post review. Award data records contract 1793320 signed on 11 June 2024. Its scope excludes subcontract awards and cofinancing, so Gesken is a prime-award identification rather than evidence of the downstream marine supply chain.
Execution window
Mokowe's tender provided a 12-calendar-month works period. The December 2024 ESIA anticipated 12 months from site handover and six months of defects liability. Neither document confirms when handover occurred, whether the jetty work mobilised, or whether construction and defects close-out were achieved.
Works package
Build a modern fish-processing or fish-banda building, ablution block, gatehouse, boundary wall, driveway and parking, drainage, underground water tank, landscaping, pump and power rooms, mechanical and electrical services, street lighting, MBBR and biological wastewater treatment, dissolved-air flotation, land reclamation and a jetty.
Marine interfaces
The site sits beside the existing Mokowe jetty and the ESIA allocates a distinct land-reclamation and jetty workfront. Execution has to manage tidal access, shoreline fill, small-vessel landing, fish handling, drainage and wastewater controls. Public sources do not disclose fill quantities, jetty geometry, marine method, plant, lower-tier contractors or as-built acceptance.
Commercial evidence boundary
Award data records a USD 1,851,739.07 supplier commitment. The ESIA separately gives a KSh 239,337,275 engineer's estimate, including KSh 84,406,900 for land reclamation and jetty in its design-stage breakdown. These figures have different currencies and reporting boundaries; neither is verified actual spend.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Mokowe ESIA defined the jetty and reclamation workfront

The disclosed design identifies land reclamation, a jetty, wastewater treatment and shore-side facilities, but provides no evidence that marine mobilisation occurred.

Source

Gesken received the Mokowe works contract

World Bank contract 1793320 fixes Gesken Enterprises, reference KE-MOMBE&MA-LM-2024-010-CW and USD 1,851,739.07 committed supplier value; it does not disclose subcontractors.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Site handover and marine mobilisation
  • Land-reclamation quantities and fill source
  • Jetty designer, supplier and installer
  • Wastewater and power-system suppliers
  • Completion and defects certificates
  • Operational handover and landing performance

Reporting status

Project phase
Award
Evidence confidence
Confirmed
Last checked
3 August 2026
