Project record

Daba fishing port development

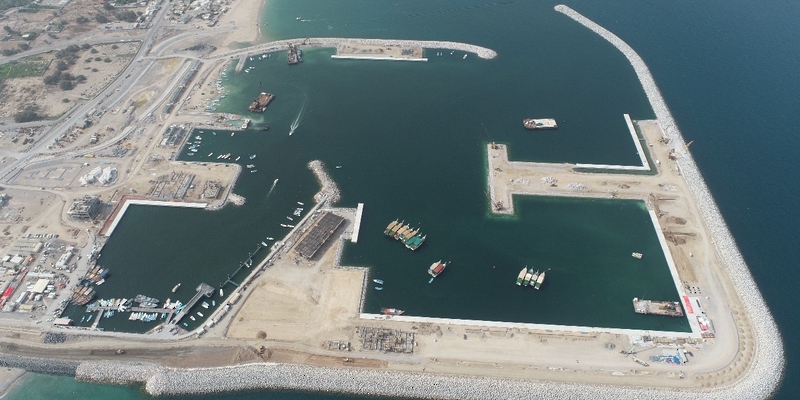

Aerial view of Daba fishing port construction, breakwaters, basin, concrete berths and pontoons

Oman News Agency; exact Daba fishing port construction progress

The Daba fishing-port development was awarded to Al Sarouj Constructions for approximately OMR 40 million in June 2020. The scope includes two kilometres of breakwaters, a basin reported to 10 m below lowest tide, 930 m of fixed berths across fishing, tourism and commercial uses, 270 m of floating berths in total, a 190 m small-boat beach and shore infrastructure. A June 2024 owner-side update reported 75% overall progress, all concrete berths complete, the boat ramp operating and cargo vessels already calling. Full-project completion and formal opening were targeted for Q1 2025 but remain unverified.

Project signal

Commissioning in Oman

Current status 75% complete in June 2024 with some facilities operating; full completion and formal opening remain unverified Source confidence Confirmed

Location

Oman / Middle East

Segment

Port infrastructure

Status

75% complete in June 2024 with some facilities operating; full completion and formal opening remain unverified / Confirmed

Last checked

1 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Oman Ministry of Agriculture, Fisheries and Water Resources
Delivery parties
Al Sarouj Constructions Company - main construction contractor, Pontoon, navigation-aid, berth-furniture, utility and equipment suppliers - not publicly identified in the reviewed records
Contract route
Government construction agreement signed with Al Sarouj Constructions on 14 June 2020 for approximately OMR 40 million.
Execution window
Contract signed in June 2020. Progress was reported at approximately 75% on 8 June 2024, with marine works expected to finish within two months and full opening targeted for Q1 2025. Those targets are not treated as achieved without a later completion record.
Works package
Construct 2,000 m of breakwaters and a harbour basin reported to 10 m below lowest tide; provide entrance navigation lights, roads, power, lighting, water and drainage. Berthing includes a 60 m fishing berth, 570 m tourism berth and 150 m commercial berth, plus two fishing pontoons totalling 70 m and tourism pontoons totalling 200 m, a 190 m small-boat beach, boat ramp and reclaimed commercial areas.
Marine interfaces
The multipurpose harbour combines fishing, tourism, cargo and Royal Oman Police users. Breakwater protection, basin depth, navigation lights, fixed and floating berths, utilities, cargo access and operating rules must therefore be accepted by user zone rather than inferred from a single overall percentage.
Commercial evidence boundary
The prime contractor and detailed base scope are public. The remaining intelligence gaps are specialist suppliers, final pontoon and navigation-aid installation, accepted depths, berth and utility handover, operating responsibility and proof that the targeted Q1 2025 full opening occurred.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

The Ministry reported 75% progress and partial use

All concrete berths were reported complete, the boat ramp was operating and cargo vessels had called, but the owner still targeted later marine completion and a Q1 2025 full opening.

Source

The Ministry signed the OMR 40 million Al Sarouj contract

The agreement established Al Sarouj as prime contractor and defined the breakwater, basin, fixed and floating berth, utility and multipurpose-user scope for delivery.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Full-project completion certificate and opening date
  • Final hydrographic survey and accepted 10 m basin condition
  • Navigation-light installation and port-entry approval
  • Floating pontoon, anchoring and gangway suppliers
  • Fenders, bollards, ladders and berth utilities
  • Tourism, cargo and fishing-zone handover
  • Port operator and maintenance responsibility
  • Repeat commercial and fishing vessel service

Reporting status

Commissioning, confirmed confidence

Last checked 1 August 2026 across 4 cited sources. The dated timeline above carries the project events.

Last checked 1 August 2026 Cited sources 4
