Snapper Creek State Boat Harbour shoreline protection works
Participation
Not assessed
Project facts checked
Queensland Transport and Main Roads disclosed Contract MSQ25017 with Hunter Contractors Pty Ltd at AUD 1,981,207 on 10 July 2025, and Maritime Safety Queensland announced a 2 September 2025 construction start; no cited official source confirms installed quantities, completion, acceptance or final account
Maritime Safety Queensland appointed Hunter Contractors Pty Ltd for shoreline protection at Snapper Creek State Boat Harbour under Contract MSQ25017. Queensland's contract disclosure records AUD 1,981,207 and a 10 July 2025 contract date. A 29 August owner notice said work was expected to start on 2 September and finish by November 2025, subject to weather and site conditions. The package covers two harbour areas: reconstruction of eastern rock-wall sections and western shoreline work beside the Esplanade access road. Physical completion and owner acceptance remain unconfirmed.
Port revetment repair and armour-rock placement is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Maritime Safety Queensland, Queensland Department of Transport and Main Roads
Delivery parties
Hunter Contractors Pty Ltd - appointed prime contractor under MSQ25017
Contract route
Queensland Transport and Main Roads' contract disclosure identifies MSQ25017 as an open-procurement contract with Hunter Contractors Pty Ltd, valued at AUD 1,981,207 and dated 10 July 2025. The disclosure does not name lower-tier contractors or suppliers.
Execution window
Maritime Safety Queensland's 29 August 2025 notice expected construction to commence on 2 September and complete by November 2025, weather and site conditions permitting. Those dates establish the owner baseline only; actual completion remains unconfirmed.
Works package

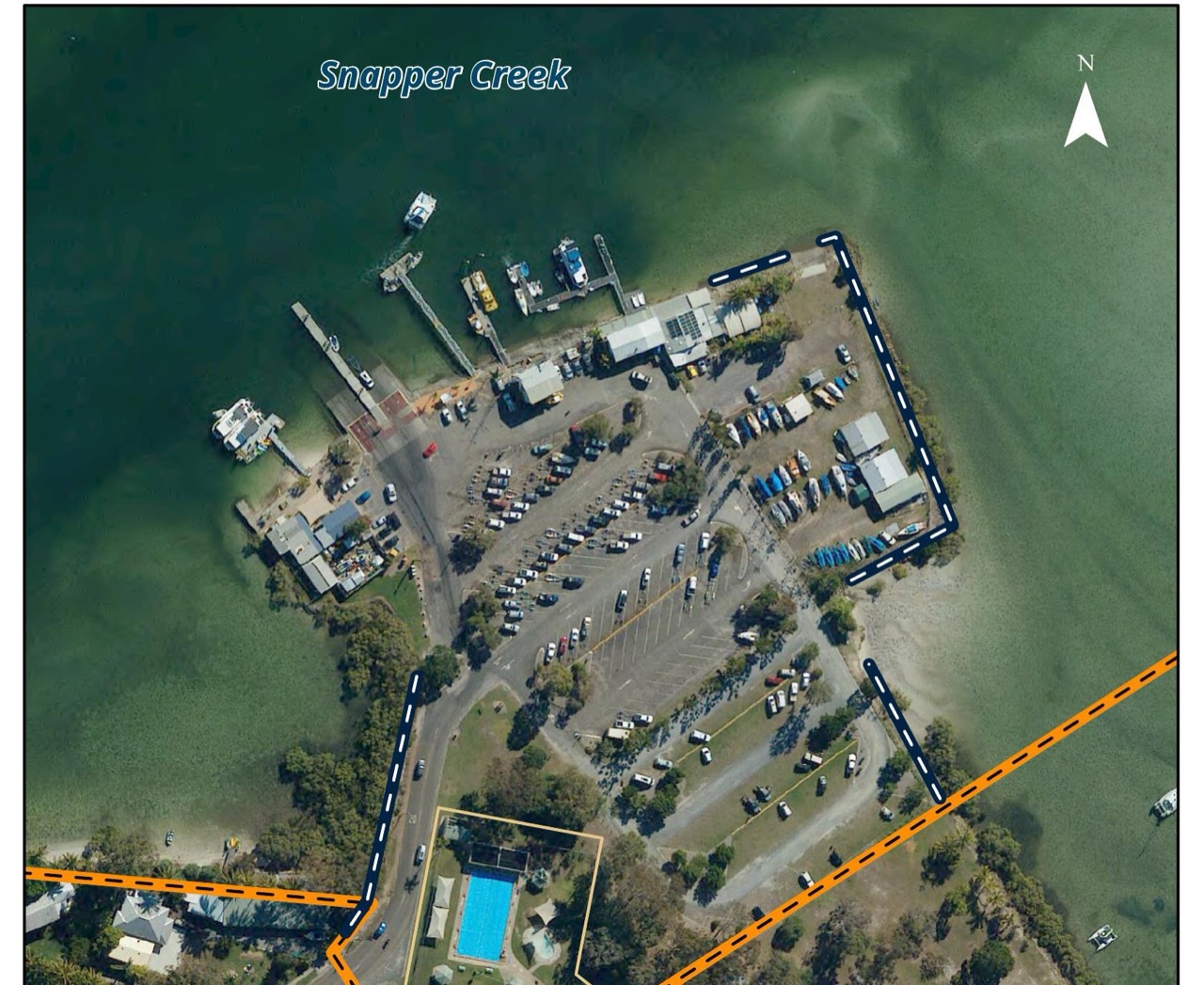

Reconstruct sections of the eastern rock wall and undertake shoreline protection beside the Esplanade access road on the western side of the harbour. The official map marks two shoreline protection work areas within the state boat harbour boundary.
Marine interfaces
The state boat harbour remained operational during the planned works. Maritime Safety Queensland said public boat ramps and parking, harbour businesses and adjacent parkland access would remain available. Western works required one-way traffic-light control on the Esplanade access road, and mariners and the public were asked to use caution around the land and on-water worksite.
Commercial evidence boundary
The disclosed contract value is AUD 1,981,207. No cited source provides a variation ledger, payment status, subcontract values, final cost or close-out account. The appointment confirms Hunter Contractors as prime but does not identify quarry, haulage, survey, testing, marine-plant or other lower tiers.
Contract and delivery chain
Work packages and named roles
Published scope, named parties and supporting evidence for each workstream.
Prime contract
MSQ25017 Snapper Creek Boat Harbour Revetment Construction 2025
Named party
Hunter Contractors Pty Ltd
Evidence status
Confirmed
Source position
Queensland's contract disclosure records Hunter Contractors, open procurement, AUD 1,981,207 and a 10 July 2025 contract date. Source
Eastern shoreline
Rock-wall reconstruction
Named party
Hunter Contractors Pty Ltd
Evidence status
Confirmed
Source position
The owner start notice identifies reconstruction of eastern rock-wall sections within one of two mapped work areas. Source
Western shoreline
Esplanade access-road shoreline protection
Named party
Hunter Contractors Pty Ltd
Evidence status
Confirmed
Source position
The owner notice locates western work beside the Esplanade access road and identifies one-way traffic-light control during delivery. Source
Physical delivery
Installed quantities, completion and acceptance
Named party
Maritime Safety Queensland and Hunter Contractors Pty Ltd
Evidence status
Not evidenced
Source position
The cited official records contain a planned start and forecast completion but no later completion, acceptance or final-account evidence.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Maritime Safety Queensland's project map marked the eastern harbour perimeter and western Esplanade shoreline work areas within the state boat harbour limit.
The contract disclosure records Hunter Contractors, open procurement and AUD 1,981,207 for the Snapper Creek revetment package, establishing the prime commercial baseline.
