Project record

Saint-Edouard-de-Kent containment-cell reconstruction

Participation
Not assessed
Project facts checked

Christian Larocque Services LTEE received the CAD 347,878.45 construction contract in November 2021; Harbourside Engineering reports the rebuilt dredge-spoil containment cell completed in March 2022

Project sources

PSPC awarded Christian Larocque Services LTEE CAD 347,878.45 contract EC015-221514/001/PWJ on 29 November 2021 to reconstruct the containment cell at Saint-Edouard-de-Kent Harbour for Fisheries and Oceans Canada Small Craft Harbours. Harbourside Engineering, the retained prime consultant and designer, says the project was completed in March 2022 after replacing the existing cell within its footprint with a deeper lined facility, a crushed-sandstone perimeter berm and riprap. A separate 2026 four-channel dredging contract names ASDR Canada Inc. at CAD 1,358,150; that later package includes Saint Edouard Channel but is not the containment-cell construction contract.

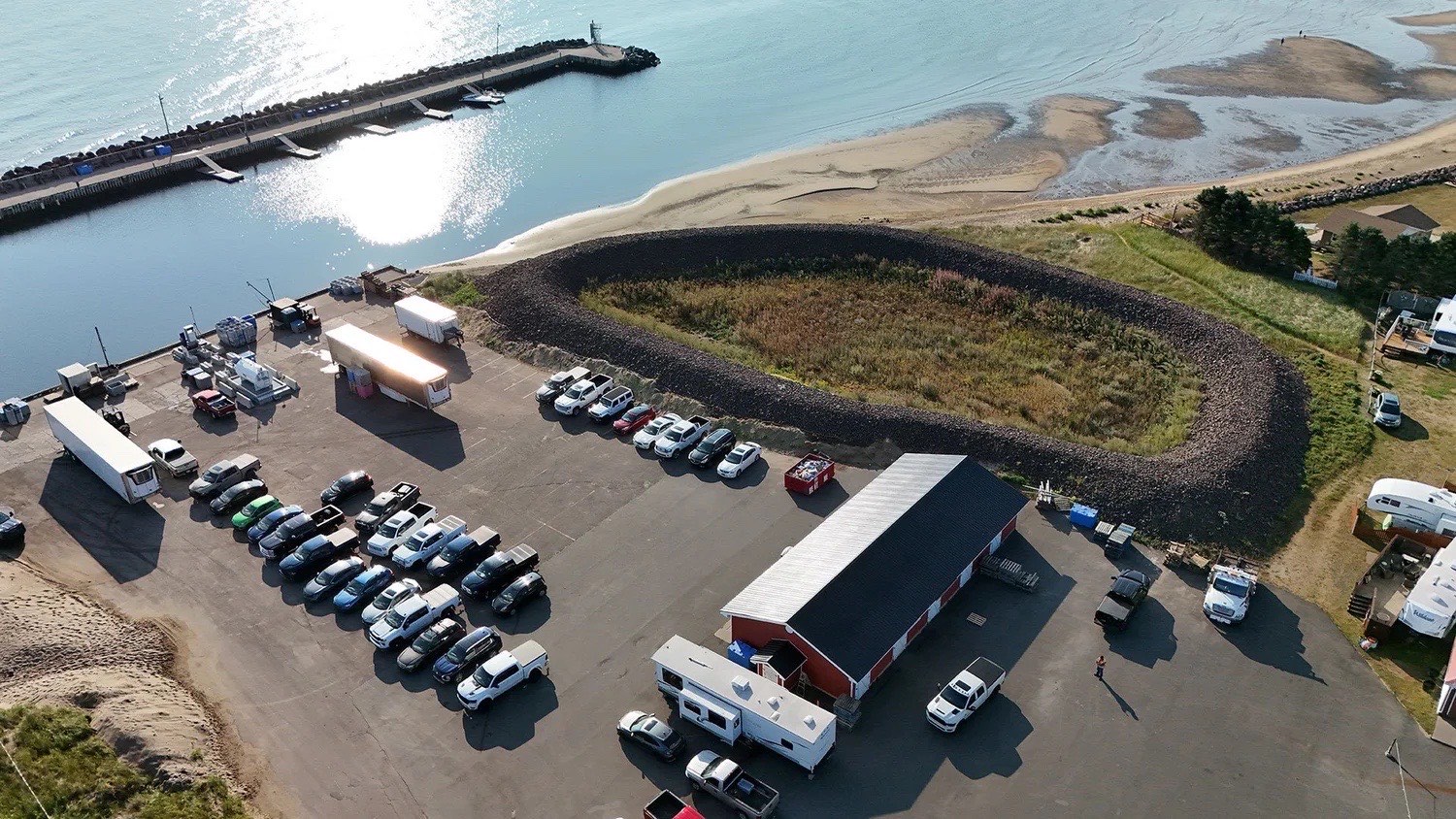

Exact-site aerial view of the rebuilt dredge spoils containment cell and riprap berm beside Saint-Edouard-de-Kent Harbour

Harbourside Engineering Group; exact-site project image published with its Saint-Edouard-de-Kent containment-cell case study

Location

Canada / Americas

Segment

Fishing harbour wharf, dredging and shore protection

Phase

Completed / Confirmed

Last checked

12 August 2026

Coverage

Related sectors

Fishing harbour wharf, dredging and shore protection is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Fisheries and Oceans Canada - Small Craft Harbours, with Public Services and Procurement Canada managing design and construction procurement
Delivery parties
Christian Larocque Services LTEE - construction prime under EC015-221514/001/PWJ, Harbourside Engineering Consultants - prime design consultant and tender/construction technical support, Survey, testing, trucking, disposal, stone and other lower tiers - not named in the cited public records
Contract route
PSPC issued open competition EC015-221514/A for DFO Small Craft Harbours and awarded the lowest-price bid to Christian Larocque Services LTEE on 29 November 2021. CanadaBuys records CAD 347,878.45 and General Marine Construction Work. Harbourside identifies a separate client engagement for design, geotechnical investigation, tender documents, environmental support and construction-phase technical queries but publishes no consultant fee.
Execution window
The tender required completion by 31 March 2022. Harbourside gives a 2021-2022 timeframe and reports completion in March 2022. Still unpublished are the notice to proceed, daily production, substantial-completion certificate, accepted quantities, payment history and final account.
Works package
The project removed existing dredge spoils, reconstructed the containment cell within the same footprint, increased depth and storage capacity, and added a liner, crushed-sandstone berm and riprap. Design work included test pits, soil sampling, a geotechnical report, berm-stability analysis, topographic survey, utility-clearance review, Civil 3D cut-and-fill modelling, environmental drawings and tender documents. Existing spoils were to be trucked to an approved facility until the new cell was available.
Marine interfaces
The cell is shore infrastructure for harbour dredging rather than a standalone earthworks package. Its berm geometry, liner, filtration and drainage capacity govern how cutter-suction dredge water and sediment can be received, while off-site handling of existing material links marine production to trucking, disposal approvals and environmental compliance.
Commercial evidence boundary
CAD 347,878.45 is the reported construction-contract total for EC015-221514/001/PWJ. No cited source breaks out dredge-spoil removal, trucking, disposal, liner, sandstone, riprap, survey, testing or consultant services. ASDR Canada's CAD 1,358,150 award belongs to a separate 2026 four-channel dredging package and is not a variation or final account on this cell.

Contract and delivery chain

Work packages and named roles

Published scope, named parties and supporting evidence for each workstream.

Design and geotechnical

Containment-cell investigation, detailed design and tender support

Named party
Harbourside Engineering Consultants
Evidence status
Confirmed
Source position
Harbourside identifies itself as prime consultant for site inspection, test pits, soil sampling, berm analysis, topographic survey, Civil 3D modelling, tender documents and construction-phase technical support. Source
Construction prime

EC015-221514/001/PWJ containment-cell reconstruction

Named party
Christian Larocque Services LTEE
Evidence status
Confirmed
Source position
CanadaBuys records the 29 November 2021 award at CAD 347,878.45 following open lowest-price competition. Source
Environmental determination

Cell reconstruction and harbour dredging

Named party
Fisheries and Oceans Canada - Small Craft Harbours
Evidence status
Confirmed
Source position
The federal registry records a 5 October 2021 determination that the project could proceed with mitigation after assessment of cell reconstruction, spoil handling and harbour dredging. Source
Completion

Rebuilt lined cell, sandstone berm and riprap

Named party
PSPC, DFO-SCH, Harbourside Engineering and Christian Larocque Services LTEE
Evidence status
Reported
Source position
Harbourside reports project completion in March 2022 and publishes exact-site imagery; no public owner acceptance certificate or final account was found. Source
Later channel dredging

CW2443650 four-channel floating-plant dredging

Named party
ASDR Canada Inc.
Evidence status
Confirmed
Source position
CanadaBuys separately records a CAD 1,358,150 award covering Chockpish, Les Aboiteaux, Saint Edouard and Caissie Cape; it is not the containment-cell construction contract. Source

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

ASDR Canada received a separate four-channel dredging award

CW2443650 added a current Saint Edouard channel workstream inside a CAD 1.358 million multi-site package without changing the 2021 cell contract or proving material placement into the cell.

Source

Harbourside reports the containment-cell project completed

The consultant's completion report and exact-site imagery move the cell from an administrative award to reported physical completion, while owner acceptance and final account remain unpublished.

Source

Christian Larocque Services received the construction award

PSPC fixed the named construction prime and CAD 347,878.45 value after an open lowest-price competition for the cell reconstruction package.

Source

DFO-SCH issued the environmental determination

The federal determination allowed existing-spoil removal, cell reconstruction and harbour dredging to proceed with the mitigation measures identified in the assessment.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • As-built cell geometry, storage capacity and liner details
  • Final construction account and owner acceptance certificate
  • Existing-spoil trucking, approved disposal and sediment records
  • Named testing, surveying, hauling, stone and other lower tiers
  • Cell filtration, drainage and berm-stability performance
  • Material received from later Saint Edouard channel dredging
  • ASDR Canada's separate 2026 dredging mobilisation and measured volume

Reporting status

Project phase
Completed
Evidence confidence
Confirmed
Last checked
12 August 2026
Cited sources
6
