Project record

Dakar Mamelles desalination intake and brine discharge

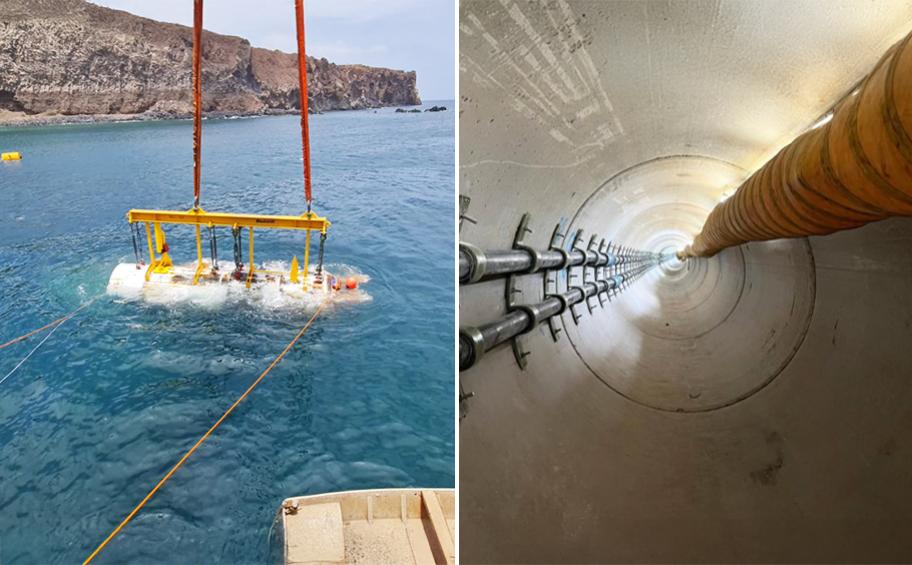

Split view of an offshore intake structure being lowered beside the Mamelles coast and the intake pipe inside its concrete microtunnel

Eiffage Génie Civil Marine, Mamelles project update

Dakar's first large seawater desalination plant is in its commissioning year after Eiffage recorded a 340 m seawater-intake microtunnel milestone in July 2025. The 50,000 m3/day plant was still under construction during a supervision visit in February 2026. The older JICA design basis also carried a separate 500 m brine-discharge line; current public updates leave its final geometry, installation and marine acceptance unconfirmed.

Project signal

Construction in Senegal

Current status Plant remained under construction in February 2026; commissioning was expected later in 2026, while final marine handover evidence remains unpublished Source confidence Confirmed

Location

Senegal / Africa

Segment

Marine utilities

Status

Plant remained under construction in February 2026; commissioning was expected later in 2026, while final marine handover evidence remains unpublished / Confirmed

Last checked

19 July 2026

Coverage

Related sectors

Marine utilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Société Nationale des Eaux du Sénégal (SONES)
Delivery parties
Toyota Tsusho-led consortium with Eiffage Génie Civil and VA Tech Wabag, TPF consultancy and supervision
Contract route
JICA ODA loan SE-P3; international competitive CP-1 design-build and operating package awarded to the Toyota Tsusho-led consortium, with two years of operation and maintenance after construction
Execution window
Toyota Tsusho's 2022 order carried a 2025 planned completion. TPF's 10 February 2026 visit still described the plant as under construction and expected commissioning later in 2026. JICA's May 2026 Senegal programme lists the wider Mamelles programme through 2029.
Works package
Initial 50,000 m3/day seawater reverse-osmosis plant expandable to 100,000 m3/day; seawater intake and pumping, intake transmission, brine discharge, treatment, product-water pumping and transmission, power connection, distribution-main installation and wider Dakar network renewal
Marine interfaces
Eiffage recorded a 340 m seawater-intake microtunnel drive in July 2025. The 2015 JICA preparation basis carried two 1,200 mm intake lines of about 350 m each and a 710 mm brine-discharge line of about 500 m, but later public construction updates reviewed by IMWO do not reconcile the final discharge geometry or publish marine acceptance.
Commercial evidence boundary
The main plant contract is in construction, not a new tender. The open specialist questions now sit at the interface between completed intake tunnelling, discharge installation, process commissioning and owner acceptance. The original 2025 completion date has passed, while the wider JICA programme continues beyond the plant's stated 2026 commissioning target.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

The plant remained under construction in its commissioning year

TPF's supervision visit confirmed active construction and an expectation of commissioning later in 2026, superseding the original 2025 completion plan without proving operating release.

Source

Eiffage recorded the 340 m intake microtunnel milestone

The intake route moved from design into physical evidence. The update did not publish final brine-discharge installation or marine acceptance.

Source

The main plant and operating order was announced

Toyota Tsusho identified the SONES client, consortium, initial 50,000 m3/day capacity and two-year O&M obligation, with an original 2025 completion plan.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Final intake geometry and hydraulic testing
  • Brine-discharge line, head and diffuser installation
  • Marine survey and environmental acceptance
  • Process wet commissioning and first water
  • 50,000 m3/day performance test
  • Power and product-water network readiness
  • Owner operating release and two-year O&M start
  • Phase 2 expansion boundary to 100,000 m3/day

Reporting status

Construction, confirmed confidence

Last checked 19 July 2026 across 6 cited sources. The dated timeline above carries the project events.

Last checked 19 July 2026 Cited sources 6
