Singapore's Tuas Water Reclamation Plant incorporates a 1.8 km pipe, increasing from 1.2 m to 3 m in diameter, to convey treated effluent to a nearshore sea outfall. PUB records the outfall and other Contract 1A permanent works as substantially completed on 14 August 2023. That did not complete the wider water system: PUB's December 2025 update put DTSS Phase 2 at about 80% and Tuas WRP at 57%, while the current programme page schedules phased commissioning from 2027.
Project signal
Construction in Singapore
Current statusNearshore outfall and Contract 1A permanent works were substantially completed on 14 August 2023; wider DTSS2 and Tuas WRP completion, commissioning and discharge acceptance remain openSource confidenceConfirmed
Location
Singapore / Asia Pacific
Segment
Marine utilities
Status
Nearshore outfall and Contract 1A permanent works were substantially completed on 14 August 2023; wider DTSS2 and Tuas WRP completion, commissioning and discharge acceptance remain open / Confirmed
Last checked
16 July 2026
Coverage
Related sectors
Marine utilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
PUB, Singapore's National Water Agency
Delivery parties
McConnell Dowell South East Asia - Contract 1A Site Development Works, including the nearshore outfall, Jacobs - DTSS Phase 2 programme management and engineering consultancy
Contract route
PUB delivered DTSS Phase 2 and Tuas WRP through multiple public works and engineering packages. Contract 1A combined site development, common utilities and the nearshore outfall; McConnell Dowell began that package in January 2019 after PUB called the first Tuas WRP tenders in May 2018.
Execution window
PUB called the first Tuas WRP tenders in May 2018 and records McConnell Dowell beginning Contract 1A in January 2019. The nearshore outfall and other permanent Contract 1A works were substantially completed on 14 August 2023. At December 2025 the overall DTSS Phase 2 programme was about 80% complete and Tuas WRP was 57%; the current owner programme schedules phased commissioning from 2027.
Works package
A 1.8 km treated-effluent pipe to the nearshore outfall, ranging from 1.2 m to 3 m in diameter, delivered within site-development works that also provided common roads, drainage and utilities for the wider Tuas WRP construction programme.
Marine interfaces
The marine boundary is the final treated-effluent route from Tuas WRP through the large-diameter outfall pipe to sea discharge. Civil completion of that route must interface with completed treatment processes, plant hydraulics, mechanical and electrical systems, monitoring, discharge controls and the wider DTSS conveyance network before operational performance can be established.
Commercial evidence boundary
The named outfall civil package is a completed delivery reference, not an open construction award. Remaining work covers plant and network completion, MEICA integration, hydraulic and wet commissioning, water-quality and environmental verification, instrumentation, inspection, maintenance planning and the operating handover that will turn the installed outfall into a controlled discharge asset.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
PUB current programme retains phased commissioning from 2027
The owner schedule keeps whole-system operation as a future gate despite the earlier outfall civil milestone. A commissioning target does not establish first discharge or accepted performance.
All five tunnel contracts had received statutory completion certificates, while plant MEICA work and critical influent-shaft interfaces remained active. The outfall could not be read independently from that unfinished system.
Plant testing began within a still-incomplete programme
PUB reported DTSS2 at 77% and Tuas WRP at 54%, with MEICA installation continuing and hydraulic testing under way at selected biosolids facilities. Local tests were not whole-system discharge acceptance.
Nearshore outfall and Contract 1A permanent works substantially completed
The milestone closed the principal outfall civil package while wider plant, conveyance, commissioning and environmental-performance gates remained open.

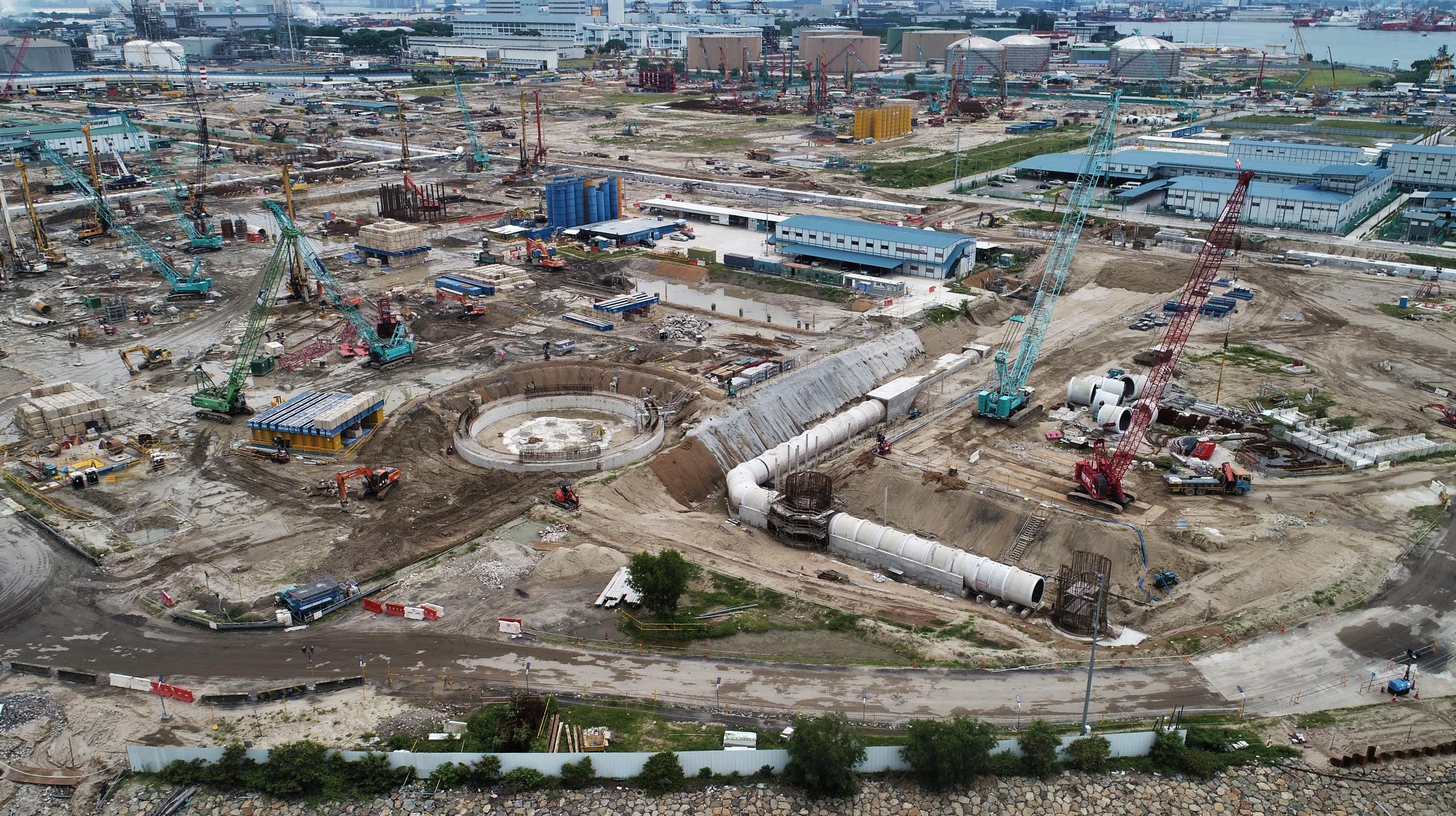

PUB documented the outfall pipe under installation
The owner fixed the physical scope at a 1.8 km treated-effluent pipe with diameters from 1.2 m to 3 m, providing project-specific evidence rather than a generic coastal-utility inference.
The site-development and nearshore-outfall scope entered formal procurement as part of a wider multi-package water-reclamation programme, establishing a traceable package baseline before award and construction.
