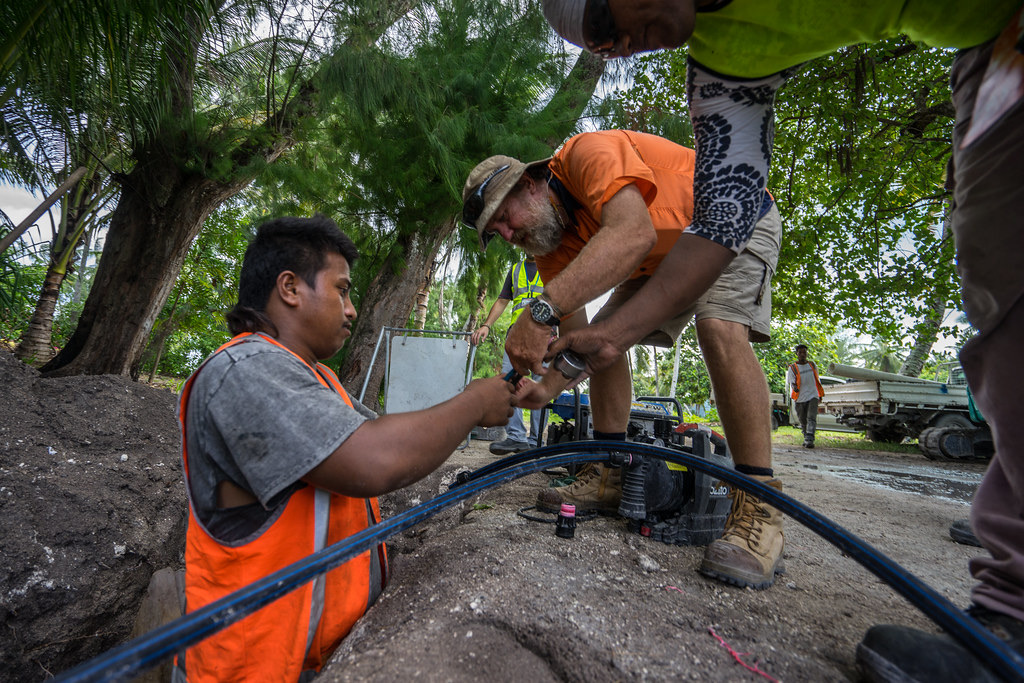

South Tarawa's ADB-financed sanitation programme rehabilitated sewerage and saltwater systems and rebuilt three ocean outfalls serving Betio, Bairiki and Bikenibeu. ADB's completion report records the outfall package awarded on 29 July 2016, civil work completed in August 2018, testing and commissioning in Q2 2019, and whole-project physical completion on 31 December 2019. The same report keeps delivery and outcome separate: the infrastructure was complete, but access and water-quality indicators were only partly achieved, and ADB's independent validation later rated the project less than successful.
Project signal
Completed in Kiribati
Current statusADB records the three-outfall civil package completed in August 2018, testing and commissioning in Q2 2019, the wider project physically completed on 31 December 2019, and the financing operation closedSource confidenceConfirmed
Location
Kiribati / Global islands
Segment
Marine utilities
Status
ADB records the three-outfall civil package completed in August 2018, testing and commissioning in Q2 2019, the wider project physically completed on 31 December 2019, and the financing operation closed / Confirmed
Last checked
12 August 2026
Coverage
Related sectors
Marine utilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Government of Kiribati; Ministry of Finance and Economic Development with the public works ministry and Public Utilities Board
Delivery parties
CCB Envico Pty Ltd - contractor for the two major civil works packages
Contract route
ADB-supported international competitive bidding split the main works between ICB01 for sewerage and saltwater-system rehabilitation and ICB02 for the ocean outfalls. The original outfall concept required redesign and retendering before the ICB02 award on 29 July 2016; supplemental ADB financing covered the resulting cost increase.
Execution window
The programme was approved in October 2011. ICB02 was awarded on 29 July 2016, outfall civil work was completed in August 2018, testing and commissioning followed in Q2 2019, and whole-project physical completion was recorded on 31 December 2019. ADB published its completion report on 25 January 2024 and an independent validation on 15 October 2024.
Works package
Rehabilitation of sewerage and saltwater systems in South Tarawa's main urban areas, plus replacement and upgrading of three ocean sewage outfall pipe and diffuser systems at Betio, Bairiki and Bikenibeu, associated pumping interfaces, environmental controls, testing, commissioning, and operator support.
Marine interfaces
The marine boundary includes three coastal outfall alignments and diffuser assemblies, outfall pumping stations, shoreline and reef crossings, environmental licences, construction controls, commissioning, plume behaviour, and receiving-water monitoring. The completed outfalls remain operating marine assets whose condition and discharge performance must be evidenced separately from civil completion.
Commercial evidence boundary
South Tarawa is a completed reference rather than an open works opportunity. Its continuing market lies in retrofit, inspection, asset management, pump and pipeline maintenance, environmental monitoring and operator capability. ADB's completion and validation records also separate contractor delivery, system commissioning, service coverage, water quality and institutional sustainability.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Independent validation rated the completed project less than successful
The validation preserves the record of completed infrastructure but shows that physical delivery, service outcomes, water quality and institutional sustainability require separate evidence.
The report records the contractor, redesign and retender history, package completion, commissioning, physical completion and mixed outcome evidence. It is the controlling retrospective delivery source.
Physical completion followed the earlier outfall works and Q2 2019 testing and commissioning. It does not by itself prove continuing discharge compliance, universal connections or funded long-term maintenance.
Civil completion closed the main offshore construction package at Betio, Bairiki and Bikenibeu; commissioning, plume monitoring and operating performance remained later gates.
The award followed cancellation, redesign and retender of the earlier concept. It established a delivery contract but did not establish completed works or compliant discharge performance.
