Location
Spain / Europe
Project record

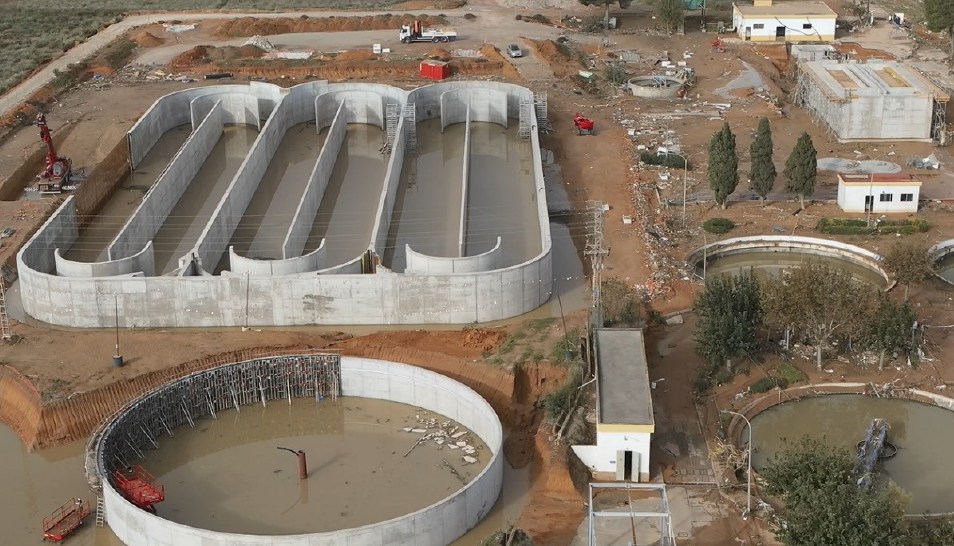

Spain's Directorate-General for Water signed contract 08.346-0683/2111 with the Global Omnium Medioambiente-CICLAGUA-BECSA UTE on 17 July 2023 for EUR 20,793,692.54 excluding VAT. CHJ records the setting-out check on 18 September 2023 and the start of the 30-month execution clock on 19 September 2023; its current works register still lists the adaptation in execution. The 18,000 m3/day design combines conventional aerobic treatment with an anaerobic membrane bioreactor, tertiary treatment, a new sludge line, storm-overflow storage, deodorisation and an agricultural reuse connection. CHJ's 2025 ledger reports EUR 997,242.85 certified against modification 1 and EUR 854,404.65 against emergency lot 1. PLACSP's later 10 August 2026 modification record adds zero euros and zero months. These certified amounts are not contract-value changes, and the post-DANA flood-defence and setback package remains outside the main UTE ledger.
Spain / Europe
Urban wastewater treatment, tertiary reuse and flood resilience
CHJ currently lists the Torrent adaptation works in execution under the Global Omnium Medioambiente-CICLAGUA-BECSA UTE; its 2025 delivery report fixes the site-start baseline at 19 September 2023 and records separate certified amounts for modification 1 and the post-DANA emergency workfront, while PLACSP's 10 August 2026 modification record adds zero price and zero duration / Confirmed
12 August 2026
Coverage
Urban wastewater treatment, tertiary reuse and flood resilience is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract and delivery chain
Named appointments are shown against the workstream they cover. Unallocated packages remain open until a project source identifies the responsible party.
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogThe structured record adds zero euros and zero months, preserves a 30-month final duration and leaves the modification reason and physical status unexplained.
SourceFlood defence and setback of the adaptation works becomes a distinct approximately EUR 6.2 million interface rather than an assumed addition to the main UTE contract.
SourceCHJ's 2025 delivery report fixes the setting-out check on 18 September 2023 and the contract execution-period start on 19 September 2023, replacing the earlier unknown-start assumption without establishing the post-DANA baseline.
SourceThe Directorate-General for Water formalises the 30-month EUR 20.794 million excluding-VAT contract with the three-company UTE, establishing the legal works package but not its operative site-start date.
SourceEvidence gap
