Great Lakes holds the USD 219.108 million Contract 6 obligation; its USD 235.423 million potential value, April 2027 owner finish, production, assigned fleet and lower tiers remain to be confirmed
U.S. Army Corps of Engineers contract W912HY24C0016 places Great Lakes Dredge & Dock on approximately 41 miles of Sabine-Neches entrance-channel deepening and extension. USACE's pre-bid scope carried about 35.8 million cubic yards of hopper dredging, while USAspending reports USD 219,108,350 in current obligations and USD 235,422,810 as potential value with all options. Sabine-Neches Navigation District expects the package to finish in April 2027, but the reviewed public chain does not isolate current production, assigned dredges, accepted quantities or named lower-tier firms.
Dredging and waterways is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
U.S. Army Corps of Engineers, Galveston District, with Sabine-Neches Navigation District as local non-federal sponsor
Delivery parties
Great Lakes Dredge & Dock Co., LLC - prime contractor under W912HY24C0016, Hopper-dredging support, survey, disposal, marine services and other lower tiers - not named in the cited public records; USAspending reports zero subaward actions
Contract route
USAspending records a firm-fixed-price definitive contract under sealed-bid solicitation W912HY24B0021. The procurement used full and open competition with no set-aside, received two offers and required an individual subcontracting plan. The award was signed on 20 September 2024 to Great Lakes Dredge & Dock Co., LLC under NAICS 237990 and PSC Z1KB.
Execution window
The federal award period runs from 20 September 2024 to 4 April 2027 and was last modified in the USAspending summary on 6 March 2025. Great Lakes' October 2024 announcement expected work to start in mid-2025 and finish in late 2026. SNND's November 2025 package schedule instead expected Contract 6 to finish in April 2027. The two forecasts should be treated as dated schedule snapshots rather than proof of delay, mobilisation or completion.
Works package
USACE defined about 41 miles of Contract 6 channel work: approximately 28 miles of existing channel from Sabine Bank Channel to the inland end of Sabine Pass Channel plus a roughly 13-mile offshore extension. The pre-bid notice estimated 35.8 million cubic yards, split between about 6.9 million cubic yards of shoaled material and 28.9 million cubic yards of new work, to be removed by hopper dredging. The wider authorized geometry deepens offshore reaches from 42 to 50 feet MLLW and the Sabine Pass Jetty and inland reaches from 40 to 48 feet, while Contracts 7 through 9 remain separate later packages.
Marine interfaces

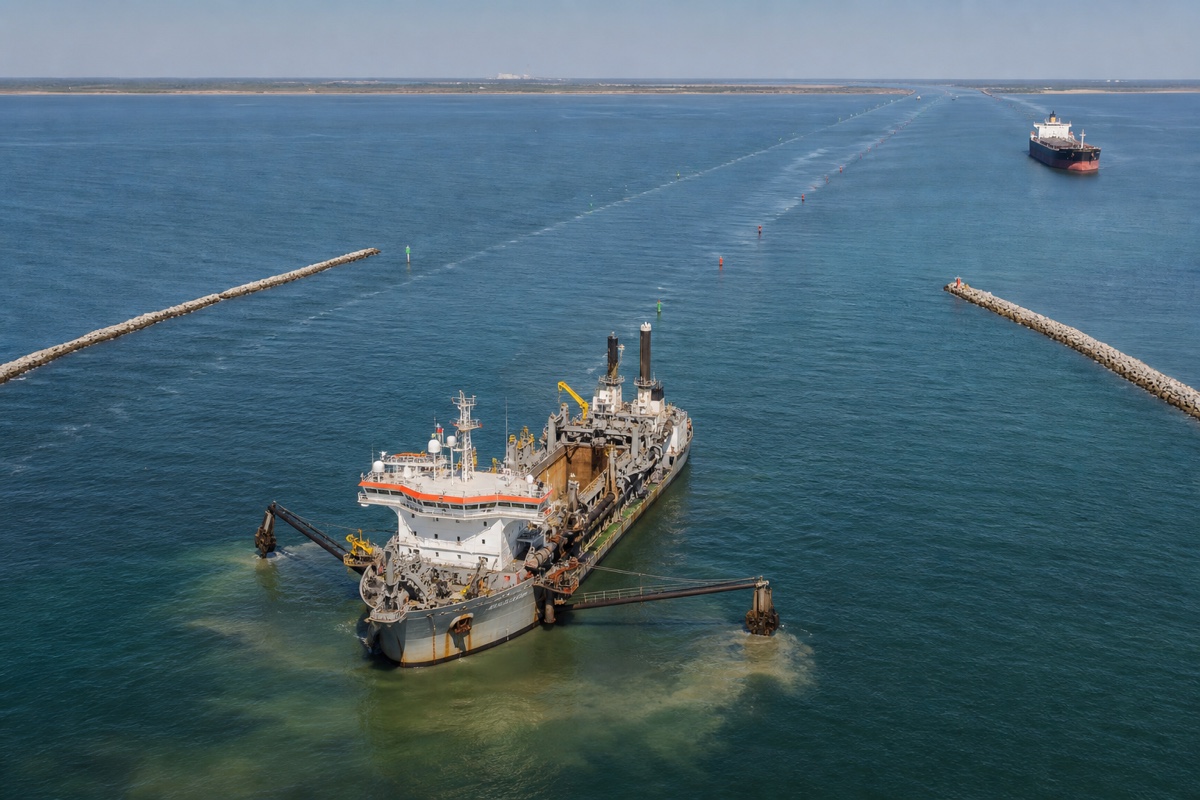

Contract 6 crosses the open-Gulf extension, Sabine Bank, Outer Bar, Jetty and Pass approaches serving a high-volume liquid-bulk, LNG, petrochemical and military waterway. Delivery depends on hopper-dredge production, live-traffic separation, sediment classification, ocean or approved placement routing, environmental controls, buoyed-channel management and repeated pre- and post-dredge hydrography. A survey date or elapsed contract period does not establish accepted volume or navigation availability.
Commercial evidence boundary
USAspending currently reports USD 219,108,350 both as total obligation and base plus exercised options, and USD 235,422,810 as base plus all options. A later USACE contractor briefing listed USD 235,245,750 as total contract value, while Great Lakes reported a rounded USD 235 million base-and-open-options total and initially described about USD 16 million of options pending. These are defensible dated snapshots with different definitions and update times; none should be presented as a certified final account.
Contract and delivery chain
Work packages and named roles
Published scope, named parties and supporting evidence for each workstream.
USACE Galveston District and Sabine-Neches Navigation District
Evidence status
Confirmed
Source position
USACE identifies itself as Contract 6 client and SNND as the local non-federal sponsor within the authorized channel-improvement programme. Source
Prime award
W912HY24C0016 hopper-dredging contract
Named party
Great Lakes Dredge & Dock Co., LLC
Evidence status
Confirmed
Source position
USAspending records Great Lakes as recipient, USD 219,108,350 in current obligations and USD 235,422,810 as potential value with all options. Source
Competition and contract form
W912HY24B0021 solicitation and resulting award
Named party
USACE Galveston District and Great Lakes
Evidence status
Confirmed
Source position
The federal record identifies a sealed bid, full and open competition, two offers, no set-aside, firm-fixed-price terms and an individual subcontracting plan. Source
Dredging scope
Offshore extension and entrance-channel second cut
Named party
USACE Galveston District
Evidence status
Confirmed
Source position
USACE's pre-bid notice defines approximately 41 miles and 35.8 million cubic yards of hopper dredging, including 6.9 million cubic yards of shoal and 28.9 million cubic yards of new work. Source
Delivery schedule
Contract 6 completion window
Named party
USACE, SNND and Great Lakes
Evidence status
Confirmed
Source position
The federal award currently ends on 4 April 2027, SNND expected an April 2027 finish, and Great Lakes' earlier award announcement carried a late-2026 estimate. Source
Hydrographic monitoring
Sabine Bank, Outer Bar, Jetty and Pass surveys
Named party
USACE Galveston District
Evidence status
Confirmed
Source position
USACE lists current 2026 surveys across Contract 6 reaches. Those publications establish monitoring activity, not Contract 6 production, achieved depth or acceptance. Source
Fleet allocation
Hopper dredges and support craft
Named party
Great Lakes and undisclosed delivery parties
Evidence status
Undisclosed
Source position
Great Lakes publishes a broad hopper fleet and Sabine-Neches programme imagery, but the reviewed records do not assign a named dredge or support craft specifically to Contract 6.
Lower-tier supply chain
Survey, marine services, disposal and other subcontract packages
Named party
Undisclosed lower tiers
Evidence status
Undisclosed
Source position
USAspending records an individual subcontracting plan and zero reported subaward actions. That combination does not identify firms and does not prove that no lower-tier work occurred. Source
Completion and acceptance
Final quantity, placement, hydrography and account
Named party
USACE Galveston District and Great Lakes
Evidence status
Not evidenced
Source position
The public chain reviewed through 6 August 2026 does not provide accepted quantities, completed placement, final hydrographic acceptance, demobilisation or a certified final account.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
W912HY24C0016 federal award recordUSAspending.gov, U.S. Department of the Treasury, Award signed 20 September 2024; record last modified 6 March 2025; reviewed 6 August 2026
