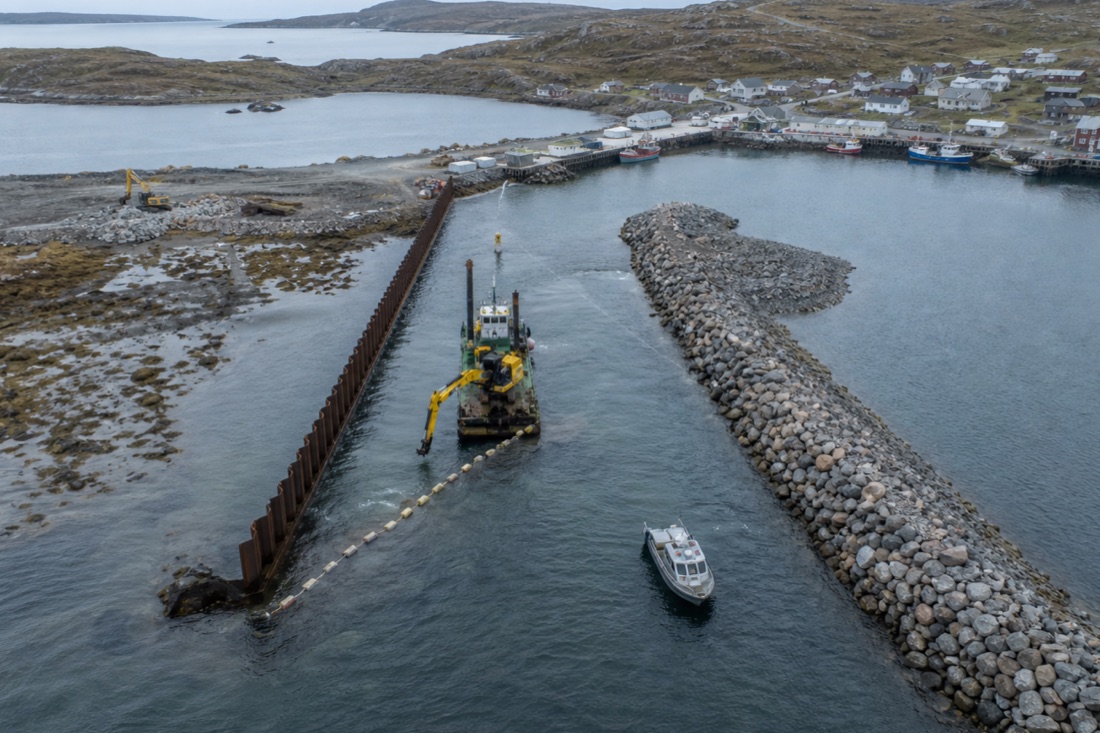

Harbour Works
Fox Island River has three package clocks, not one
Fox Island River's current public chain contains a 2023 entrance-improvement award, a separate 2024 channel re-dredging award and a 2026 marginal-wharf proposal still in assessment. Each package has a different supplier or open supplier gate, scope and evidence clock.
A new wharf proposal followed two elapsed marine-contract windows
CanadaBuys controls the two completed administrative contract histories and awardee identities. The federal assessment registry controls the dredging planning basis and the separate 2026 marginal-wharf proposal. DFO's navigation notice corroborates the current worksite and commercial-dock classification. No cited source proves either earlier package was accepted, connects the later dredging to a defect, or appoints a 2026 contractor.
A harbour programme can be continuous without being one contract
Merging the three records would create several false conclusions: that Marine Contractors performed the later re-dredging, that R.J.G Construction holds the 2026 wharf work, that contract expiry proves accepted navigation depth, or that repeated dredging proves a defect in the earlier breakwater package. The public evidence supports none of those claims. Keeping the records linked but separate exposes the real upcoming opportunity in the 2026 wharf and channel-wall procurement.
Evidence conclusion
Scope, value and acceptance must be tracked on separate clocks
Marine Contractors' CW2330925 covers entrance excavation or dredging and a rubble-mound breakwater or groyne; CanadaBuys records a current total of CAD 1,499,255 after a CAD 110,055 increase and CAD 14,375 reduction. R.J.G Construction's 4500077474 is a distinct CAD 1,133,000 channel re-dredging contract. Impact Assessment Registry project 86125 publishes a planned 280-metre reach, -2.4-metre depth and 7,500-cubic-metre volume, but not an accepted result. The 2026 project then proposes demolition and replacement of the northeastern marginal wharf with steel sheet piles, reinforced concrete, parking, shoreline, crane and electrical work. Its comment period has closed, yet the determination, tender, value and contractor remain open. None of the published end dates is a completion certificate.
Outstanding evidence
- Completion and owner acceptance for CW2330925
- Final survey, dredged quantity and disposal record for 4500077474
- Any published explanation of sediment recurrence or re-dredging need
- Federal determination for assessment 90484
- 2026 tender, budget, award and contractor
- Sheet-pile, concrete, electrical, crane and shoreline lower tiers
- Harbour-access and navigation restrictions
- Final accounts and berth reopening
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Sources used 6
- Fox Island River harbour entrance contract history - final amendment CanadaBuys, Contract awarded 20 September 2023; amendment and expiry 4 September 2024
- Harbour Entrance Improvement - Invitation to Qualify CanadaBuys, 2 August 2023
- Dredging - Fox Island River award notice CanadaBuys, Awarded 4 December 2024; current record through 23 April 2025
- Dredging, Fox Island River, NL Impact Assessment Agency of Canada, Assessment started 30 November 2023
- Channel Wall Reconstruction at Fox Island River SCH, NL Impact Assessment Agency of Canada, Public comments closed 22 June 2026
- Channel Wall Reconstruction - Fox Island River navigation notice Fisheries and Oceans Canada - Newfoundland and Labrador Region, Published 12 June 2026
