Delivery Status
Poona's January target passed before access dredging began
TMR expected Poona's full boat-ramp package to finish by January 2026. MSQ then scheduled approach dredging and foreshore nourishment for 9-27 February and closed the ramp from 16 February while upgrade works continued. The contract disclosure rose from AUD 2,041,001 to AUD 2,448,002, but the variation scope and final account remain unpublished.
February works moved the delivery chain beyond January
TMR's contract disclosure proves the original and varied CN-23611 rows. TMR's August 2025 media alert proves the designed scope and initial January 2026 target. MSQ's closure advice names Australian Marine & Civil and the September start; Notice 059(T) proves the later February dredging and renewed closure. Notice 345 records a June navigation marker but not contract completion. No cited source proves reopening, practical completion, accepted bathymetry, nourishment acceptance, final payment or the lower-tier chain.
A marine work notice can disprove an old target without proving completion

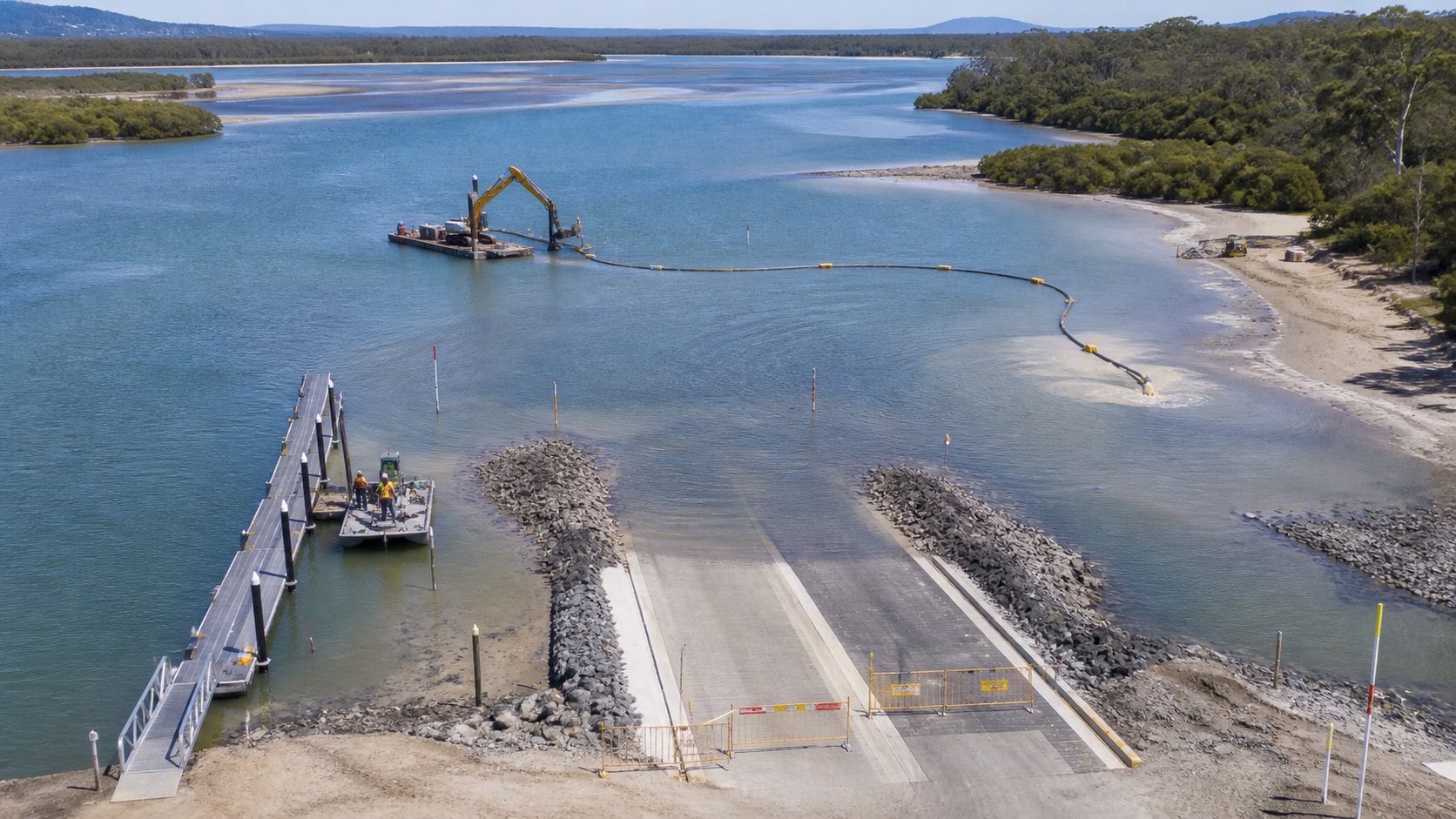

Poona's February dredging notice arrived after the announced January completion month, leaving a direct gap between programme and field evidence. The notice proves a workfront, place and time; it does not prove achieved quantity, accepted depth, ramp reopening, practical completion or final payment. The variation row, early tender estimate, program budget and wider funding allocation also retain different commercial boundaries.
Evidence conclusion
Keep Poona in construction until the owner closes the evidence chain
Australian Marine & Civil is confirmed as CN-23611 prime. MSQ's February notice is the strongest dated physical-delivery evidence: dredging about 250 metres seaward, foreshore nourishment and a renewed ramp closure. The later June beacon notice is a navigation update, not completion. The disclosed contract increase is AUD 407,001, about 19.94% over the original row, but neither its cause nor the final paid value is public. Completion should be promoted only from a dated owner reopening or completion record supported by accepted dredging, nourishment and walkway evidence.
Outstanding evidence
- Owner-confirmed reopening, practical completion and acceptance date
- Final CN-23611 account and explanation of the AUD 407,001 variation
- Accepted dredged volume, near all-tide depth and post-dredge survey
- Nourishment placement quantity, limits and environmental acceptance
- Floating-walkway supplier and installation acceptance
- Dredging, survey, environmental and other downstream contractors
- Near all-tide access performance and future shoaling
- 19 August 2026 TMR forum presentation and any technical publication
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Sources used 8
- TMR contract disclosure 2025-26 - CN-23611 Queensland Department of Transport and Main Roads, Award dated 29 July 2025; resource reviewed 6 August 2026
- Providing better boating access for Poona boaties Queensland Department of Transport and Main Roads, 27 August 2025
- Closure of Poona boat ramp for refurbishment Maritime Safety Queensland, 26 August 2025
- Notice to Mariners 059(T) of 2026 - Poona dredging operations Maritime Safety Queensland, 6 February 2026
- Notice to Mariners 345 of 2026 - Poona Creek starboard lateral beacon Maritime Safety Queensland, 18 June 2026
- Queensland Transport and Roads Investment Program 2025-26 to 2028-29 Queensland Department of Transport and Main Roads, 2025
- Poona proposed concept layout Queensland Department of Transport and Main Roads, January 2025
- Poona Boat Ramp Upgrade forum presentation listing Queensland Department of Transport and Main Roads Engineering, Innovation and Technology Forum, Presentation scheduled 19 August 2026
