Port of Antwerp-Bruges is building a 362-metre liquid CO2 export quay at Kanaaldok B2, but the marine civil schedule now runs ahead of several export-chain decisions. Quay works are planned through March 2027, while Fluxys c-grid's 2026 network plan makes the terminal connection conditional on technical and economic justification and signed contracts, and references a mid-2029 operational horizon in its current terminal-planning language.
Belgium / Europe
Port infrastructure

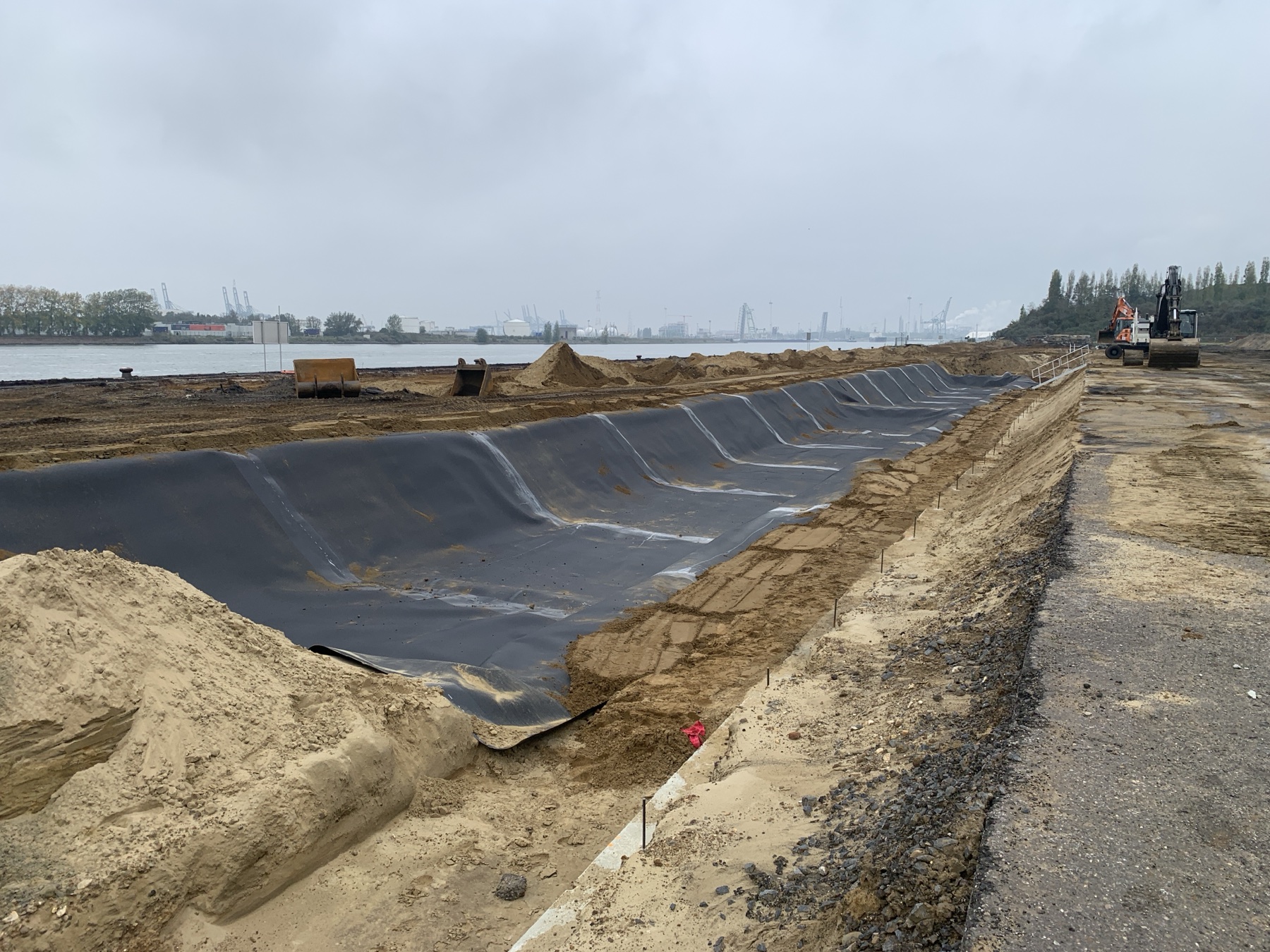

Quay-wall construction and marine works in progress / Confirmed
15 July 2026
Coverage
Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogThe 21 May specification defines a current vapor-network baseline and supersedes the October 2023 version, but it is explicitly non-binding. Terminal, loading-arm, carrier, liquid-product and storage compatibility remain unconfirmed.
SourceThe 2026 network plan makes the terminal link conditional on technical and economic justification and signed contracts, and references mid-2029 in its current terminal-operational planning language. It is not a terminal final investment decision or commissioning confirmation.
SourceThe 20-year appointment established Fluxys c-grid Antwerp's regulated network role while the first port-area pipeline was already under construction. It did not confirm terminal investment, customer contracts, marine loading, export service, or stored volume.
SourceThe owner and contractor place the 362-metre quay package in execution from September 2025, with piling, concrete, demolition, and dredging sequenced through early 2027. Start of works is not berth handover or export readiness.
SourceThe owner separated capture, the open-access pipeline backbone, phased liquefaction terminal, and a quay for two simultaneous seagoing vessels. That interface map clarifies dependencies; award, completion, commissioning and carrier availability remain open.
SourceThe EUR 144.6 million grant agreement supported shared transport, liquefaction and export infrastructure under a June 2027 action frame. Grant execution is not the EUR 22 million quay award, terminal final investment decision, construction completion, or operation.
SourceAir Liquide, Fluxys and the port announced CEF support for an open-access pipeline, liquefaction, buffer-storage and marine-loading system. The announcement described a step toward final investment decision, not the decision itself or physical delivery.
SourceEvidence gap
