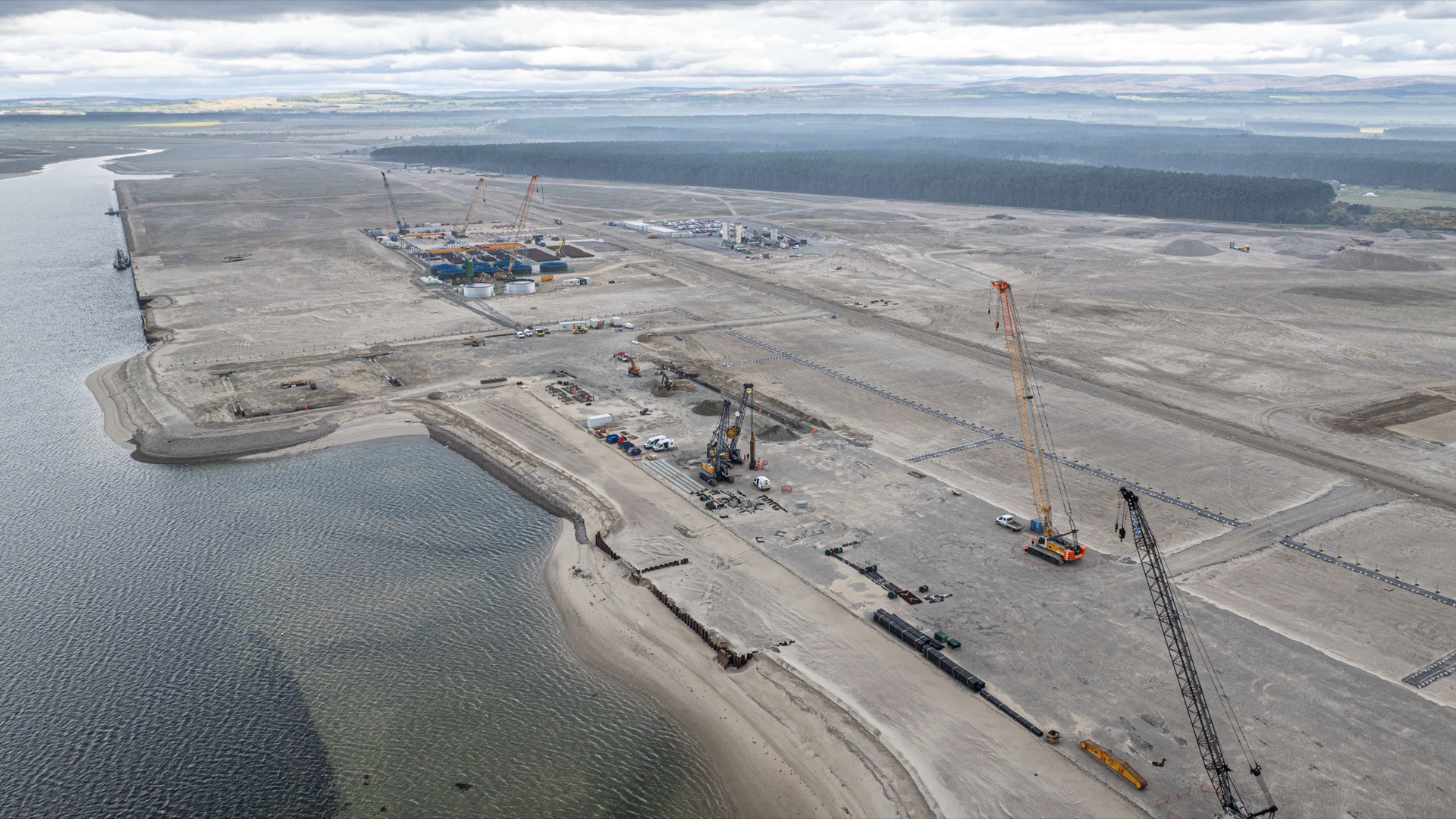

Ardersier Port (Scotland) Limited is procuring a separate Phase 2 dredging package estimated at GBP 20 million. The package covers a 140-metre-wide navigation channel beside 300 metres of new quay and 758 metres of existing sheet-pile quay, with dredging planned for the second quarter of 2028.
Project signal
Prequalification in United Kingdom
Current statusPQQ closed on 1 May 2026; no shortlist, ITT or award notice is present in the reviewed public chainSource confidenceConfirmed
Location
United Kingdom / Europe
Segment
Port infrastructure
Status
PQQ closed on 1 May 2026; no shortlist, ITT or award notice is present in the reviewed public chain / Confirmed
Last checked
18 July 2026
Coverage
Related sectors
Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Ardersier Port (Scotland) Limited / Haventus
Delivery parties
Phase 2 dredging contractor not appointed; PQQ closed and no shortlist or award is public
Contract route
Competitive procedure with negotiation. The published route moves from market consultation through PQQ and a shortlist of four to negotiated tender, preferred bidder, standstill and contract execution. The PQQ deadline was 1 May 2026 and the notice estimated invitations to tender on 15 May, but the reviewed public chain does not confirm that later step.
Execution window
The contract notice gives a four-month duration and anticipates a Q2 2028 dredging window. These are procurement assumptions, not an awarded construction programme or notice to proceed.
Works package
Dredge a 140-metre-wide Phase 2 navigation channel to -12.4mCD along 300 metres of proposed new quay and to -6.5mCD along 758 metres of existing sheet-pile quay being upgraded
Marine interfaces
The dredging contractor must work around the quay civils principal contractor and port operations. The adjoining GBP 23 million quay-civils package includes a 100-metre-wide apron, new quay furniture and upgrades along the existing 758-metre frontage, while stating that dredging is by others.
Commercial evidence boundary
GBP 20 million is the contracting authority's estimate excluding VAT, not an award value. The PQQ sought bidders with at least GBP 30 million annual turnover for the preceding three years, three relevant dredging case studies and NEC/CEMAR experience. Any Phase 2 dredging award should be kept separate from the GBP 23 million quay-civils estimate, the port's earlier financing and completed Phase 1 works.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Ardersier opened prequalification for the Phase 2 dredging package
The notice set a GBP 20 million estimate, exact channel geometry, a four-stage negotiated route, a planned shortlist of four and a Q2 2028 dredging window. It did not publish a shortlist, tender issue, bidder, award or mobilisation.
The separate quay-civils package defined the dredging interface
The GBP 23 million civils notice covers the 300-metre new quay and 758-metre existing frontage and expressly leaves dredging to others. The two packages need coordinated programmes but retain separate scope and value.
Bank reporting confirmed Haventus ownership, a GBP 100 million joint credit facility and construction of the earlier 650-metre quay. That context does not establish progress on the later Phase 2 dredging competition.
