Project record

Bangladesh Bay Terminal marine infrastructure

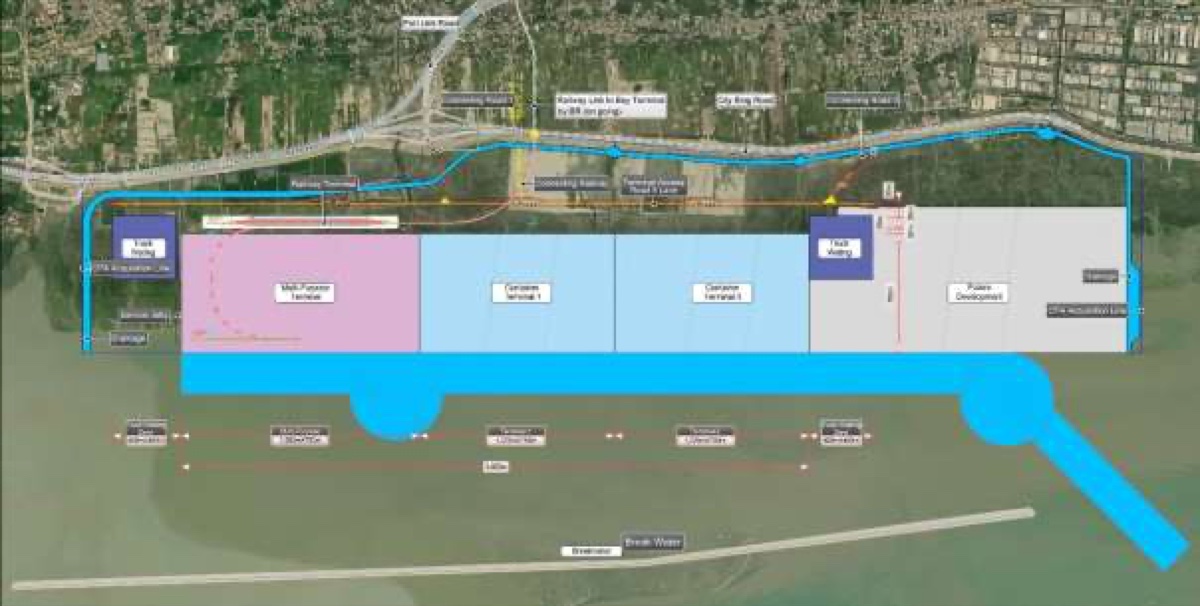

Bay Terminal layout showing the offshore breakwater, planned container terminals, basin and access channel west of Chattogram

Chittagong Port Authority / World Bank revised ESIA, Figure 3-3; planning layout, not construction progress

Chittagong Port Authority is developing the common marine infrastructure for Bay Terminal with World Bank financing. The public design baseline combines a 6-kilometre offshore breakwater, dredging for a 6.6-kilometre access route, port basin and entrance works, navigation aids and VTMS integration. The latest World Bank implementation report says the financing is effective and key studies are nearing completion, but physical works have not commenced.

Project signal

Design in Bangladesh

Current status IDA financing effective since 8 December 2025; marine studies are nearing completion, but works and the terminal-operator RFP have not started Source confidence Confirmed

Location

Bangladesh / Asia Pacific

Segment

Port infrastructure

Status

IDA financing effective since 8 December 2025; marine studies are nearing completion, but works and the terminal-operator RFP have not started / Confirmed

Last checked

19 July 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Chittagong Port Authority (CPA), Government of Bangladesh
Delivery parties
No marine works contractor identified in reviewed official sources, Transaction adviser engaged for the separate terminal-operator PPP
Contract route
IDA-financed international competitive procurement using World Bank documents and rated criteria. The 2024 procurement strategy groups breakwater construction and capital dredging in a preliminary US$827 million line, but says the scope is likely to be split after market survey and PPSD finalisation. A separate PPP route will recruit international terminal operator(s).
Execution window
World Bank financing closes on 30 June 2031; package tender, award, mobilisation and construction dates remain unconfirmed
Works package
A 6 km rubble-mound breakwater on the offshore sandbar, dredging of a 5 km basin reach and roughly 1.6 km entrance reach for a 6.6 km access route, an expected capital-dredging volume close to 30 million m3, navigation aids and VTMS updates
Marine interfaces
Offshore breakwater design, sandbar stabilisation, a live approach to Chattogram, basin and entrance-channel dredging, sediment monitoring, navigation systems and the handover boundary between publicly funded common marine works and privately developed container terminals
Commercial evidence boundary
The World Bank's US$650 million financing is a project envelope, not a marine-works award. The US$827 million figure is a preliminary procurement-plan estimate for breakwater and capital dredging, the US$5 million line is for navigation aids and VTMS, and the US$830 million indicator is a future private-investment target for at least one terminal. None is a signed construction contract.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Latest implementation report kept physical works at pre-start

The World Bank recorded effective financing and studies nearing completion, while marine works remained pre-start and the terminal PPP RFP awaited feasibility and transaction-structure approval.

Source

IDA financing became effective

The three IDA credits moved from signature to effective status. Effectiveness released the financing framework but did not award or start a marine-works contract.

Source

World Bank approved the Bay Terminal financing

Approval established the US$650 million project envelope and common marine-infrastructure objective, including the breakwater and channel works. It was not a construction award.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Completion and approval of marine feasibility, detailed design and PPSD
  • Final split between breakwater, capital dredging and initial maintenance dredging
  • Prequalification and rated-criteria tender documents for each marine package
  • Design depth, dredge prism, measured quantity and sediment-management route
  • Breakwater foundation, sandbar stabilisation and scour-protection requirements
  • Navigation aids, VTMS integration and live-traffic controls
  • Contract awards, notice to proceed and identifiable mobilisation
  • Baseline and post-dredge hydrography, breakwater acceptance and navigation release
  • Interface agreement with the future private terminal operator

Reporting status

Design, confirmed confidence

Last checked 19 July 2026 across 6 cited sources. The dated timeline above carries the project events.

Last checked 19 July 2026 Cited sources 6
