Port Seine-Metropole Ouest phase-one river-port construction

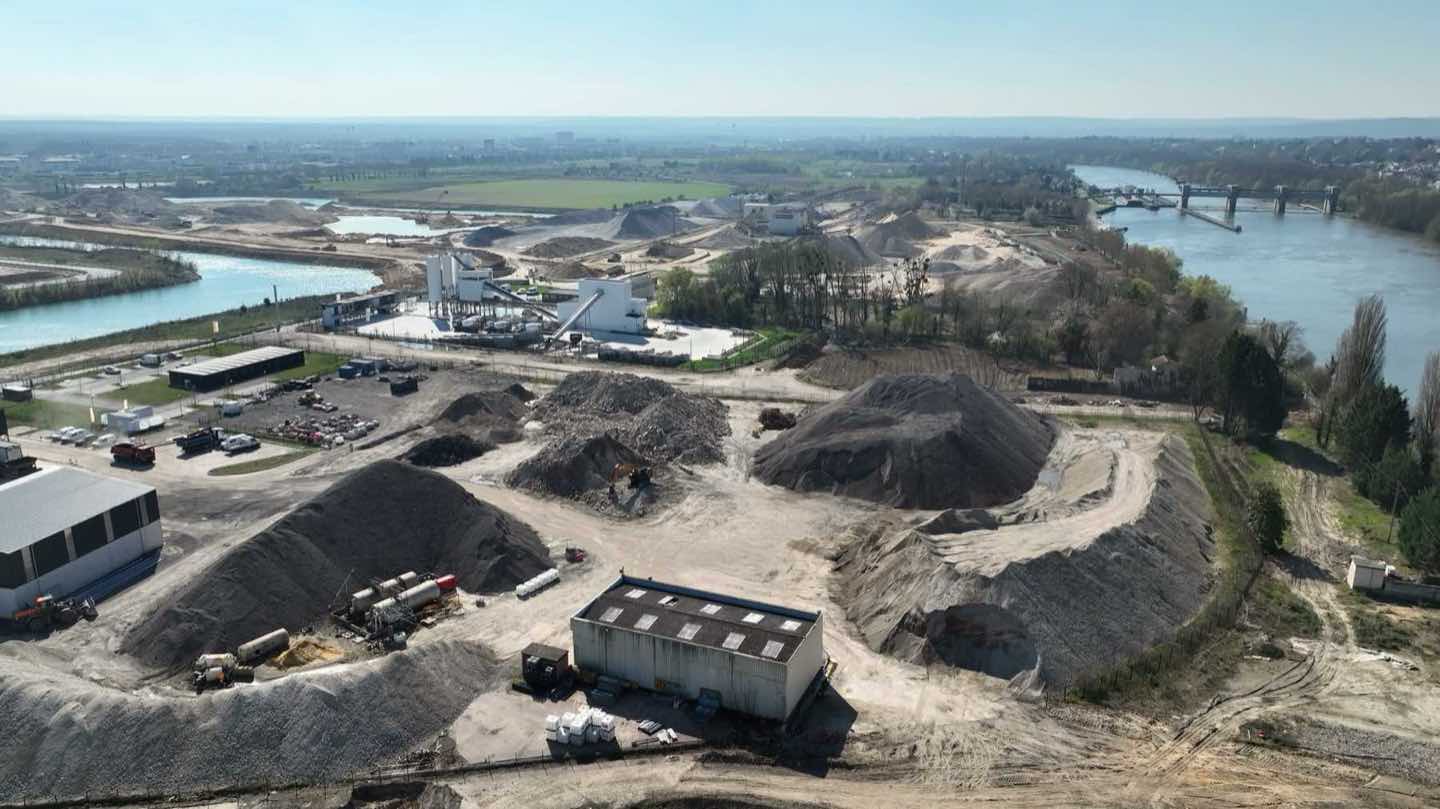

Aerial view of Port Seine-Metropole Ouest phase one basin excavation and port construction beside the Seine, with the active quarry, material stockpiles and Andresy barrage

HAROPA PORT; exact PSMO phase-one construction site image published with the summer 2026 works update

HAROPA PORT is building the first 35 hectares of Port Seine-Metropole Ouest at the Seine-Oise confluence. Phase one opens the first section of the inland basin to the Seine and delivers sheet-pile quays, pile-supported jetties, roads, utilities and landscape works. TED records two contracts totalling EUR 44,612,979.42: Océlian's EUR 34,317,079.42 Lot 1 for civil and port works and Spie Batignolles Le Foll TP's EUR 10,295,900 Lot 2 for roads, networks and landscape. Owner updates move the package beyond award: South Quay sheet piling, west-jetty piling, earthworks, a retaining wall and river loading were active or starting by July 2026.

Project signal

Construction in France

Current status HAROPA PORT reports phase-one construction in execution: earthworks, a retaining wall and conveyor loading were active in summer 2026, South Quay sheet-pile installation had started, and piling for the west then east jetties was scheduled from the week of 6 July Source confidence Confirmed

Location

France / Europe

Segment

Inland-port basin excavation, sheet-pile quays, pile-supported jetties and multimodal access

Status

HAROPA PORT reports phase-one construction in execution: earthworks, a retaining wall and conveyor loading were active in summer 2026, South Quay sheet-pile installation had started, and piling for the west then east jetties was scheduled from the week of 6 July / Confirmed

Last checked

6 August 2026

Coverage

Related sectors

Inland-port basin excavation, sheet-pile quays, pile-supported jetties and multimodal access is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
HAROPA PORT DT Paris - public port owner, buyer and project authority
Delivery parties
Océlian - Lot 1 winner and group lead for basin earthworks, river works, civil engineering and port structures under contract 2025.60.04, Spie Batignolles Le Foll TP - Lot 2 winner for roads, utilities and landscape works under contract 2025.60.06, SETEC International - project manager named in HAROPA's current site-participant register, Lot 1 official site participants include Terélian, CDES, Botte Fondations, Chantiers Modernes Construction, Eurovia, Leduc TP and other named firms; legal workshares and values are not published, Lot 2 official site participants include Auddicé Seine Normandie, Jean Freon Elagage, Holma, Vallois and Spie Batignolles Valerian; legal workshares and values are not published
Contract route
TED award notice 326986-2026 records two works contracts under one phase-one procedure. Contract 2025.60.04_OCELIAN_LOT 1 concluded on 1 August 2025 at EUR 34,317,079.42. Contract 2025.60.06_SPIE_LOT 2 concluded on 28 October 2025 at EUR 10,295,900. Publication followed on 13 May 2026, making that date a disclosure event rather than either award date. The notice says subcontracting was not known.
Execution window
HAROPA's current programme places phase one in 2025-2028 and the first operators in 2028. Its September 2025 public materials used an end-2027 construction objective before operating release. The July 2026 schedule and work notices supersede the earlier presentation for current sequencing. Neither the programme nor the start of piling proves completed quays, accepted jetties, an opened basin or operational service.
Works package
Lot 1 covers excavation of the first basin section, site levelling and the river and port structures, including quays, pile-supported jetties, banks and the basin opening. Lot 2 covers roads, dry and wet networks, power, lighting, telecoms, water, wastewater, stormwater, public realm, landscape and urban furniture. The owner brochure identifies South Quay sheet piles, east and west jetties, 1.3 million tonnes of excavated material, a basin bypass route and the later removal of the plug separating the basin from the Seine.
Marine interfaces
The new basin enters the Seine beside the existing Ile du Bac riverfront and the Andresy barrage at the Seine-Oise confluence. Delivery joins excavation, sheet-pile quay walls, driven jetty piles, retaining structures, river loading by conveyor, barge export, live inland navigation, temporary access and eventual basin opening. HAROPA reports approximately 60% of excavated material reused on site, 25% moved by river and less than 20% by road; these are logistics plans and reported controls, not a final reconciled material ledger.
Commercial evidence boundary
The two TED lots total EUR 44,612,979.42. HAROPA's September 2025 owner update gives an approximately EUR 150 million whole-project investment and says EUR 62.5 million had been committed to studies and phase-one works, while an older owner overview still shows EUR 122 million of public investment. Those figures describe different dates and boundaries and must not be blended with the two contract awards. Final payments, variations, lot-level earned value and the downstream participant values remain unpublished.

Contract and delivery chain

Named roles and open packages

Named appointments are shown against the workstream they cover. Unallocated packages remain open until a project source identifies the responsible party.

Lot 1 - earthworks and port structures

Basin excavation, levelling, river works, quays, jetties, banks and civil engineering

Named party
Océlian
Status
Confirmed
Source position
TED records contract 2025.60.04_OCELIAN_LOT 1 at EUR 34,317,079.42, concluded on 1 August 2025. HAROPA's public presentation identifies Océlian as group lead. Source
Lot 2 - access, networks and landscape

Roads, utilities, drainage, public realm, landscape and urban furniture

Named party
Spie Batignolles Le Foll TP
Status
Confirmed
Source position
TED records contract 2025.60.06_SPIE_LOT 2 at EUR 10,295,900, concluded on 28 October 2025. Source
Current port-structure execution

South Quay sheet piles and west and east jetty piles

Named party
HAROPA PORT with the Lot 1 delivery chain
Status
Confirmed
Source position
The owner reported that South Quay vibro-driving and pile driving had started and that west-jetty piling would begin in the week of 6 July 2026 before moving to the east jetty. Source
Site participant register

Owner, project management and companies listed under Lots 1 and 2

Named party
SETEC International and the named lot participants
Status
Confirmed
Source position
HAROPA's current two-page register names SETEC International, Océlian, Terélian, CDES, Botte Fondations, Spie Batignolles Le Foll TP and other participants. The register does not expose each legal subcontract, workshare or value. Source
Completion and operating release

Accepted basin, quays, jetties, networks, access and first operator use

Named party
HAROPA PORT
Status
Not evidenced
Source position
Current sources show construction and a 2028 first-operator target. They do not certify completed structures, removal of the basin plug, handover, navigation release or first commercial use.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

HAROPA updated the summer marine-works sequence

The owner moved the record beyond generic construction by reporting active sheet-pile work, retaining-wall and earthworks activity, conveyor loading and the west-to-east jetty piling sequence.

Source

TED published the two-contract phase-one award result

The notice disclosed EUR 44.613 million across Océlian Lot 1 and Spie Batignolles Le Foll TP Lot 2 while preserving their separate contract dates and scopes.

Source

The Lot 2 roads, networks and landscape contract concluded

Spie Batignolles Le Foll TP became the confirmed EUR 10.296 million Lot 2 contractor; this does not assign it the port-structure scope in Lot 1.

Source

HAROPA launched phase-one construction

The owner marked the move from preparatory work into the 35-hectare operational phase, without claiming completed marine structures or service.

Source

The Lot 1 earthworks and port-structures contract concluded

Océlian became the confirmed EUR 34.317 million Lot 1 winner and later owner materials identify it as group lead.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • South Quay sheet-pile installation quantity and accepted wall geometry
  • West and east jetty piling, deck works and structural acceptance
  • Basin excavation, 1.3 million tonne material ledger and river-export reconciliation
  • Retaining wall, basin bypass route and removal of the Seine-side plug
  • Lot 1 and Lot 2 participant workshares, subcontract values and variations
  • Road, rail, river, power, water, wastewater and stormwater interfaces
  • Environmental monitoring, noise, dust, carbon and restored wetlands
  • First-operator handover, navigation release and owner-confirmed service in 2028

Reporting status

Construction, confirmed confidence

Last checked 6 August 2026 across 7 cited sources. The dated timeline above carries the project events.
