Location
Qatar / Middle East
Project record
Owner reports 98% construction; full-system handover pending

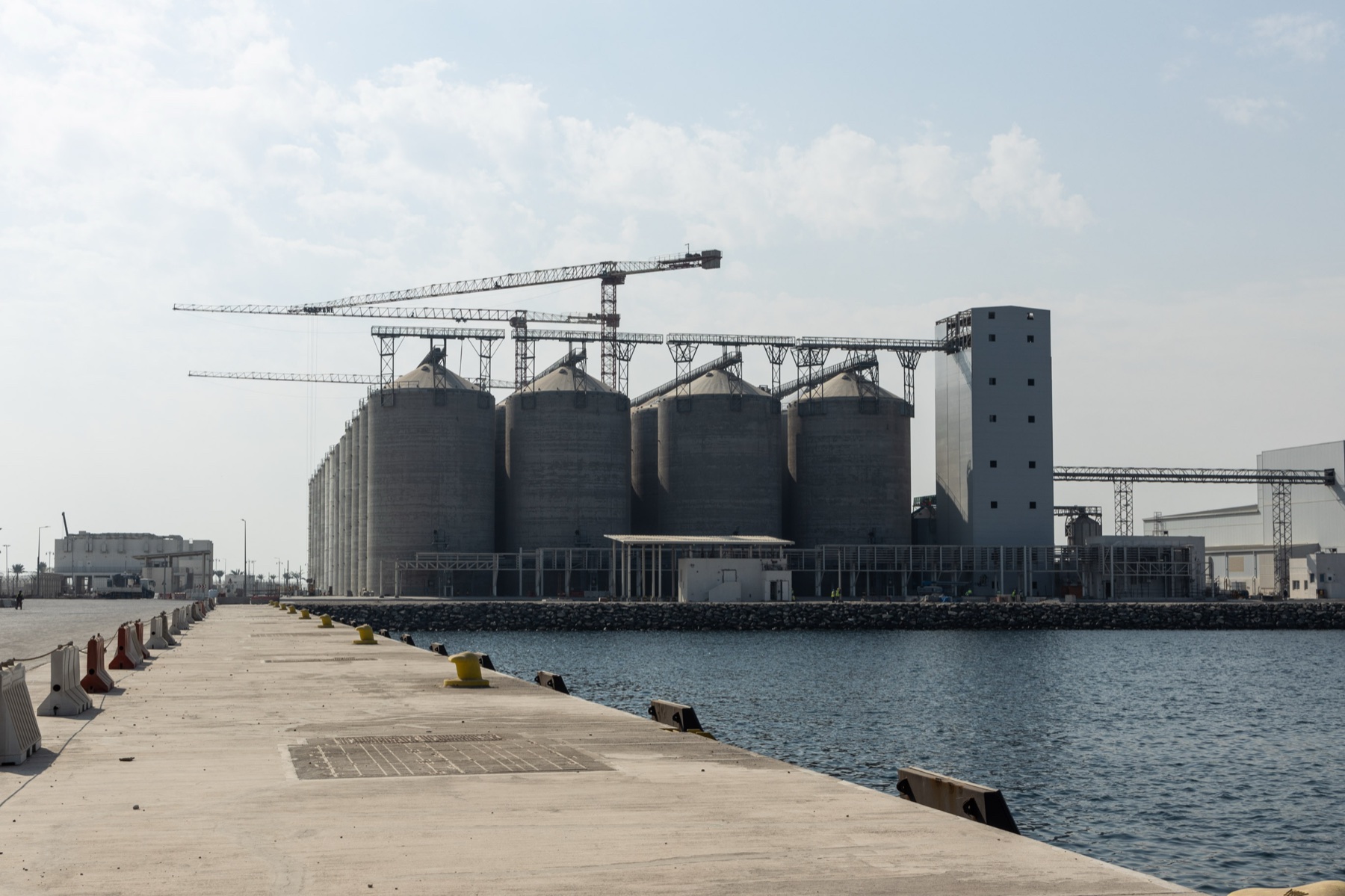

Hamad Port's QAR 1.6 billion food-security terminal has moved from a 2017 design-and-build award through an 85% milestone in 2020, a first equipment-delivery vessel at 93% in 2022, final-operations work in 2024 and an owner-reported 98% in June 2026. The 575-metre berth and ship-unloading interface are real, but full processing, storage, control, safety and operating-system acceptance remains open.
Qatar / Middle East
Port infrastructure
Construction / Confirmed
15 July 2026
Coverage
Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Project timeline
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Open this project in the Change LogThe owner-side visit confirmed advanced whole-project construction and technical installation, but also referred to remaining implementation stages and operational-readiness plans. The percentage is not a completion certificate, integrated commissioning record, operator handover or evidence of sustained food-cargo service.
SourceThe Ministry of Transport described final operations to equip the terminal with storage, packaging, transport and handling technology. This shows system integration remained active after the first equipment vessel and does not establish final acceptance or commercial operation.
SourceThe vessel call proved the berth could receive a heavy-lift equipment delivery and brought two Liebherr LHM 280 cranes to site. The owner called it a countdown to operation, so it must not be represented as first food cargo, terminal opening or accepted whole-system service.
SourceThe official update recorded uneven progress across rice, sugar and edible-oil facilities and said the project was targeted to become operational in the second quarter of 2021. Later 2022, 2024 and 2026 records show that target cannot be used as an achieved operating date.
SourceThe original contract established the 53-hectare processing and storage system, bulk silos, conveyors and roughly 500-metre wharf interface. It is the commercial baseline for the terminal, not evidence of completed construction or operations.
SourceEvidence gap
