DEWA commissioned Hassyan Block A, adding 60 MIGD by 31 March 2026. The first 180 MIGD phase uses a six-pipe marine corridor sized for the planned 240 MIGD complex: four 3 m intake pipes fed by eight risers 950 to 1,100 m offshore and two 3 m outfalls ending in diffusers outside the Ramsar boundary. Blocks B and C remain in the 2026 delivery programme, with full commercial operation listed for 15 February 2027.
Project signal
Commissioning in UAE
Current statusBlock A in service; Blocks B and C remain in the 2026 delivery programmeSource confidenceConfirmed
Location
UAE / Middle East
Segment
Marine utilities
Status
Block A in service; Blocks B and C remain in the 2026 delivery programme / Confirmed
Last checked
13 August 2026
Coverage
Related sectors
Marine utilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Dubai Electricity and Water Authority (DEWA)
Delivery parties
Hassyan Water Company A P.S.C., SIDEM (Veolia), SEPCO III
Contract route
US$914 million, 30-year build-own-operate independent water project under a DEWA water purchase agreement; SIDEM and SEPCO III form the joint EPC contractor, while Hassyan Water Company A is the project company.
Execution window
Block A, 60 MIGD, was commissioned by 31 March 2026; DEWA expected Blocks B and C, another 120 MIGD, during 2026; ACWA Power lists 15 February 2027 as the commercial operations date.
Works package
A 180 MIGD SWRO plant with eight offshore intake risers, four 3 m intake pipes, two 3 m brine and treated-effluent outfalls, terminal diffusers, intake screening and chlorination, electrical facilities, four potable-water tanks totalling about 412,000 m3, and marine capacity provision for a planned additional 60 MIGD phase.

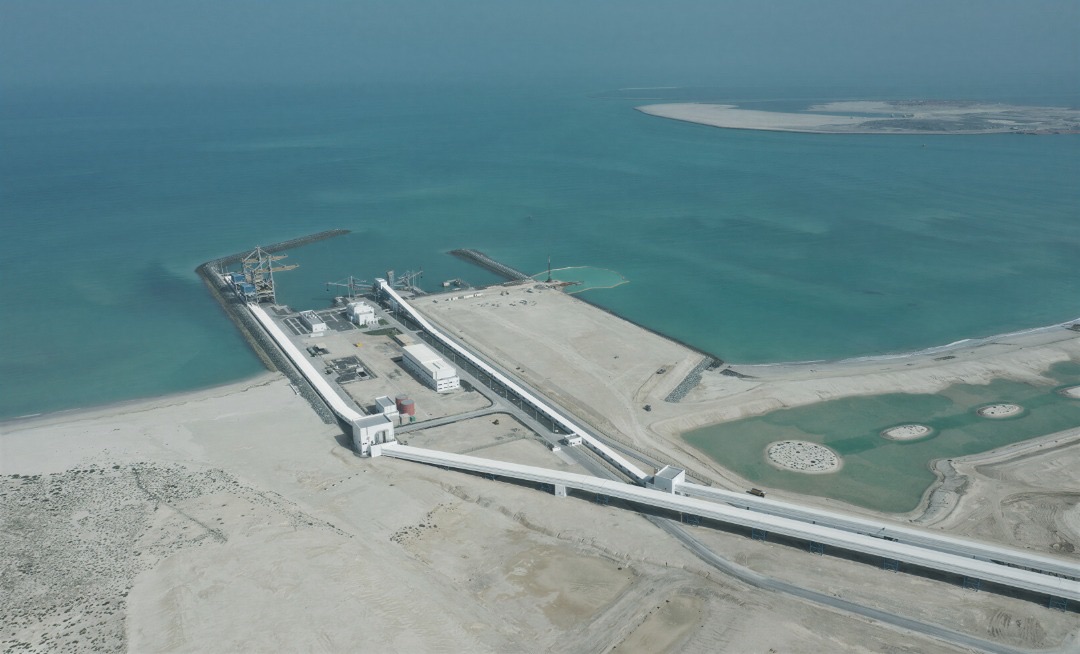

Marine interfaces
The six GRP pipelines share buried onshore and offshore trenches through an 80 m planning corridor that crosses the Ramsar boundary. The offshore works were designed around about 530,000 m3 of cutter-suction dredging, trench depths of 5 to 6 m below seabed and a maximum formation level of -13.5 m CD. The outfalls sit near the Hassyan power-plant diffusers so dense RO reject and warmer buoyant cooling water can mix within the approved corridor; that interaction makes hydraulic performance, recirculation control and receiving-water monitoring part of the operating case.
Commercial evidence boundary
The main marine works sit inside the existing SIDEM-SEPCO III EPC contract. Near-term specialist demand is therefore more likely in commissioning support, intake screening and biofouling control, diffuser inspection, bathymetric or condition surveys, environmental monitoring and maintenance planning than in a new intake-outfall construction award. Any downstream Phase 2 potable-water transmission tender should be kept separate from the already installed offshore capacity provision.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
The first 60 MIGD block entered the installed water-capacity record, moving the project into phased commissioning while the remaining 120 MIGD, full marine-system acceptance, and sustained performance remain separate conclusions.
The progress report narrowed the delivery window and put construction at an advanced stage. A percentage-complete statement left first water, accepted output, intake-outfall performance and commercial operation unverified.
The owner announcement set the financed 30-year IWP delivery structure and committed development route. It contained no marine construction progress, commissioning result or accepted desalination capacity.
