Project record

NW-1 Bihar-West Bengal: six steel floating jetties

Participation
Not assessed
Project facts checked

Cleghorn Mfg. Co. signed the six-location bundled supply and installation contract on 24 April 2025; public evidence does not confirm final sites, fabrication, installation, commissioning or acceptance

Project sources

Contract 1849339 identifies Cleghorn Mfg. Co. Pvt. Ltd. as the supplier for IWAI package IN-IWAI-465171-GO-RFB at a committed supplier amount of USD 985,685.91. The official tender covers six National Waterway-1 locations, three in Bihar and three in West Bengal, with one 24 m by 6 m steel pontoon and one 9 m by 2 m HDPE-floater shore walkway at each location. Locations remain tentative under the tender's river-morphology clause, while final coordinates and physical delivery remain unpublished.

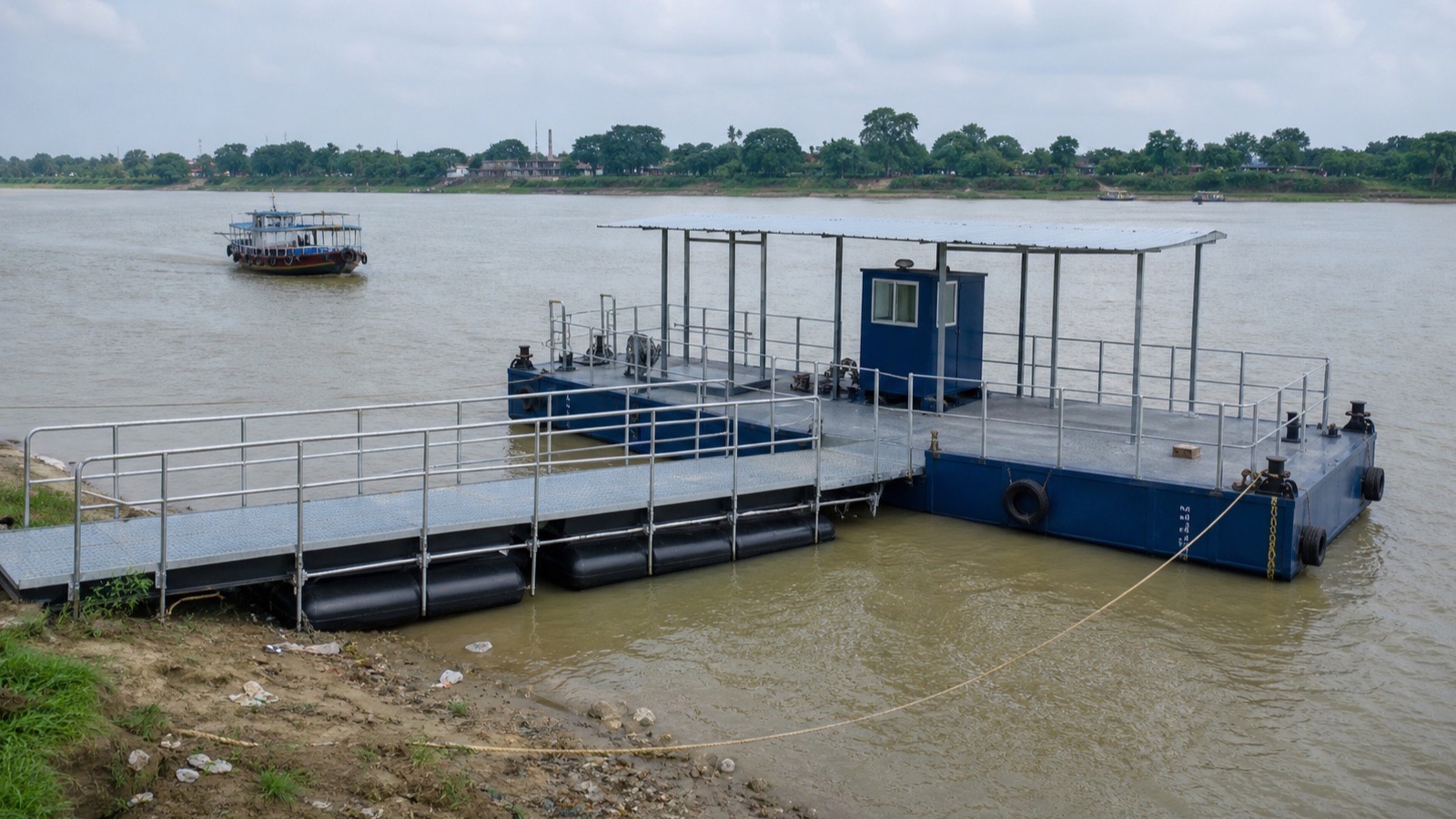

An IWAI steel floating pontoon and HDPE-supported shore walkway on an inland waterway

IMWO artist's impression of the published NW-1 Bihar-West Bengal: six steel floating jetties scope

Location

India / Asia Pacific

Segment

Inland-waterway floating jetties, gangways and passenger facilities

Phase

Award / Confirmed

Last checked

9 August 2026

Coverage

Related sectors

Inland-waterway floating jetties, gangways and passenger facilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Inland Waterways Authority of India under the Ministry of Ports, Shipping and Waterways
Delivery parties
Cleghorn Mfg. Co. Pvt. Ltd. - signed supplier responsible for the bundled design, fabrication, transport, installation, testing and commissioning scope, Steel fabricator, design verifier, HDPE walkway supplier, anchorage and mooring supplier, transporter, launching team and site installation subcontractors - not separately identified in the reviewed public records
Contract route
IWAI used an open, post-review Request for Bids under World Bank project P148775. The award dataset records the goods contract as signed on 24 April 2025 under reference IN-IWAI-465171-GO-RFB. One supplier row is disclosed, with no joint venture or named subcontractors.
Execution window
Contractual scope sets eight months from signature for design, fabrication, certification, transportation, installation, anchoring, testing and commissioning, followed by 24 months of general upkeep and maintenance after commissioning and final handover. On an unchanged programme the delivery milestone fell around 24 December 2025. This computed milestone does not establish completion, extension, commissioning or acceptance.
Works package
The package covers six 24 m by 6 m steel floating pontoons and six 9 m by 2 m shore-connecting walkways carried on HDPE float modules with 0.80 m handrails. The tender allocates three tentative locations to IWAI Regional Office Patna in Bihar and three to Regional Office Kolkata in West Bengal. It explicitly allows locations to change based on river morphology. The bundled obligations include design, procurement, fabrication, certification, supply, transportation, installation, anchoring, testing, commissioning and 24 months of upkeep.
Marine interfaces
Six riverbank installations across two states require final site selection, surveys, site-specific anchorage and mooring, transport, launching and safe shore access under changing water levels and morphology. Published documents define the equipment envelope without disclosing final coordinates, approved drawings, bathymetry, geotechnical assumptions, accepted anchor design, transport routes, lifting equipment, installation craft or site sequence.
Commercial evidence boundary
Bank-reported supplier commitment is USD 985,685.91. The IWAI tender's INR 10.38 crore plus GST estimate is a pre-award budget and is not a like-for-like signed contract value. No published record identifies local-currency contract value, variations, certified payments, retention, delay damages, subcontract values or final account.

Contract and delivery chain

Work packages and named roles

Published scope, named parties and supporting evidence for each workstream.

Legal award

IN-IWAI-465171-GO-RFB / World Bank contract 1849339

Named party
Cleghorn Mfg. Co. Pvt. Ltd.
Evidence status
Confirmed
Source position
World Bank contract data records a USD 985,685.91 committed supplier amount and a contract signed on 24 April 2025. Source
Six-site technical scope

Six 24 m by 6 m steel pontoons and six 9 m by 2 m HDPE-supported walkways

Named party
IWAI and Cleghorn Mfg. Co. Pvt. Ltd.
Evidence status
Confirmed
Source position
The official IWAI tender defines six units, a three-plus-three state allocation and the bundled design-to-commissioning obligations, while keeping locations tentative. Source
Final site allocation

Three Bihar and three West Bengal locations

Named party
IWAI
Evidence status
Not evidenced
Source position
The tender states the locations are tentative and may change with river morphology; reviewed sources do not confirm final names or coordinates.
Physical delivery

Fabrication, transport, installation, commissioning and acceptance

Named party
IWAI and Cleghorn Mfg. Co. Pvt. Ltd.
Evidence status
Not evidenced
Source position
The reviewed public sources confirm contract signature but publish no unit-level production, installation or acceptance record.
Lower-tier delivery chain

Design verification, steel, HDPE, anchors, moorings, transport and installation

Named party
Lower-tier parties not identified
Evidence status
Not evidenced
Source position
No reviewed contract-specific source identifies separate suppliers or subcontractors below the signed supplier.

Evidence gap

What remains unverified

Outstanding evidence

  • Final three Bihar and three West Bengal locations and coordinates
  • Approved drawings, river surveys and accepted anchorage and mooring basis
  • Named fabrication yard, steel-cutting start and six unit numbers
  • Design verifier, classification body and inspection hold points
  • HDPE float modules, fenders, winches, bollards, ropes and safety equipment
  • Transport, launching, installation craft and lower-tier contractors
  • Any extension beyond the tender-derived 24 December 2025 milestone
  • Testing, commissioning, registration and owner acceptance by site
  • Start date and performance records for the 24-month upkeep period

Reporting status

Project phase
Award
Evidence confidence
Confirmed
Last checked
9 August 2026
Cited sources
5
