Mombasa SEZ DK1 port and jacket quay

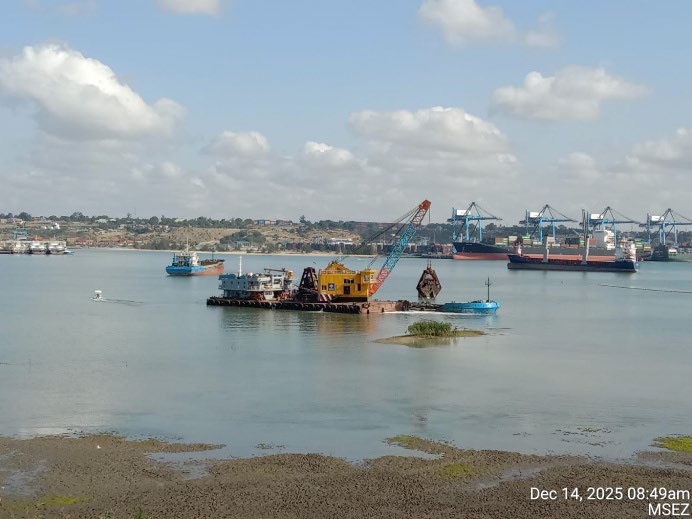

Grab dredger working in sheltered water at the Mombasa SEZ DK1 project in December 2025

Embedded project photograph in the KPA-hosted December 2025 environmental monitoring report; dated 14 December 2025 and showing December 2025 foundation dredging equipment, not measured production or acceptance

Kenya Ports Authority awarded TOA Corporation the civil and building package for the DK1 port at Mombasa Special Economic Zone. The approximately JPY 33.5 billion package includes 2.59 million m3 of dredging, 430,000 m3 of reclamation and a 300 m by 50 m steel-pipe-pile and jacket quay. KPA's December 2025 monitoring report records active foundation dredging and cargo-yard works, but no activity in the turning basin, navigation channel or permanent port facilities that month.

Project signal

Construction in Kenya

Current status TOA's Package 1 is in construction; KPA reports confirm quay and trestle foundation dredging, while channel, basin, jacket installation and accepted quantities remain open Source confidence Confirmed

Location

Kenya / Africa

Segment

Port infrastructure

Status

TOA's Package 1 is in construction; KPA reports confirm quay and trestle foundation dredging, while channel, basin, jacket installation and accepted quantities remain open / Confirmed

Last checked

1 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Kenya Ports Authority
Delivery parties
TOA Corporation - Package 1 main contractor for civil and building works, Marine dredging, disposal and support-vessel subcontractors - not publicly named by 1 August 2026, Steel-pile, jacket fabrication and installation subcontractors - not publicly named by 1 August 2026
Contract route
KPA awarded Package 1: Civil and Building Works to TOA Corporation under the Mombasa Special Economic Zone Development Project port subproject. TOA identifies the employer as KPA, the financing as a JICA Japanese ODA loan using Special Terms for Economic Partnership and the contract value as approximately JPY 33.5 billion. The KPA monitoring report identifies contract KPA/065/2022-23/PDM. The public records do not disclose a separate marine subcontract award.
Execution window
TOA's 5 February 2024 award notice states 1,156 days, approximately 38 months, but does not publish a notice-to-proceed date from which an exact completion date can be calculated. KPA's October-December 2025 monitoring reports show active construction, and its project gallery contains environmental monitoring images dated May and June 2026. These records do not establish an accepted progress percentage or revised completion date.
Works package
TOA lists 2,590,000 m3 of dredging, 430,000 m3 of reclamation, a 300 m by 50 m quay on steel pipe piles and a jacket structure, 4,470,000 m of prefabricated vertical drains across 14.9 ha, 118,000 m2 of concrete pavement, 2,690 m of drainage and 16 buildings with 11,595 m2 total floor area. TOA describes the trestle and causeway as 214 m by 20 m, while KPA's December monitoring report describes it as 363 m by 20 m and a 13 ha cargo yard. Both official descriptions are retained until the owner or contractor reconciles the package geometry.
Marine interfaces
The December report records dredging for the quay foundation and trestle and causeway foundation, with material taken by hopper barge to a designated offshore disposal site. It says a frame-type silt curtain was used and hopper barges were tracked with a Dredging and Dumping Monitoring System. Turbidity and water quality were monitored at 17 locations across Port Reitz and Kilindini, Tudor Creek, the inner reef and the outer reef. The report says no two-week continuous turbidity threshold exceedance occurred, but it does not supply accepted dredging quantities or hydrographic release.
Commercial evidence boundary
TOA's approximately JPY 33.5 billion figure is the announced Package 1 contract amount, not a final account, paid value or marine-subcontract price. KPA and TOA have not published separate dredging, disposal, jacket, pile, ground-improvement or building values. JICA is the ODA lender and STEP financing source, not the marine contractor.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

KPA published the first DK1 monthly monitoring set and current field gallery

The KPA project page now exposes October-December 2025 monitoring reports and May-June 2026 field images. This confirms continued environmental oversight but does not establish current dredging production or package completion.

Source

Foundation dredging was active while channel and basin works remained unopened

KPA records quay and trestle foundation dredging, offshore disposal and cargo-yard works in December. It records no activity in the turning basin, navigation channel or permanent port facilities during the same period.

Source

TOA announced the Package 1 award

The award fixed KPA as employer, TOA as main contractor, an approximately JPY 33.5 billion value, a 1,156-day duration and the dredging, reclamation, jacket-quay and landside scope.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Measured quay-foundation and trestle-foundation dredging quantities
  • Start and completion of turning-basin and navigation-channel dredging
  • Dredging subcontractor, grab-dredger owner and support-vessel disclosures
  • Offshore disposal records and Dredging and Dumping Monitoring System results
  • Steel pipe pile, jacket fabrication and offshore installation contractors
  • Reclamation, PVD and cargo-yard ground-improvement progress
  • Resolution of the 214 m TOA and 363 m KPA trestle and causeway descriptions
  • Hydrographic acceptance at the stated minus 15 m design depth
  • Quay load testing, navigation release and port handover

Reporting status

Construction, confirmed confidence

Last checked 1 August 2026 across 4 cited sources. The dated timeline above carries the project events.
