Project record

West Point Coastal Defence Revetment

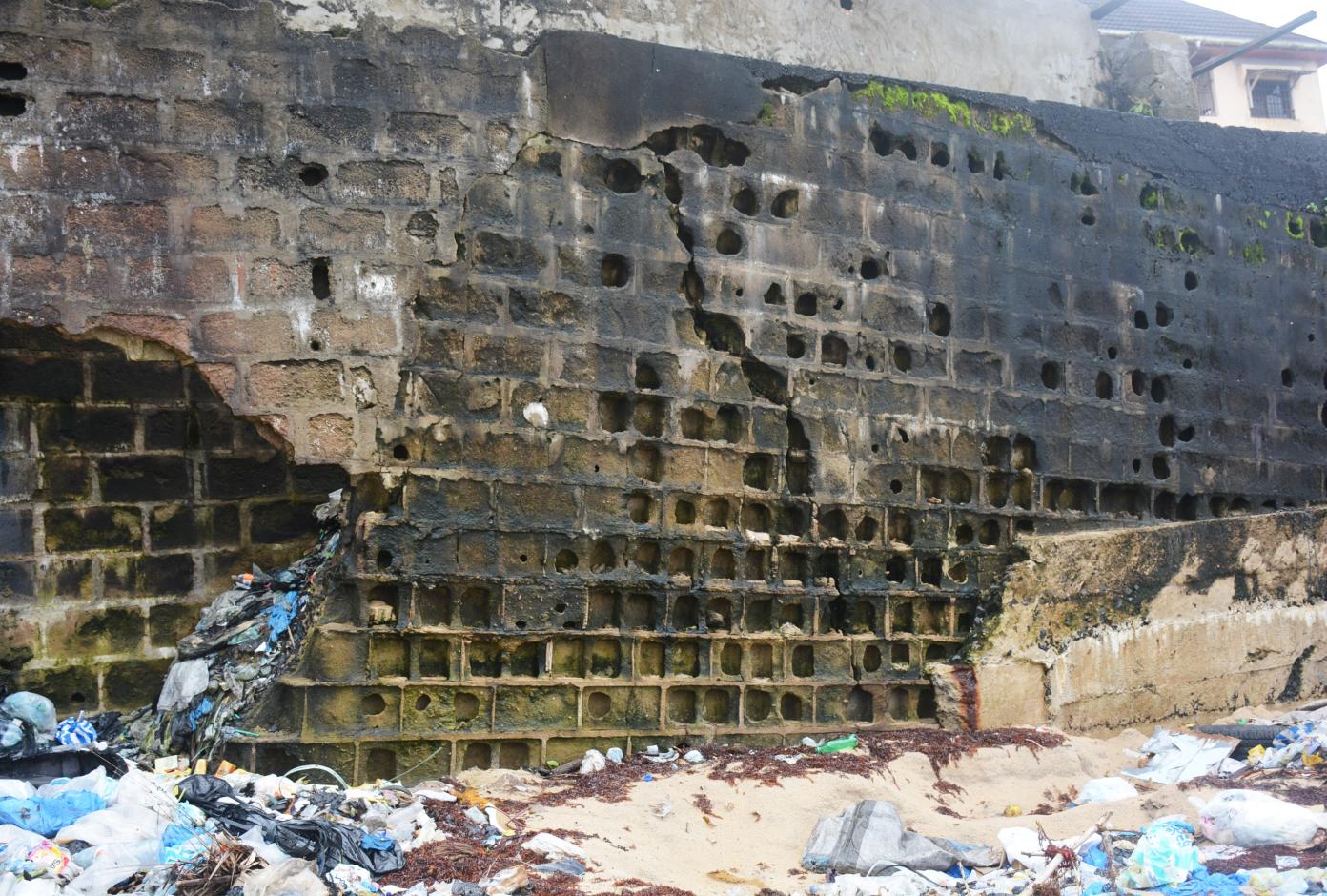

Eroded coastal wall and accumulated debris at West Point, Monrovia, illustrating the exposed shoreline condition addressed by the planned revetment

United Nations Development Programme Liberia

Liberia's Monrovia Metropolitan Climate Resilience Project plans a rock revetment at West Point, a densely occupied Atlantic shoreline where UNDP reports approximately 30 metres of retreat and the loss of 670 homes over the preceding decade. The Environmental Protection Agency permit published by UNDP on 4 March 2026 authorizes construction within defined UTM coordinates after approval of the environmental and social impact assessment. The wider GCF-financed project remains under implementation to July 2027. The construction contractor, executed works value, notice to proceed, mobilisation date and installed and accepted revetment are not identified.

Project signal

Approval in Liberia

Current status The West Point revetment has an approved ESIA and March 2026 environmental permit; construction award, notice to proceed and physical start are not established Source confidence Confirmed

Location

Liberia / Africa

Segment

Coastal infrastructure

Status

The West Point revetment has an approved ESIA and March 2026 environmental permit; construction award, notice to proceed and physical start are not established / Confirmed

Last checked

17 July 2026

Coverage

Related sectors

Coastal infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Government of Liberia through the Environmental Protection Agency and Ministry of Public Works, with UNDP support
Delivery parties
No coastal works contractor is identified
Contract route
The Monrovia Metropolitan Climate Resilience Project is financed through Green Climate Fund project FP160 and implemented with UNDP. GCF lists USD 17.255755 million of grant financing within a USD 25.6 million total project. Those figures cover the wider climate-resilience programme, not an executed West Point revetment contract. Contractor selection, works value and final risk allocation remain unverified.
Execution window
GCF records the project as under implementation from 21 July 2021 to an estimated completion on 21 July 2027. UNDP published the environmental permit on 4 March 2026. The official project page records completed met-ocean data collection and supporting design and safeguard preparation, but does not publish a coastal works award, notice to proceed, mobilisation or physical completion date.
Works package
The approved programme provides for coastal defence at West Point through a rock revetment, together with integrated coastal-zone management, mangrove protection, resilient livelihoods and community facilities. Earlier project design material describes a conceptual rubble-mound revetment with geotextile toe protection, shoreline access, a promenade and boat launching and landing interfaces. Those details remain design context until final issued-for-construction drawings and an executed works package are disclosed.
Marine interfaces
The controlled delivery system includes final met-ocean and shoreline design basis, permitted UTM limits, toe embedment and scour response, geotextile and filter layers, armour source and grading, quarry-to-site transport, wet-season and wave workability, drainage and flood pathways, interfaces with homes and the Mesurado wetlands, fishing-boat access, community safety, mangrove safeguards, construction monitoring and long-term maintenance responsibility.
Commercial evidence boundary
The project has crossed finance, ESIA and environmental-permit gates, but has not crossed the public award and mobilisation gates. The total GCF programme value must not be presented as the revetment contract value, and the permit must not be presented as evidence that a contractor is working. The current commercial watch is procurement formation, final scope control, material supply, community interface obligations and the conditions that convert authorization into accepted construction.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Liberia issued the West Point environmental permit

The permit authorises the revetment within defined coordinates after ESIA approval. No works contractor, contract value, notice to proceed, or mobilisation record has yet been published.

Source

The approved GCF proposal defined the financed programme boundary

The proposal set the wider climate-resilience budget and the concept for a West Point revetment. That programme budget is not a construction contract, and the design still had to pass through permits, final drawings, procurement, and field delivery.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Owner or UNDP solicitation, award and executed works value
  • Final issued-for-construction design and permit-condition matrix
  • Notice to proceed, contractor mobilisation and baseline survey
  • Armourstone source, grading, haulage and quality release
  • Toe, geotextile, filter and armour-layer inspection
  • Fishing access, promenade, homes, drainage and wetland interfaces
  • Environmental, social and community monitoring
  • Completion certificate, as-built records and maintenance funding

Reporting status

Approval, confirmed confidence

Last checked 17 July 2026 across 5 cited sources. The dated timeline above carries the project events.

Last checked 17 July 2026 Cited sources 5
