Project record

Kustlijnzorg South Holland nourishment (31205037)

Participation
Not assessed
Project facts checked

Van den Herik signed the EUR 16.302 million contract on 10 March 2026; Rijkswaterstaat schedules Maasvlakte 2 nourishment for September and names Van den Herik with Van der Kamp there, while mobilisation and the parties' commercial relationship remain unverified

Project sources

Rijkswaterstaat awarded Van den Herik Kust- en Oeverwerken B.V. contract 31205037 for six nourishment work packages at Scheveningen, Katwijk and Maasvlakte 2. Six issued work packages total 3.91 million m3 in situ: 435,000 m3 of beach and 690,000 m3 of foreshore nourishment at Scheveningen; 360,000 m3 of beach and 1 million m3 of foreshore nourishment at Katwijk; and 1.275 million m3 of beach plus 150,000 m3 of foreshore nourishment at Maasvlakte 2. Rijkswaterstaat's current schedule names Van den Herik and Van der Kamp for the September Maasvlakte 2 work, but does not specify a subcontract, joint venture, package allocation or payment chain.

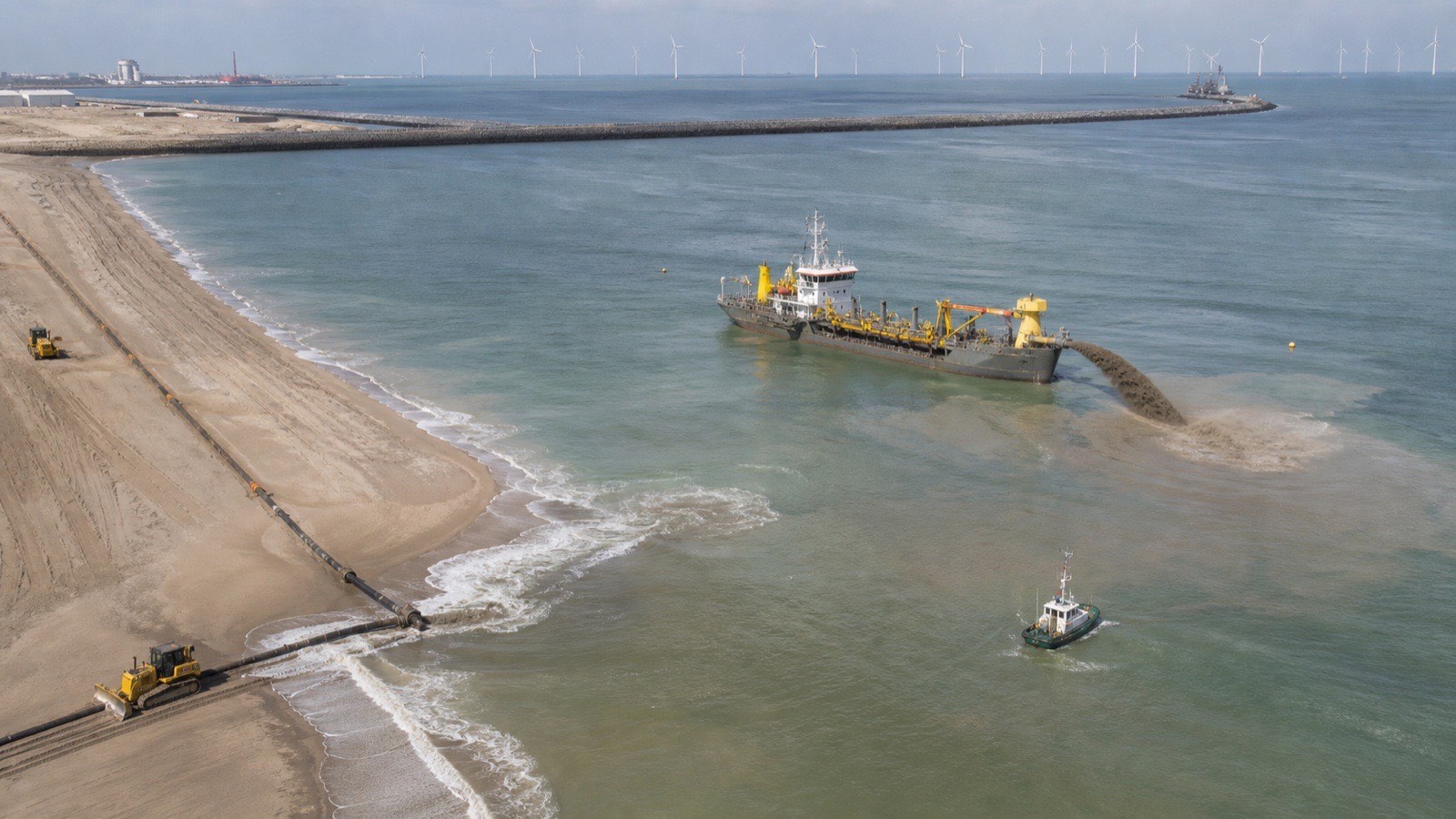

Aerial visualization of a trailing suction hopper dredger performing beach nourishment and foreshore nourishment at Maasvlakte 2

IMWO artist's impression of the published Kustlijnzorg South Holland nourishment (31205037) scope

Location

Netherlands / Europe

Segment

Beach and foreshore nourishment

Phase

Award / Confirmed

Last checked

7 August 2026

Coverage

Related sectors

Beach and foreshore nourishment is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Rijkswaterstaat Programma's, Projecten en Onderhoud
Delivery parties
Van den Herik Kust- en Oeverwerken B.V. - signed engineering and execution contractor, Bagger- en Aannemingsmaatschappij Van der Kamp B.V. - named by Rijkswaterstaat as an execution participant for Maasvlakte 2; commercial relationship and package allocation not specified, Assigned vessels, survey team, sand sources and other lower tiers - not identified in the reviewed official record
Contract route
For 31205037, Rijkswaterstaat ran an open European Engineering and Construct procedure under UAV 2012. Seven bids were received. TenderNed records Van den Herik Kust- en Oeverwerken B.V. as winner at EUR 16,302,000 excluding VAT and a contract signature date of 10 March 2026. The notice states no subcontracting was declared at award.
Execution window
The signed-release schedule spans 3 March 2026 to 15 December 2027. Rijkswaterstaat's current coast-maintenance page places the 1.425 million m3 Maasvlakte 2 beach and foreshore package in September 2026. Physical mobilisation at Maasvlakte 2, Scheveningen and Katwijk remains unconfirmed.
Works package
WP1 Scheveningen beach: 435,000 m3 in situ. WP2 Scheveningen foreshore: 690,000 m3. WP3 Katwijk beach: 360,000 m3. WP4 Katwijk foreshore: 1 million m3. WP5 Maasvlakte 2 beach: 1.08 million m3 plus 195,000 m3. WP6 Maasvlakte 2 foreshore: 150,000 m3. Combined indicated design volume is 3.91 million m3. The bestek's MARS measurement requirement adds 15% to each package's in situ design quantity for contractual measurement control; it is not an additional public completed-volume claim.
Marine interfaces
The contract combines three coast sectors, paired beach and underwater packages, TSHD production, bottom discharge and pipeline placement, hydrographic and topographic surveys, public beach access, environmental controls and interfaces with the Port of Rotterdam and Maasvlakte wind-turbine area. Vessel and package sequencing will determine mobilisation efficiency and navigational coordination.
Commercial evidence boundary
EUR 16.302 million is the signed legal contract value. The 3.91 million m3 in situ design total excludes any inference that MARS control quantities are additional accepted scope. The record leaves the Van den Herik-Van der Kamp commercial structure, package pricing, vessel day rates, certified progress, variations, payments and final account undisclosed.

Contract and delivery chain

Work packages and named roles

Published scope, named parties and supporting evidence for each workstream.

Legal award

31205037

Named party
Van den Herik Kust- en Oeverwerken B.V.
Evidence status
Confirmed
Source position
TenderNed records a EUR 16.302 million contract signed on 10 March 2026 after seven bids. Source
Designed nourishment scope

WP1-WP6

Named party
Rijkswaterstaat and Van den Herik
Evidence status
Confirmed
Source position
Final design documents indicate 3.91 million m3 in situ across Scheveningen, Katwijk and Maasvlakte 2. Source
Maasvlakte 2 execution planning

1.275 million m3 beach and 150,000 m3 foreshore

Named party
Van den Herik and Van der Kamp
Evidence status
Confirmed
Source position
Rijkswaterstaat's current schedule names both companies for September 2026, without specifying their commercial relationship. Source
Physical delivery and downstream chain

Mobilisation, workshare, production and acceptance

Named party
Not fully evidenced
Evidence status
Not evidenced
Source position
No reviewed official source proves mobilisation, assigned vessels, Van der Kamp's contract basis, placed quantities or acceptance.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Owner schedule names two Maasvlakte 2 execution participants

Rijkswaterstaat identifies Van den Herik and Van der Kamp for a September 2026 package matching the final 1.425 million m3 Maasvlakte 2 design scope, while leaving the commercial relationship undisclosed.

Source

Van den Herik signed contract 31205037

The EUR 16.302 million award fixed Van den Herik as legal main contractor for six South Holland nourishment work packages through 2027.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Maasvlakte 2 September mobilisation and exact start date
  • Van der Kamp contract, consortium or subcontract basis and workshare
  • Named TSHDs, support vessels and survey spread
  • Borrow area and sand-quality approvals
  • Beach versus foreshore placement sequence at Maasvlakte 2
  • Scheveningen and Katwijk notices to proceed
  • MARS measurement reconciliation against in situ design quantities
  • Certified production, variations, package completion and acceptance

Reporting status

Project phase
Award
Evidence confidence
Confirmed
Last checked
7 August 2026
Cited sources
4

Sources and related records

Project changes Methodology Email a correction Project tracker

Project sources 4
