Project record

Ringvaart 2 dredging

Participation
Not assessed
Project facts checked

Award signed; start unverified.

Project sources

Hoogheemraadschap van Schieland en de Krimpenerwaard has awarded Ringvaart 2 dredging to Aannemingsbedrijf Van der Lee B.V. The 23-month contract covers about 11.1 kilometres of canal and an estimated 108,000 cubic metres of dredged material. About 86,500 cubic metres is routed to an approved off-site processor and 21,500 cubic metres to a local grassland depot.

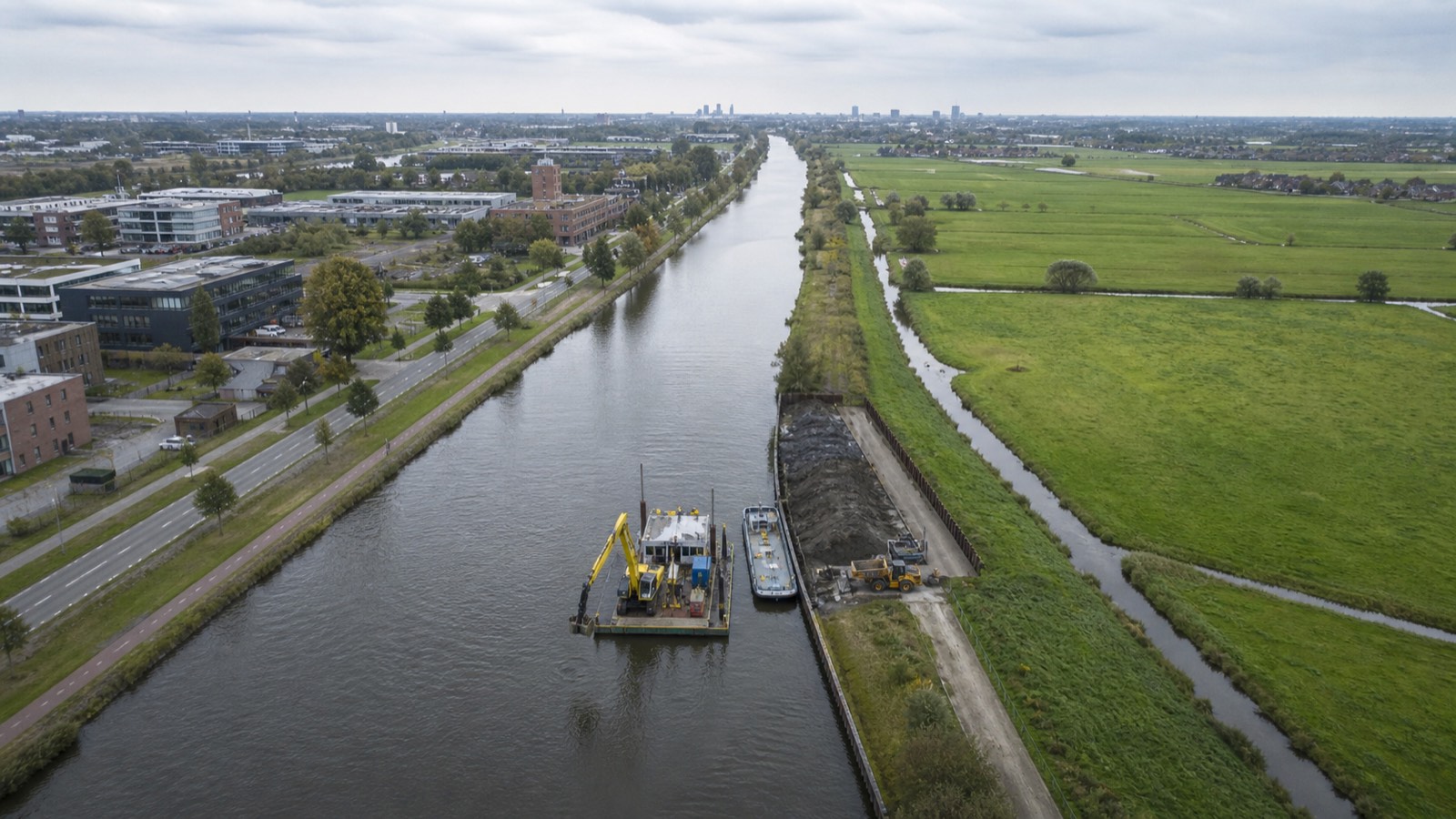

Aerial visualization of Ringvaart 2 canal dredging and sediment routing between an urban edge and Dutch polder with an approved processor and grassland depot represented as separate destinations

IMWO artist's impression of the published Ringvaart 2 dredging scope

Location

Netherlands / Europe

Segment

Dredging

Phase

Award / Confirmed

Last checked

9 August 2026

Coverage

Related sectors

Dredging is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Hoogheemraadschap van Schieland en de Krimpenerwaard (HHSK)
Delivery parties
Aannemingsbedrijf Van der Lee B.V. - signed prime contractor, Approved off-site sediment processor - not named, Grassland depot owner or operator, haulage, survey and monitoring parties - not named, TenderNed award disclosure states no subcontracting; do not infer that later suppliers or service providers are absent
Contract route
HHSK used an open procedure under reference A0380. Five bids were received, including one SME bid. The award used a 20 percent quality and 80 percent price weighting; Van der Lee was selected on 27 January 2026, the contract was signed on 17 February and the award notice was published on 18 February 2026.
Execution window
TenderNed gives an estimated contract duration of 23 months from the signed award. No notice to proceed, possession date, mobilisation record, dredging start, seasonal restriction, completion certificate or final-account date has been identified.
Works package
RAW specification WS-2026-02 covers about 11.1 kilometres of the Ringvaart: from Klaas Klinkertweg in Capelle aan den IJssel to the A16 in Rotterdam, and from Nieuwerkerk aan den IJssel to Moordrecht in Zuidplas. The estimated 108,000 cubic metres comprises about 86,500 cubic metres of non-spreadable material for an approved processor and 21,500 cubic metres of spreadable material for local placement in a grassland depot.
Marine interfaces
Delivery depends on linear canal access through urban and polder edges, navigation and water-level coordination, sediment classification, loading and transport controls, processor and depot acceptance, baseline and completion surveys, and reconciliation of estimated against measured quantities. The public award does not identify plant, access compounds, haul routes, processor capacity or temporary navigation controls.
Commercial evidence boundary
TenderNed reports a EUR 4,087,280.31 contract value excluding VAT against an estimated EUR 4,000,000, a difference of EUR 87,280.31. The notice does not allocate value between dredging, transport, processing, depot handling, surveys or monitoring and provides no payment, variation or final-account evidence.

Contract and delivery chain

Work packages and named roles

Published scope, named parties and supporting evidence for each workstream.

Prime contract

P1 Baggerwerk Ringvaart 2 / A0380

Named party
Aannemingsbedrijf Van der Lee B.V.
Evidence status
Confirmed
Source position
TenderNed records Van der Lee as winner, selection on 27 January 2026, contract signature on 17 February and a EUR 4,087,280.31 award value. Source
Canal dredging

Approximately 11.1 km and 108,000 m3 under WS-2026-02

Named party
Aannemingsbedrijf Van der Lee B.V.
Evidence status
Confirmed
Source position
The official award notice defines the canal sections and estimated aggregate volume; it does not report physical start or measured production. Source
Non-spreadable sediment route

Approximately 86,500 m3 to an approved processor

Named party
Processor not identified
Evidence status
Confirmed
Source position
The contract scope fixes the estimated off-site volume and approved-processor route but does not name the facility, carrier or acceptance protocol. Source
Spreadable sediment route

Approximately 21,500 m3 to a local grassland depot

Named party
Depot owner or operator not identified
Evidence status
Confirmed
Source position
The contract scope fixes the estimated local-routing volume but does not identify the depot, transport method or accepted capacity. Source
Execution and closeout

Mobilisation, surveys, measured quantities, acceptance and final account

Named party
Not evidenced
Evidence status
Not evidenced
Source position
No public record was identified for assigned plant, physical progress, measured quantities, processor or depot acceptance, completion or final account.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

TenderNed published the contract award

The award notice fixed the prime contractor, EUR 4.087 million value, estimated duration and sediment-routing split while execution evidence remained open.

Source

HHSK signed the Ringvaart 2 contract

The procurement moved from bidder selection into a signed delivery contract, without proving notice to proceed or mobilisation.

Source

Van der Lee selected as winner

The open procedure concluded with five bids and Van der Lee as the selected contractor before contract signature.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Notice to proceed and physical mobilisation
  • Assigned dredging, excavation, loading and transport plant
  • Approved processor and grassland-depot identities
  • Sediment testing and classification controls
  • Navigation, water-level and urban-access constraints
  • Measured quantities against the 108,000 m3 estimate
  • Processor and depot acceptance records
  • Completion certificate, variations and final account

Reporting status

Project phase
Award
Evidence confidence
Confirmed
Last checked
9 August 2026
Cited sources
4
