Project record

Norfolk Island Cascade Pier emergency remediation works

Participation
Not assessed
Project facts checked

GP Services' AUD 183,041 emergency-remediation period has elapsed without accepted completion evidence; the separate AUD 10 million apron project is in detailed design with Consult Marine, with no construction award or mobilisation published

Project sources

Australia's Department of Infrastructure awarded GP Services Garry George Parsons contract CN4144507 for Emergency Remediation Works at Cascade Pier. The official OCDS release records AUD 183,041, a limited tender and a period encoded from 14 April to 29 June 2025 UTC, but no accepted completion. A separate AUD 10 million apron-raising project reached detailed design by November 2025, with Consult Marine contracted for that phase. The June 2026 draft ports strategy defines the apron project as funded and staged while retaining request-for-tender and 2027 construction dates as planning milestones rather than achieved procurement or field events.

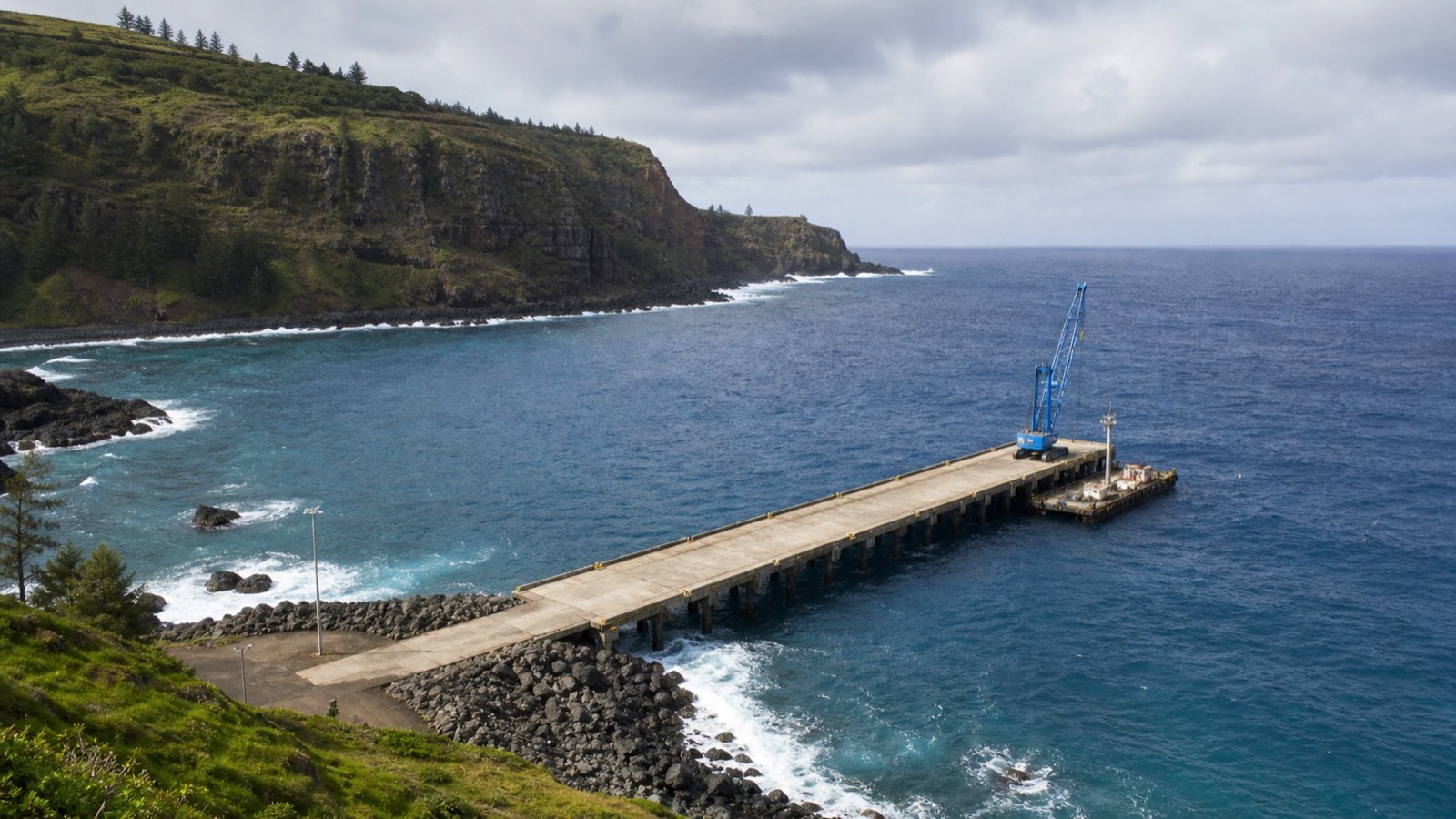

Reconstruction of Cascade Pier, a cargo pier and crane on Norfolk Island's exposed volcanic coast

IMWO artist's impression of the published Norfolk Island Cascade Pier emergency remediation works scope

Location

Norfolk Island / Global islands

Segment

Pier remediation and island freight access

Phase

Award / Confirmed

Last checked

10 August 2026

Coverage

Related sectors

Pier remediation and island freight access is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Australian Government Department of Infrastructure, Transport, Regional Development, Communications and the Arts
Delivery parties
GP Services Garry George Parsons - awarded supplier under emergency-remediation contract CN4144507, Consult Marine - contracted for the separate AUD 10 million apron project's detailed-design phase; no construction role is established, The reviewed records name no emergency-package subcontractor, apron construction contractor, surveyor, material supplier or acceptance authority
Contract route
CN4144507 is an Australian Government limited tender. The OCDS release cites paragraph 10.3.d.iii, supply by a particular business due to an absence of competition for technical reasons. The separate apron project has a named detailed-design consultant, Consult Marine. The June 2026 draft strategy scheduled development-application and request-for-tender activity for mid-2026, but the reviewed public chain does not establish that a construction tender was issued or awarded.
Execution window
The emergency OCDS period runs from 14 April 2025 at 14:00 UTC to 29 June 2025 at 14:00 UTC, corresponding to 15 April through 30 June in Norfolk Island time; elapsed dates do not prove completion. The June 2026 draft strategy says apron detailed design had been expected by early 2026, development application and request for tender in mid-2026 and construction in 2027. Those dates are a draft planning sequence, not proof that design was accepted, approvals were obtained or construction procurement began.
Works package
The emergency contract description stops at Emergency Remediation Works at Cascade Pier and does not identify defects, quantities, materials, temporary works, testing or acceptance. The separate apron Stage 2 concept raises a reinforced-concrete hardstand by about one metre, removes the existing ramps and dogleg, continues the eastern wave deflector toward shore and provides container-placement areas compatible with First Point of Entry operations and a future RoRo interface. None of that scope is assigned to CN4144507 or a construction contractor.
Marine interfaces
The draft strategy describes the existing pier as about 40 metres long and 10 metres wide, with about 1.5 metres minimum alongside depth, and says Cascade handles about 70% of pier use. Emergency repairs and future apron works must operate around swell, lighterage, fixed-crane activity, limited shore space, passenger and cargo-transfer vessels and continuity of essential freight. These owner-level constraints do not establish GP Services' or Consult Marine's means, plant, quantities or accepted output.
Commercial evidence boundary
AUD 183,041 is the disclosed value of CN4144507, not the value of the wider apron upgrade and not verified final spend. AUD 10 million is the separate apron project budget; the reviewed Consult Marine release gives no design-contract value. Adding the figures, assigning construction to GP Services or Consult Marine, or treating the emergency package as Stage 2 delivery would overstate the public record.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Draft ports strategy defined the apron Stage 2 scope and planning sequence

The consultation draft describes an approximately one-metre apron raise, hardstand and FPOE-compatible works, with construction scheduled for 2027; it does not prove design acceptance, tender issue, award or mobilisation.

Source

Consult Marine named for the separate apron detailed-design phase

The ministerial release identifies Consult Marine's design role on the AUD 10 million project without assigning emergency works or future construction to the consultant.

Source

Emergency remediation contract published

AusTender disclosed an AUD 183,041 limited-tender award to GP Services for Cascade Pier, with a period ending in June 2025 but no detailed repair or completion record.

Source

Government announced a separate AUD 10 million apron upgrade

The announcement defined a wider concept to repair, raise and extend the apron and add container handling facilities. Neither GP Services nor CN4144507 appears in it.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Issued emergency work order and defined damaged elements
  • Mobilisation, site-access and lighterage arrangements
  • Repair quantities, materials and testing requirements
  • Variations and final certified value
  • Completion, acceptance and reopening evidence
  • Named subcontractors, designers and suppliers
  • Owner confirmation of any relationship to the AUD 10 million apron upgrade
  • Apron detailed design, approval and request for tender
  • Apron construction award and contractor
  • Freight-continuity and cyclone-resilience acceptance

Reporting status

Project phase
Award
Evidence confidence
Confirmed
Last checked
10 August 2026
Cited sources
7
