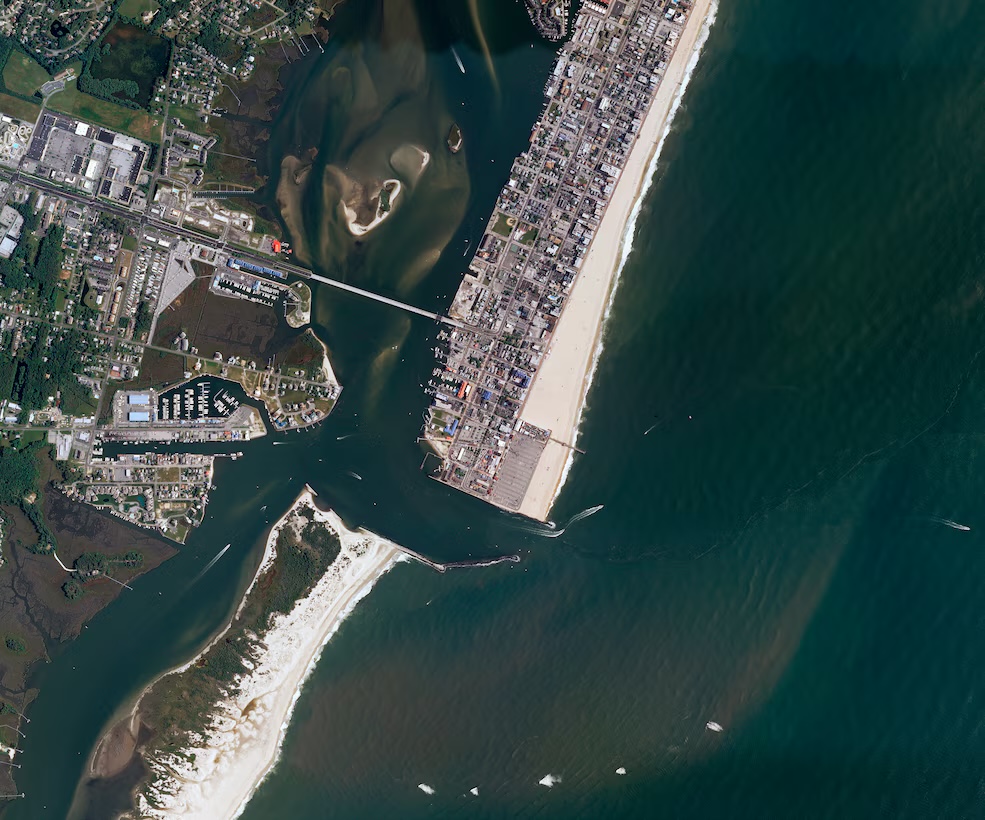

MURDEN's May 2026 assignment covered approximately 15,000 cubic yards from two Ocean City Inlet shoaling areas. USACE planned to place the material south of the inlet, offshore Assateague Island, through the authorized split-hull bypass route.
Project signal
Construction in United States
Treat the May quantity and Assateague route as the published plan, not as measured output. The November 2025 cycle is a separate completed operation, while the longer-term channel realignment and rock structures remain a proposal rather than an awarded construction package.
Current statusUSACE scheduled MURDEN to work through May 2026; measured production and completion remain unpublishedSource confidenceConfirmed
Location
United States / Americas
Segment
Port infrastructure
Status
USACE scheduled MURDEN to work through May 2026; measured production and completion remain unpublished / Confirmed
Evidence reviewed
18 July 2026
Controlled taxonomy
Related sectors
The detailed segment above is the primary work classification. These broader sector links connect the project to related delivery and market research.
Knowledge context
Related knowledge topics
Continue through the topic collections to compare this record with related projects, evidence guides, briefs, articles, reports, and performance records.
Project anatomy
Scope, counterparties, and execution logic
Client / authority
U.S. Army Corps of Engineers, Baltimore District
Delivery parties
USACE dredge MURDEN; no external dredging contractor identified for the May 2026 cycle
Contract route
Federal operations-and-maintenance work carried out with the USACE split-hull hopper dredge MURDEN. The reviewed May 2026 release gives no external contract award or contract value.
Execution window
USACE announced the cycle on 8 May 2026 and planned work through May. The actual start, finish and accepted quantity are not published.
Works package
Remove approximately 15,000 cubic yards from Priority Area 1 at the entrance to Sinapuxent Channel and a secondary oceanside shoaling area, then place the material south of the inlet offshore Assateague Island through the authorized split-hull bypass route
Marine interfaces
Shallow inlet navigation, recurring shoaling, hopper-dredger access, two excavation areas, split-hull placement offshore Assateague Island and coordination with an authorized channel maintained to 10 feet plus two feet of allowable overdepth when funding permits
Commercial read
This is a recurring public-plant maintenance cycle rather than a newly awarded contractor package. The recurring market requirement is to connect navigation dredging with a sediment-bypass destination and survey control. The 15,000 cubic yards is planned scope, not achieved production, and the broader realignment concept has no award or construction start.
Next milestone
Publish measured May 2026 production, route-specific placement evidence, post-dredge survey and USACE completion; separately track any funded decision on the long-term navigation proposal
Material change register
What changed, when, and what it proves
Only source-bound events that alter phase, scope, counterparties, delivery, completion, commissioning, or acceptance are listed. A change can advance the record without proving the next gate.
USACE published the May dredging and bypass plan
Baltimore District identified approximately 15,000 cubic yards across two shoaling areas, assigned MURDEN and named the authorized offshore Assateague placement route. The release is a work plan and does not publish measured production or completion.
The preceding MURDEN cycle removed nearly 13,000 cubic yards
The May 2026 release reports the result of the previous November operation. That measured quantity belongs to the prior cycle and should not be carried forward as 2026 production.
The draft long-term navigation study completed public review
The programme page records a draft channel realignment and structural concept. The draft has not advanced to a funded award, final construction package or completed works.
Publish measured May 2026 production, route-specific placement evidence, post-dredge survey and USACE completion; separately track any funded decision on the long-term navigation proposal
Decision watchpoints
MURDEN mobilisation and dated field evidence for the May 2026 cycle
Measured excavation against the approximately 15,000-cubic-yard plan
Production from Priority Area 1 and the secondary oceanside shoaling area
Documented split-hull placement south of the inlet offshore Assateague Island
Post-dredge hydrography across the authorized 10-foot channel and allowable overdepth
USACE completion and acceptance of the May cycle
Any funded decision on the separate long-term channel realignment and structural proposal
This public project page is a tracked market record rather than a tender notice, contractual commitment, or commercial instruction. Use the status, confidence label, evidence-review date, and source note together when judging how much weight to place on the signal.
Evidence reviewed date is not a project-event date.
IMWO changes phase, participants, scope, completion, or acceptance wording only when a dated source establishes the change. The review date records when the evidence set was checked; it does not claim that physical work changed on that date.
Evidence reviewed18 July 2026Sources in this record6
Source record
The 8 May 2026 Baltimore District release controls the approximately 15,000-cubic-yard plan, two dredging areas, MURDEN assignment, May window and authorized placement south of the inlet offshore Assateague Island. Its accompanying MURDEN image was taken on 23 November 2025 and is historical context, not May 2026 progress. The Ocean City programme page controls the authorized 10-foot channel, two-foot allowable overdepth, chronic shoaling, funding constraint and relationship between navigation maintenance and the Assateague sediment bypass. The same page describes a proposed 3,360-foot channel realignment and rock structures; that concept remains a proposal and is not reported here as awarded or under construction. A later statement in the May release records nearly 13,000 cubic yards removed in November 2025, superseding the earlier 5,000-cubic-yard schedule for that prior cycle.
Phase: construction. Evidence reviewed: 18 July 2026.
