Project record

Ramayapatnam Port capital deepening works

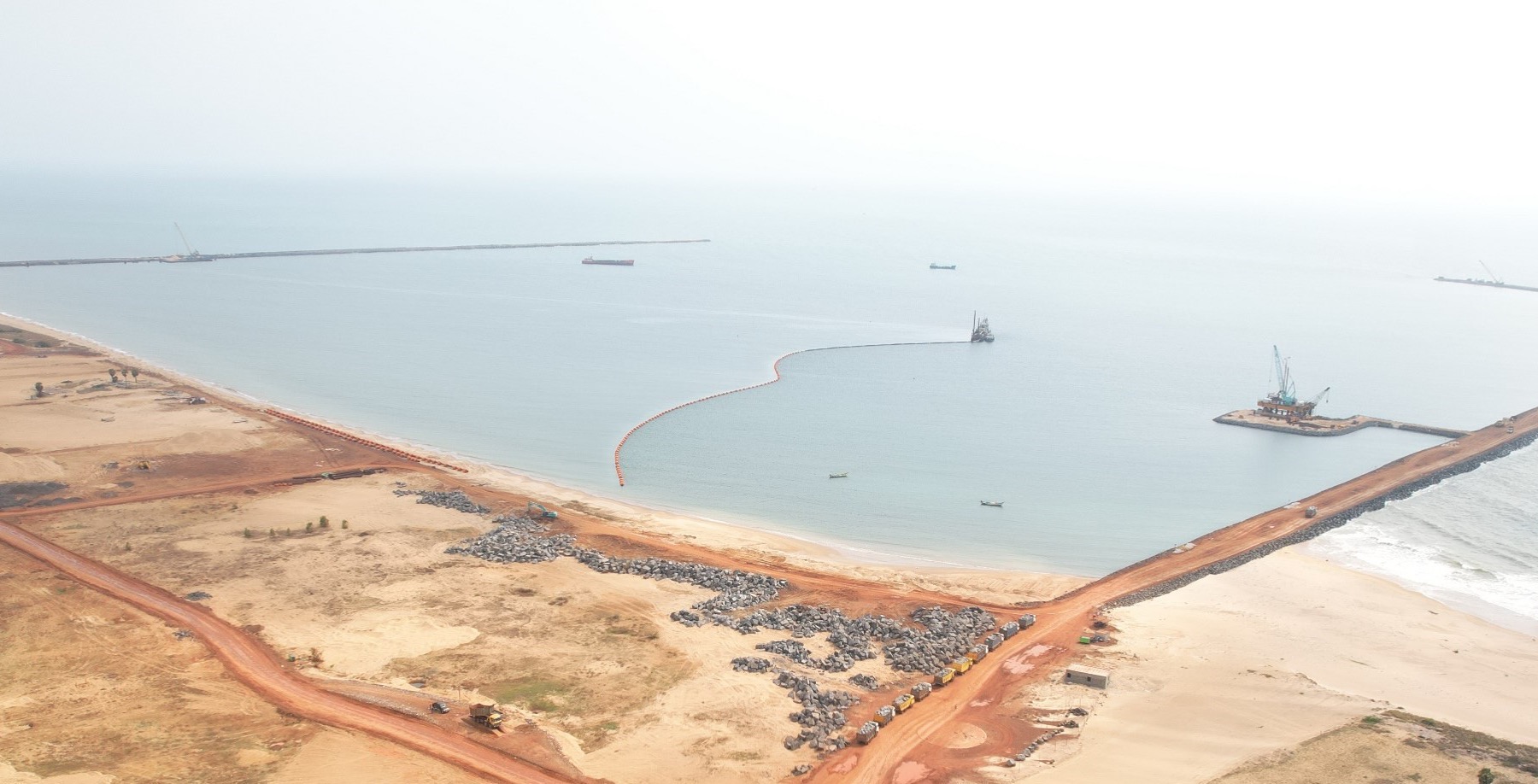

Aerial view of Ramayapatnam Port's forming harbour basin and two breakwaters on the Bay of Bengal

Xbloc / Holcim Coastal

Ramayapatnam Phase I was reported 52.95% complete against a INR 4,929.39 crore whole-port baseline on 4 April 2025 and remained officially under construction in February 2026. DEME's 16 June award is a later capital-deepening package for the harbour basin, turning circle, four berth pockets, and reclamation pumping; neither the whole-port percentage nor the award proves dredging mobilisation or accepted 15.5-metre access.

Project signal

Award in India

Current status Greenfield port under construction; capital-deepening package awarded, mobilisation unconfirmed Source confidence Confirmed

Location

India / Asia Pacific

Segment

Port infrastructure

Status

Greenfield port under construction; capital-deepening package awarded, mobilisation unconfirmed / Confirmed

Last checked

16 July 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Navayuga Engineering Company Limited for the DEME package; Andhra Pradesh Maritime Board for the wider port
Delivery parties
DEME, Navayuga Engineering Company Limited / Auro Infra Private Limited joint venture for wider port works
Contract route
Greenfield non-major port under Andhra Pradesh Maritime Board delivery, with wider port works by the Navayuga-Auro joint venture and a separately awarded capital-deepening package from Navayuga to DEME
Execution window
No execution timing is stated for the DEME package; the reviewed February 2026 government record confirms the wider port remained under construction
Works package
DEME capital deepening of the harbour basin, turning circle, and four berth pockets, with cutter-suction-dredger production and onshore pumping for reclamation; wider Phase I includes two breakwaters, berths, navigation systems, and road and rail interfaces
Marine interfaces
Cutter-suction dredging, reclamation containment and formation, 1,350-metre north and 3,700-metre south breakwaters, berth pockets, turning circle, completion hydrography, aids, VTMS, and Panamax access
Commercial evidence boundary
DEME's share is valued at up to EUR 50 million. It is a later package inside a port reported at INR 4,929.39 crore and 52.95% whole-port progress in April 2025; the values and percentages have different scopes and dates and must not be combined.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

DEME received the capital-deepening package

Navayuga awarded DEME capital deepening of the harbour basin, turning circle and four berth pockets, using a cutter suction dredger and onshore pumping for reclamation. The award does not establish mobilisation, dredged quantity, accepted depth or Phase I completion.

Source

The Tettu serving-station yard reached an advanced stage

The Railways ministry said RPDCL was developing the approximately 5.5-kilometre Ramayapatnam-to-Tettu connection under the Gati-Shakti Multi-Modal Cargo Terminal Policy and that work on the serving-station yard was at an advanced stage. It did not provide a completion date or establish completed rail access and cargo-evacuation readiness.

Source

The port remained officially under construction

The Ministry of Ports, Shipping and Waterways listed Ramayapatnam among four Andhra Pradesh ports under construction. This is a portfolio-status confirmation, not a package percentage, completion date or operating approval.

Source

Government reported 52.95% whole-port progress

A Lok Sabha answer recorded the INR 4,929.39 crore port under implementation at 52.95% and described 34.04 MMTPA Phase I capacity. The percentage predates the DEME award by more than a year and cannot be used as dredging-package progress.

Source

North-breakwater, navigation-aid and VTMS funding remained proposals

Parliament listed INR 409.05 crore for the north breakwater, INR 12.59 crore for fire-fighting and navigational aids, and INR 34.35 crore for VTMS among Andhra Pradesh proposals. The ministry requested restructuring and alternative funding exploration; the list is not award or completion evidence.

Source

Andhra Pradesh recorded initiation of the greenfield port

The SPSR Nellore district event register records initiation of the greenfield Ramayapatnam Port. It establishes the start boundary for the wider programme, not the later DEME package or completion of any marine element.

Source

Phase I received environmental and CRZ clearance

The Ministry of Environment, Forest and Climate Change granted environmental and coastal-regulation-zone clearance for Phase I subject to project-specific and standard conditions. Clearance enabled the programme but did not award works, approve every later design change or prove construction acceptance.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Cutter-suction-dredger mobilisation and execution schedule
  • Harbour-basin, turning-circle, and berth-pocket quantities
  • Onshore pumping, reclamation containment, settlement, and ground performance
  • Completion hydrography and accepted navigation depth
  • North and south breakwater completion and armour acceptance
  • Aids, VTMS, rail interface, berth readiness, port handover, and first vessel access

Reporting status

Award, confirmed confidence

Last checked 16 July 2026 across 12 cited sources. The dated timeline above carries the project events.

Last checked 16 July 2026 Cited sources 12

Sources and related records

Read featured analysis Methodology Submit a correction Project tracker

Project sources 12
