Project record

Roberts Bank Terminal 2 landmass and wharf

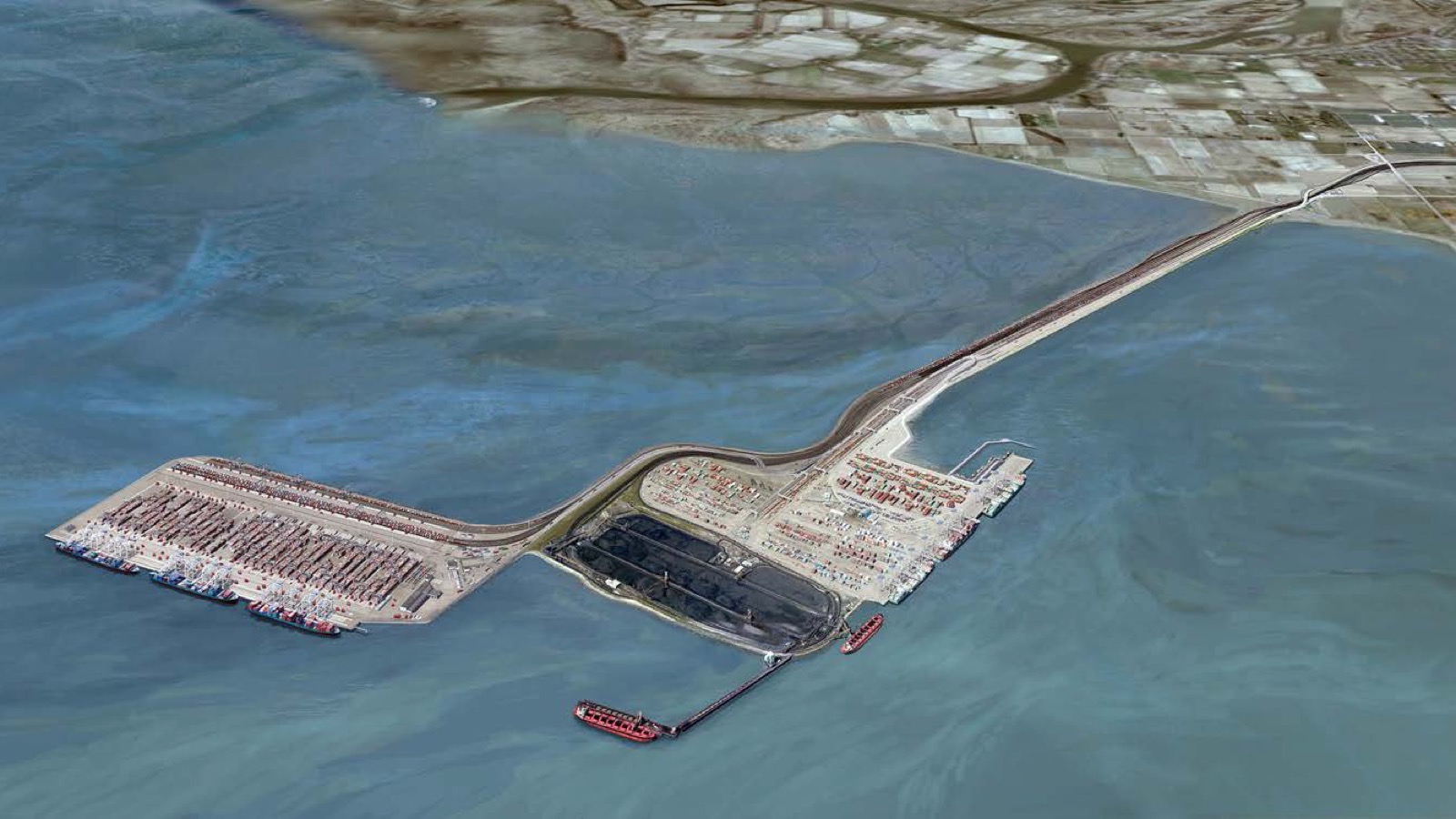

Official planning rendering of the proposed Roberts Bank Terminal 2 beside the existing Roberts Bank terminals and causeway

Vancouver Fraser Port Authority; 2015 planning rendering via Impact Assessment Agency of Canada

Vancouver Fraser Port Authority has selected TerraMarine as preferred proponent for the principal marine package at Roberts Bank Terminal 2. The progressive design-build scope covers the marine landmass, three-berth wharf and berth pocket, widened causeway, expanded tug basin and selected environmental mitigation. TerraMarine now enters planning and contract negotiations; the authority says a target-price agreement would follow sufficient initial work and financial close. Canada's live permit dashboard separately lists one authorization required before construction: the Fisheries Act authorization remains in progress, with 0 of 1 permits completed and no decision date.

Project signal

Design in Canada

Current status TerraMarine is preferred proponent; contract negotiations, an in-progress Fisheries Act authorization and development work precede any target-price design-build agreement, financial close or mobilisation Source confidence Confirmed

Location

Canada / Americas

Segment

Port infrastructure

Status

TerraMarine is preferred proponent; contract negotiations, an in-progress Fisheries Act authorization and development work precede any target-price design-build agreement, financial close or mobilisation / Confirmed

Last checked

10 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Vancouver Fraser Port Authority
Delivery parties
TerraMarine, preferred proponent: FlatironDragados Canada, Van Oord Canada, Aecon Constructors and Carlson Construction Group, Arcadis Professional Services Canada, supported by Stantec, TYPSA and Tetra Tech Canada
Contract route
Competitive progressive design-build procurement with a target-price model. The authority issued the RFQ in July 2025, shortlisted three teams in November and received proposals in late May 2026. TerraMarine was named preferred proponent on 13 July 2026, subject to final contract negotiations. The authority intends to award a target-price design-build agreement only after the initial work has advanced sufficiently and financial close has occurred.
Execution window
The authority places financial close, construction mobilisation and early works in late 2027, followed by land reclamation from 2028 and terminal operations in the mid-2030s. These are current targets, not achieved milestones or an executed construction baseline.
Works package
Deliver the marine landmass; three-berth wharf structure and berth pocket; widened Roberts Bank causeway; expanded tug basin; and selected environmental mitigation and offsetting works for a terminal planned on approximately 320 acres of new industrial land
Marine interfaces
The package joins reclamation and berth-pocket formation to a new wharf, live deep-water navigation, tug access, the existing Roberts Bank causeway and adjacent Deltaport and Westshore operations. Federal approval carries 370 legally binding conditions, the provincial certificate adds enforceable construction and environmental-management requirements, and the current federal dashboard keeps the Fisheries Act authorization open before construction.
Commercial evidence boundary
TerraMarine has preferred-proponent status, not a signed target-price design-build contract. The public release does not disclose a target price, final contract value, financial-close terms or notice to proceed. The current federal permit dashboard records 0 of 1 completed and no Fisheries Act authorization decision. The separate memorandum with Global Container Terminals is an exploration of a future operating and development agreement, not a terminal concession or operator award.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Current federal dashboard keeps the Fisheries Act authorization open

The monthly IAAC dashboard lists one construction-enabling authorization, records 0 of 1 completed and shows no decision date. Its 89% display is elapsed target-window time, not permit or construction progress.

Source

Canada referred the Port of Vancouver Gateway Strategy to the Major Projects Office

The federal record places RBT2 within the wider gateway strategy and describes the project as well advanced in regulatory and project planning. Referral does not replace the target-price agreement, financial close, permits or construction evidence.

Source

TerraMarine became preferred proponent for the landmass and wharf package

The selection identifies the construction and design team and starts collaborative planning and negotiations. The authority says the target-price agreement follows sufficient initial work and financial close.

Source

British Columbia issued its environmental assessment certificate

The provincial certificate added 16 legally enforceable conditions after the federal approval. It did not authorize the site to be reported as under construction.

Source

Federal approval imposed 370 legally binding conditions

The decision statement approved the three-berth terminal, widened causeway and expanded tug basin subject to a substantial compliance programme.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Completion of contract negotiations with TerraMarine
  • Scope and terms of the initial collaborative development work
  • Financial close and executed target-price design-build agreement
  • Final design for the landmass, wharf, berth pocket, causeway and tug basin
  • Fisheries Act authorization decision; the federal dashboard currently records 0 of 1 permits completed and no decision date
  • Construction logistics, material sources, reclamation and dredged-material routes
  • Marine mobilisation and early works now targeted for late 2027
  • Land reclamation start now targeted for 2028
  • As-built berth pocket, tug basin, wharf and causeway acceptance
  • Terminal concession, operator agreement and opening in the mid-2030s

Reporting status

Design, confirmed confidence

Last checked 10 August 2026 across 6 cited sources. The dated timeline above carries the project events.

Last checked 10 August 2026 Cited sources 6

Sources and related records

Read featured analysis Methodology Submit a correction Project tracker

Project sources 6
