Project record

Rosarito 2,200 l/s desalination procurement

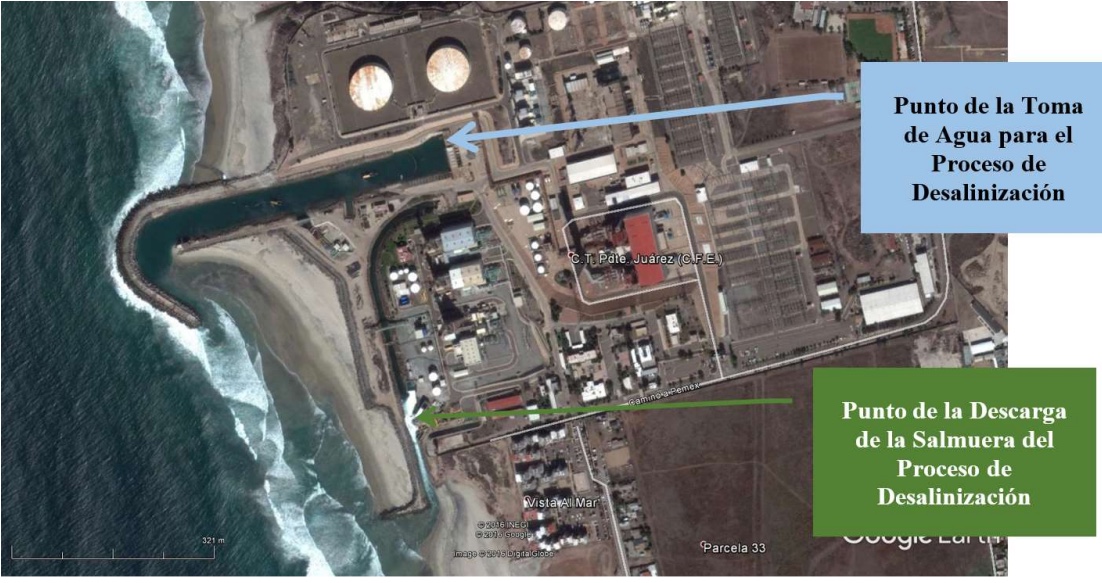

Annotated aerial view of the Rosarito desalination site showing the CFE cooling-water intake and brine-discharge route

Proyectos Mexico / Banobras

Mexico has restarted procurement for the first 2,200 l/s module of the Rosarito desalination plant. The current Compras MX detail lists invitation procedure IO-16-B00-016B00985-I-148-2026 as vigente, with proposal opening deferred to 24 July at 11:00 and the ruling scheduled for 29 July at 17:00. A September 2025 federal-state agreement includes seawater intake, brine discharge, conveyance, storage, connections and electrical works in the wider project, while the current procedure description names the plant and pumping plant only.

Project signal

Tender in Mexico

Current status Compras MX lists the invitation as current, with proposal opening deferred to 24 July 2026 and the ruling moved to 29 July; no award is published Source confidence Confirmed

Location

Mexico / Americas

Segment

Marine utilities

Status

Compras MX lists the invitation as current, with proposal opening deferred to 24 July 2026 and the ruling moved to 29 July; no award is published / Confirmed

Last checked

18 July 2026

Coverage

Related sectors

Marine utilities is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
Comision Nacional del Agua and the Government of Baja California
Delivery parties
No construction or marine works contractor selected; Compras MX lists the invitation as vigente
Contract route
Compras MX lists international open invitation-to-at-least-three-persons procedure IO-16-B00-016B00985-I-148-2026 under internal reference LPIA-AN-019-2026. The legal basis is the exception available after a public tender is declared void without changing its requirements. The current record gives a 10 July site visit, 13 July clarification meeting, proposal opening on 24 July at 11:00 and ruling on 29 July at 17:00. It also carries an annex titled as a notice deferring the proposal-opening date and time. No invited firms, award or contractor are published in the reviewed detail.
Execution window
Compras MX gives 31 July 2026 as the estimated contract start, 1 August as the estimated physical start and 1,096 calendar days across four fiscal years. These are tender-stage dates, not achieved milestones. The procedure remained vigente when reviewed on 18 July 2026.
Works package
The current CONAGUA summary describes construction of the Rosarito desalination plant and a pumping plant serving Tijuana and Playas de Rosarito. The September 2025 coordination agreement defines the wider first-module project as the plant, intake works, brine discharge, a conveyance line, the Rosarito tank, intake and discharge connections, electrification and electromechanical works. The reviewed invitation summary does not show whether all of those components are included in one contract.
Marine interfaces
The 2025 agreement expressly includes intake works, brine discharge and their connections. The 2024 environmental file describes a larger 4,400 l/s site using idle cooling-water intake boxes and the discharge canal at the CFE Presidente Juarez power station. That environmental envelope supports the coastal route, but it does not prove that the entire 4,400 l/s arrangement or a separate offshore package belongs to the current 2,200 l/s invitation.
Commercial evidence boundary
Rosarito is a live desalination construction opportunity with a confirmed marine interface, but the public detail is still not enough to price or qualify the coastal scope. Compras MX sets a 50:50 technical-economic points split, a 30% advance, a 10% performance guarantee and separate liability and environmental insurance each at 10%. Those are tender terms, not a contract award or final allocation to the intake and discharge works. The proposal opening, ruling, invited firms and signed package boundary remain unpublished.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Compras MX deferred the opening and ruling

The live procedure detail moved proposal opening from the earlier 21 July programme date to 24 July at 11:00 and lists the ruling for 29 July at 17:00. An annex is identified as the notice deferring the proposal-opening date and time.

Source

CONAGUA opened a new invitation procedure

The project returned to procurement after the previous public tender was declared void. The new register schedules proposals for 21 July and a ruling for 24 July.

Source

Environmental resolution was reported delivered

The reported approval advanced the project beyond environmental review while retaining conditions around the existing CFE intake and discharge route.

Source

Federal-state coordination agreement was published

The agreement fixed the current first module at 2,200 l/s and listed the plant, intake, brine discharge, conveyance, storage, connections and electrical works as project components.

Source

SEMARNAT recorded the environmental filing

The filing described a 4,400 l/s full-site envelope using existing CFE cooling-water intake boxes and the power station's discharge canal for brine return.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Invitation documents and the exact scope attached to procedure IO-16-B00-016B00985-I-148-2026
  • Proposal opening on 24 July, ruling on 29 July and the signed contract after the deferred dates
  • Names of invited firms and the selected construction contractor
  • Allocation of intake, brine discharge, CFE connections and conveyance works
  • Final use of the Presidente Juarez power-station cooling-water boxes and discharge canal
  • Construction start, marine method statements and environmental compliance conditions

Reporting status

Tender, confirmed confidence

Last checked 18 July 2026 across 5 cited sources. The dated timeline above carries the project events.

Last checked 18 July 2026 Cited sources 5
