Project record

NEOM green-ammonia export jetty

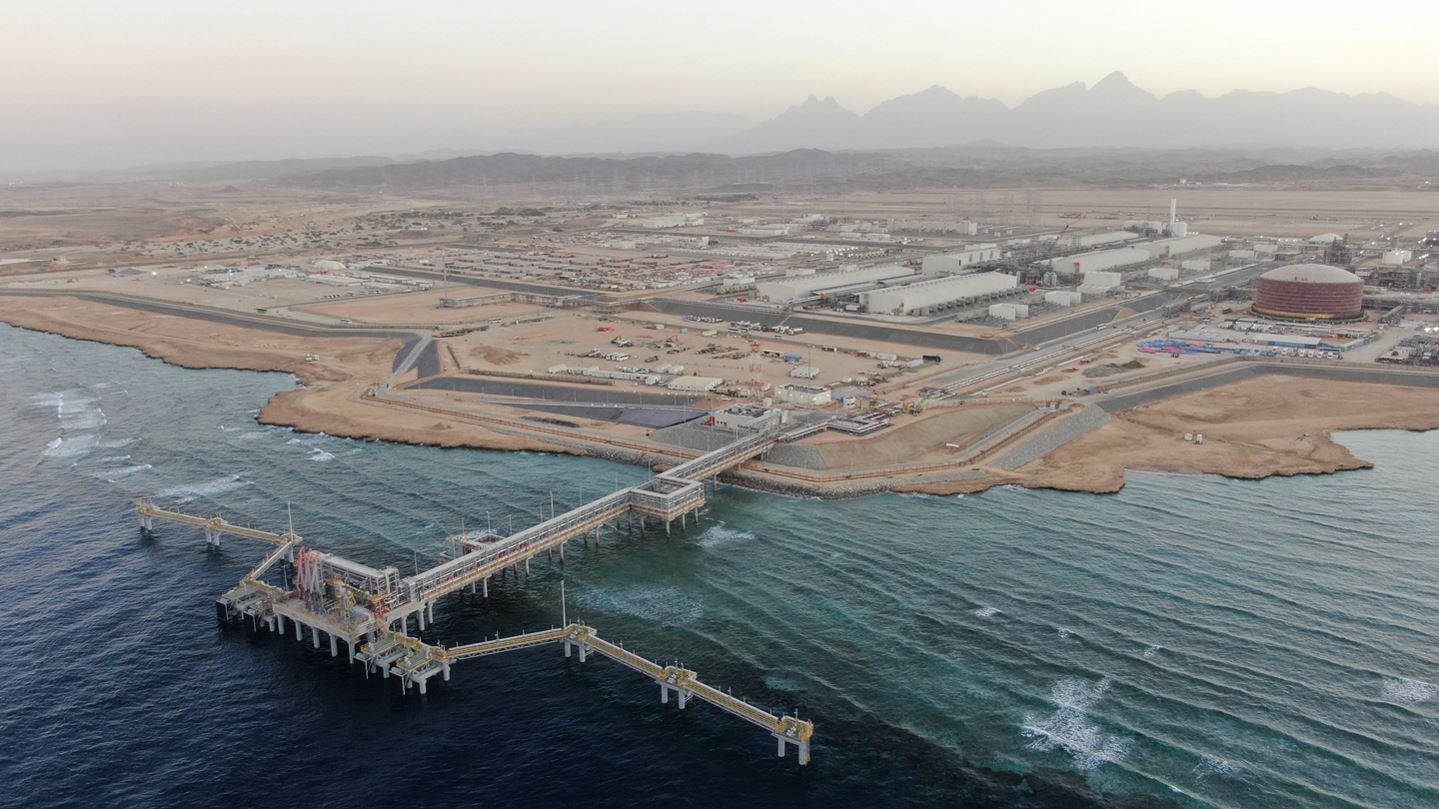

Aerial view of the completed-form NEOM green-ammonia export jetty, trestle, loading platform and storage complex at Oxagon

Air Products; exact NEOM Green Hydrogen Project and marine export jetty

NEOM Green Hydrogen Company is completing a purpose-built liquid-ammonia export jetty at Oxagon for up to 1.2 million tonnes per year of green ammonia. NGHC reported the integrated project above 90% complete in March 2026, and Air Products now describes construction in final completion with commissioning started through energization. The marine chain is unusually visible: Air Products is primary EPC and system integrator, Jacobs is the named jetty consultant, Saudi Archirodon is the marine contractor, Longitude supported the tanker-interface design and EPC process, and disclosed downstream roles include Velosi, EMJ Permadec, ICS Technologies and MarinTel. VTS radar commissioning is a component milestone, not proof of an accepted berth or first export cargo.

Project signal

Commissioning in Saudi Arabia

Current status Overall complex above 90% complete; energization and commissioning started, with jetty VTS radar commissioned but first ammonia transfer not confirmed Source confidence Confirmed

Location

Saudi Arabia / Middle East

Segment

Deep-water ports and energy terminals

Status

Overall complex above 90% complete; energization and commissioning started, with jetty VTS radar commissioned but first ammonia transfer not confirmed / Confirmed

Last checked

1 August 2026

Coverage

Related sectors

Deep-water ports and energy terminals is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
NEOM Green Hydrogen Company, an equal joint venture of ACWA Power, Air Products and NEOM
Delivery parties
Air Products - primary EPC contractor, system integrator and exclusive green-ammonia offtaker, Jacobs - marine jetty consultant named in downstream project records, Saudi Archirodon Co Ltd - marine jetty contractor, Longitude Engineering, an ABL Group company - FEED review, risk review, tender and EPC support, multidisciplinary engineering and tanker-interface support, Velosi - material-selection and marine-jetty engineering support assigned by Jacobs, EMJ Permadec - more than 550 m2 of permanent composite formwork across eight panel types for the approach-trestle deck, ICS Technologies - STRAITMASTER radar system for the marine-jetty VTS, MarinTel - VTS installation and acceptance collaboration identified by ICS Technologies
Contract route
NGHC placed the USD 6.7 billion integrated EPC agreements with Air Products. Public downstream records identify Jacobs as jetty consultant and Saudi Archirodon as marine contractor. Air Products appointed Longitude for design and tanker-interface support; Jacobs assigned Velosi for the marine-jetty material-selection and engineering work; Saudi Archirodon's supply chain includes EMJ Permadec for trestle-deck formwork. ICS Technologies and MarinTel appear in the commissioned VTS radar chain. Several operational and marine-equipment packages remain undisclosed.
Execution window
Full notice to proceed followed financial close in 2023. EMJ Permadec says its trestle-deck panels were delivered by the end of February 2024. NGHC reported more than 90% overall completion on 26 March 2026 and retained first green-ammonia availability in 2027. Air Products' current project page says construction is in final completion and commissioning started with energization. ICS Technologies disclosed VTS radar installation and commissioning on 3 March 2026. First liquid-ammonia transfer and sustained export service remain outstanding.
Works package
The disclosed marine facility comprises an access trestle and pipe rack, liquid-ammonia transfer pipelines from storage, loading platform, breasting dolphins, mooring dolphins, walkways, operator safe haven, substation and control building, roads, utilities and shore protection. The jetty is designed to transfer refrigerated ammonia directly to tanker ships. Longitude's work covers metocean, geotechnical, civil, structural, electrical, marine and tanker-interface reviews. Public records do not allocate the loading arms, fenders, quick-release hooks, navigation aids beyond VTS radar, tugs, pilots or hydrographic acceptance.
Marine interfaces
The storage tanks, refrigerated-ammonia pipeline, trestle pipe rack, loading platform, loading arms, berth and mooring structures, emergency shutdown and release logic, firewater and utility systems, VTS, pilotage, towage and tanker procedures must be tested as one export chain. The environmentally sensitive Red Sea setting adds coral, shoreline and navigation controls to dimensional, cryogenic, structural and operational acceptance.
Commercial evidence boundary
The main EPC, consultant and marine civil chain is placed and late-stage. Unallocated packages include loading arms, fenders, bollards or quick-release equipment, fire and gas systems, ESD, telecoms, navigation aids, hydrographic survey, tugs, pilotage, tanker-compatibility work and commissioning support. VTS commissioning narrows one operating-system gap, while berth and cargo-transfer acceptance remain outstanding.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

Air Products reported final completion and energization-led commissioning

The EPC contractor's current investor record moves the integrated complex into commissioning, while leaving marine handover, loading-system acceptance and first cargo unconfirmed.

Source

NGHC reported more than 90% overall construction completion

The owner retained first green-ammonia product availability in 2027 and placed the project in late execution rather than commercial operation.

Source

The marine-jetty VTS radar entered commissioned status

ICS Technologies reported installation and commissioning of its STRAITMASTER radar with MarinTel, closing a VTS component gate but not the full berth-acceptance chain.

Source

EMJ Permadec completed approach-trestle formwork deliveries

The supplier delivered more than 550 m2 across eight permanent-formwork panel types to Saudi Archirodon's jetty package, confirming the Jacobs and Saudi Archirodon marine chain.

Source

NGHC reached financial close and advanced the Air Products EPC

The USD 8.4 billion financing and USD 6.7 billion EPC agreements moved the integrated plant and export infrastructure into full execution.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Marine civil completion and Saudi Archirodon handover
  • As-built pile, trestle, loading-platform and dolphin surveys
  • Liquid-ammonia loading-arm and transfer-equipment supplier
  • Fender, bollard, quick-release hook and mooring-system suppliers
  • Firewater, gas detection, ESD and emergency-release integration tests
  • Hydrographic, VTS, navigation-aid and port acceptance
  • Tug, pilot, line-handling and spill-response service awards
  • Tanker compatibility study and named first vessel
  • First refrigerated-ammonia transfer and repeat 2027 exports

Reporting status

Commissioning, confirmed confidence

Last checked 1 August 2026 across 10 cited sources. The dated timeline above carries the project events.

Last checked 1 August 2026 Cited sources 10

Sources and related records

Read featured analysis Methodology Submit a correction Project tracker

Project sources 10
