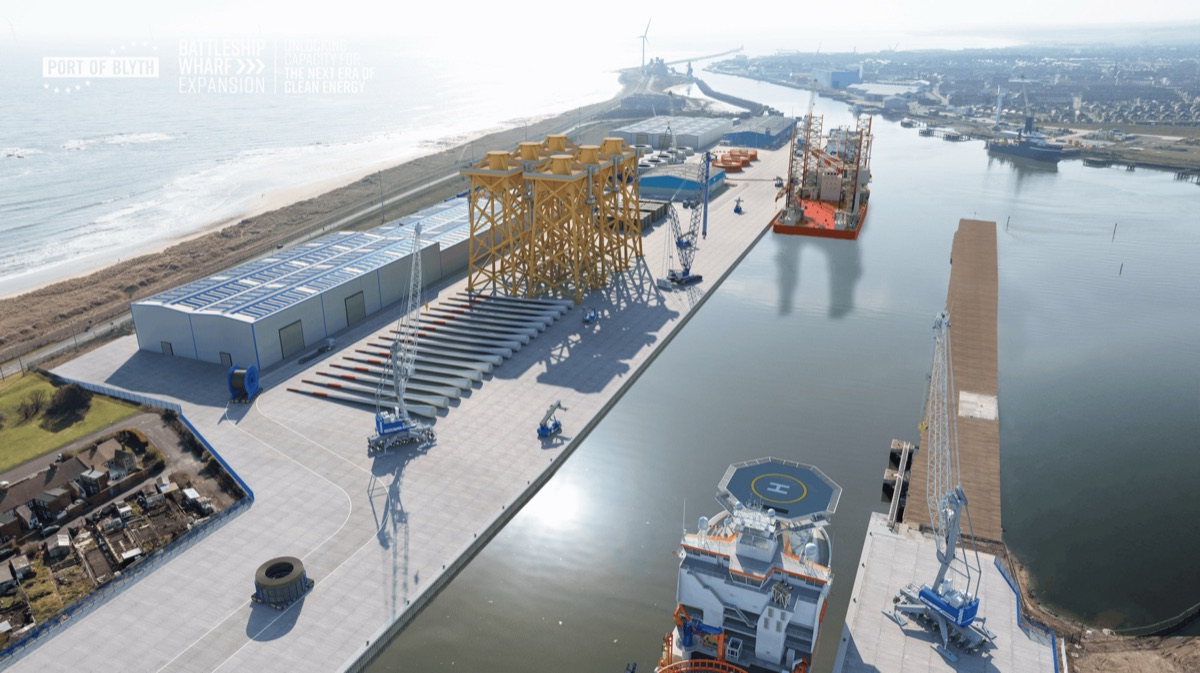

Port of Blyth has launched an expansion of Battleship Wharf valued at up to GBP 100 million. The current scheme describes about three hectares of reclamation, 310 m of quayside and rock revetment, channel and berth deepening and additional heavy-duty handling equipment. A GBP 550,000 enabling study is funded by the port, Northumberland County Council, the North East Combined Authority and The Crown Estate.
Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.
Subject index
Related subjects
These subject pages bring together related projects, technical articles, reports, and evidence methods.
Project anatomy
Contract scope and delivery roles
Client / authority
Port of Blyth / Blyth Harbour Commission
Delivery parties
Early-development providers not publicly named; no main marine-works contractor appointed
Contract route
The early development stage has a GBP 550,000 funding package: GBP 275,000 from The Crown Estate and GBP 91,667 or GBP 91,666 each from the North East Combined Authority, Northumberland County Council and Port of Blyth. No site-investigation, engineering or main marine-works contractor is named in the cited awards. The main capital package remains unawarded.
Execution window
The North East Combined Authority programme placed enabling-study completion in August 2026, with financial completion in January 2027. Port of Blyth says construction timing will follow design and approvals. The port has not set a start date for reclamation, deepening or quay construction.
Works package
Develop approximately three hectares of reclaimed land and about 310 m of quayside and rock revetment at Battleship Wharf. Deepen the River Blyth marine channel and berth area, extend facilities north of berth BW4 and add heavy-duty handling equipment. The enabling scope includes cone-penetration and core investigations, dredge assessment, laboratory testing, reclamation feasibility, preliminary design and market engagement.
Marine interfaces
The scheme must join new quay capacity to a deeper working channel without disturbing the historic contaminated area inside the existing no-dredge zone. The port says the design will contain that zone. Final marine design therefore depends on ground data, dredge limits, material management, reclamation containment, revetment geometry, berth depth, navigation access and the treatment of small-boat berths at 37 Jetty.
Commercial evidence boundary
The live opportunity is still professional and investigative work rather than a confirmed main construction package. Near-term demand can include geotechnical work, hydrography, dredging and material studies, reclamation and quay design, consenting, cost planning and market testing. Larger dredging, reclamation, revetment, quay and equipment packages depend on the business case, approvals and capital decision.
Project timeline
Material developments
Dated events that changed scope, counterparties, delivery, commissioning or operating status.
Port of Blyth presented an up-to-GBP-100-million plan covering reclamation, quay and revetment work, channel and berth deepening and heavy-duty handling equipment. The launch did not announce a main construction award.
The Crown Estate named Blyth in its second funding round
Blyth Harbour Commission was included among the Supply Chain Accelerator recipients, establishing the national match-funding route for early development.
