Buffalo Harbor 2026 dredging and Slip 3 wetland placement

Participation
Not assessed
Project facts checked

USD 2.3 million Ryba contract awarded; July-August 2026 dredging and placement programme announced

Project sources

USACE Buffalo District's 2026 maintenance contract covers approximately 190,000 cubic yards of mechanical dredging from Buffalo Harbor's outer-harbor and Buffalo River federal channels. About 110,000 cubic yards is planned for confined disposal facility #4 and about 80,000 cubic yards for Shipping Slip 3. The Slip 3 breakwater was completed in 2024; this year's placement is one contribution to a 285,000-cubic-yard fill programme expected to continue through 2028 before aquatic habitat works are formed.

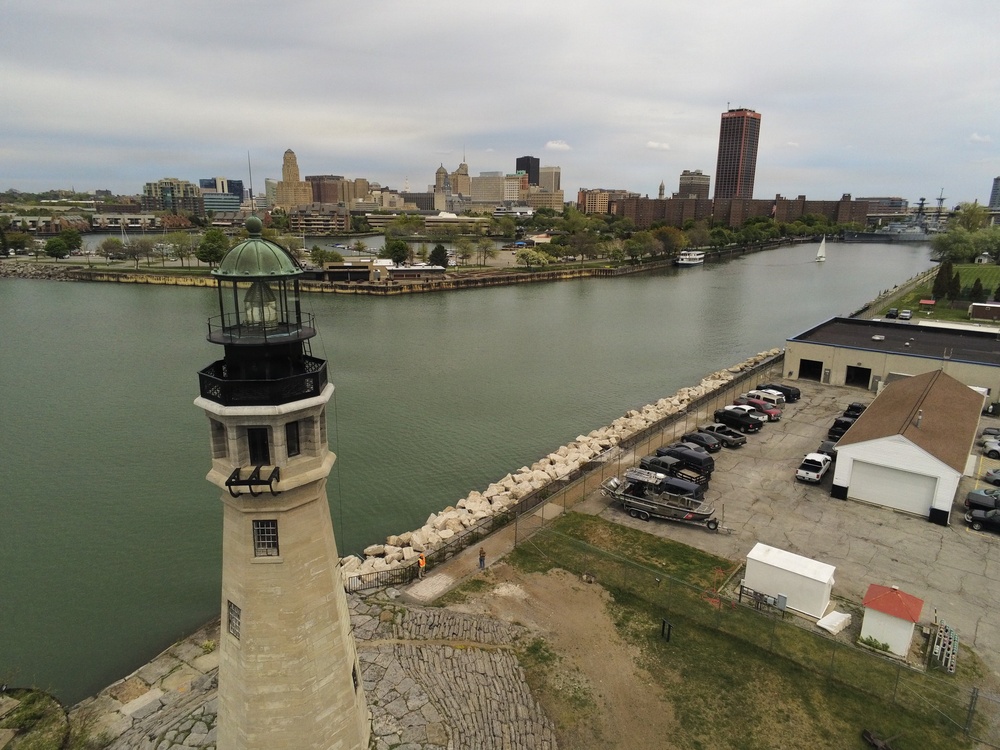

Aerial view across the U.S. Coast Guard Buffalo Station, Buffalo South Pier and Buffalo River in May 2022

U.S. Army photo by USACE Buffalo District

Location

United States / Americas

Segment

Port infrastructure

Phase

Award / Confirmed

Last checked

13 August 2026

Coverage

Related sectors

Port infrastructure is the primary work classification. Related sectors connect this record to adjacent marine delivery and market coverage.

Subject index

Related subjects

These subject pages bring together related projects, technical articles, reports, and evidence methods.

Project anatomy

Contract scope and delivery roles

Client / authority
U.S. Army Corps of Engineers, Buffalo District
Delivery parties
Ryba Marine Construction Co.
Contract route
USD 2.3 million federal maintenance-dredging contract awarded in April 2026
Execution window
Dredging expected to start as early as 18 July 2026; Slip 3 placement estimated for 1-25 August 2026
Works package
Mechanical dredging of approximately 190,000 cubic yards from the outer-harbor and Buffalo River federal channels, with about 110,000 cubic yards routed to CDF #4 and about 80,000 cubic yards routed to Shipping Slip 3
Marine interfaces
A 5.5-mile Buffalo River federal channel and outer-harbor reaches with authorized depths from 22 to 30 feet; mechanical excavation feeds an in-lake confined facility and, separately, a breakwater-contained beneficial-use cell connected to Lake Erie
Commercial evidence boundary
The award fixes contractor, price and planned quantities, but the 17 July notice does not establish mobilisation or output. CDF #4 is a 107-acre federal navigation facility with more than 20 years of capacity reported in 2023; Slip 3 is a separate beneficial-use destination with a defined fill level and later habitat scope. Payment and acceptance evidence should therefore preserve the actual route split rather than relying on one aggregate dredging total.

Project timeline

Material developments

Dated events that changed scope, counterparties, delivery, commissioning or operating status.

Open this project in the Change Log

USACE published the 2026 start plan and two-route material split

The release identifies Ryba, a USD 2.3 million award, approximately 190,000 cubic yards, a start as early as 18 July, and separate CDF #4 and Slip 3 quantities. These are contracted and planned values, not measured field results.

Source

The Outer Harbor wetland entered its staged construction sequence

USACE and Erie Canal Harbor Development Corporation described a 6.7-acre Slip 3 wetland requiring approximately 285,000 cubic yards over an estimated three dredging cycles, followed by planting and habitat features. That programme baseline does not establish current fill or ecological performance.

Source

A prior Buffalo campaign set a historical Ryba baseline

USACE awarded Ryba a separate USD 991,500 contract for approximately 80,000 cubic yards routed to the harbor CDF. That earlier contract shows recurring two-year maintenance but is not evidence of 2026 production.

Source

Evidence gap

What remains unverified

Outstanding evidence

  • Ryba plant mobilisation and the actual first day of dredging
  • Measured excavation by outer-harbor and Buffalo River reach
  • Actual receipts at CDF #4 and Shipping Slip 3
  • Sediment test results and placement approvals
  • Post-dredge surveys against the 22-to-30-foot authorized-depth range
  • Slip 3 fill elevation and cumulative progress toward 285,000 cubic yards
  • Native planting, habitat-feature installation and ecological monitoring after fill placement

Reporting status

Project phase
Award
Evidence confidence
Confirmed
Last checked
13 August 2026
Cited sources
6
